FM 4-20.137 RIGGING FORWARD AREA REFUELING EQUIPMENT (FARE) AND ADVANCED AVIATION FORWARD AREA REFUELING SYSTEM (AAFARS, JUNE 2003) - page 8

  Главная      Manuals     FM 4-20.137 RIGGING FORWARD AREA REFUELING EQUIPMENT (FARE) AND ADVANCED AVIATION FORWARD AREA REFUELING SYSTEM (AAFARS, JUNE 2003)

Search            copyright infringement

Content      ..     6      7      8      9     ..

FM 4-20.137 RIGGING FORWARD AREA REFUELING EQUIPMENT (FARE) AND ADVANCED AVIATION FORWARD AREA REFUELING SYSTEM (AAFARS, JUNE 2003) - page 8

FM 4-20.137/TO 13C7-1-19
6
6

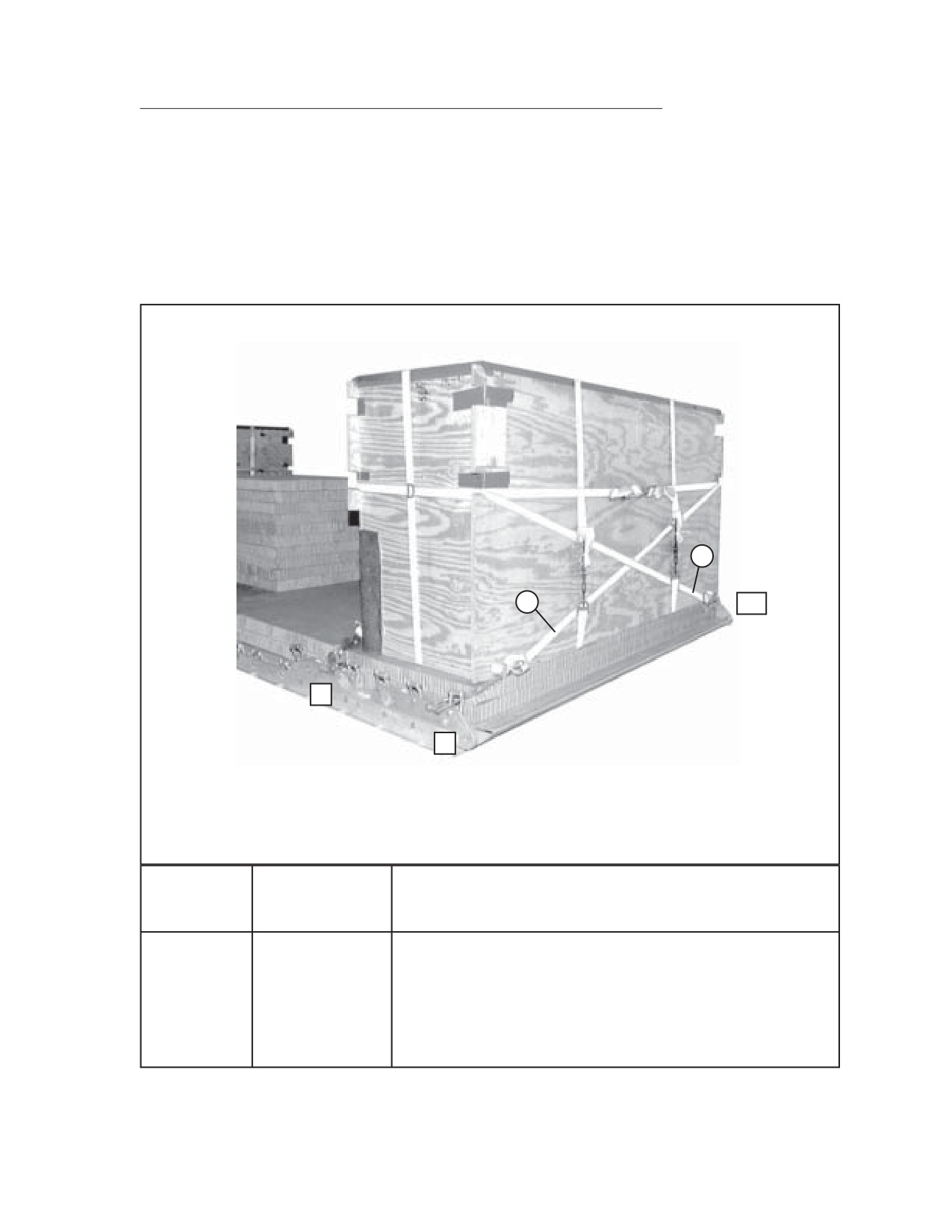

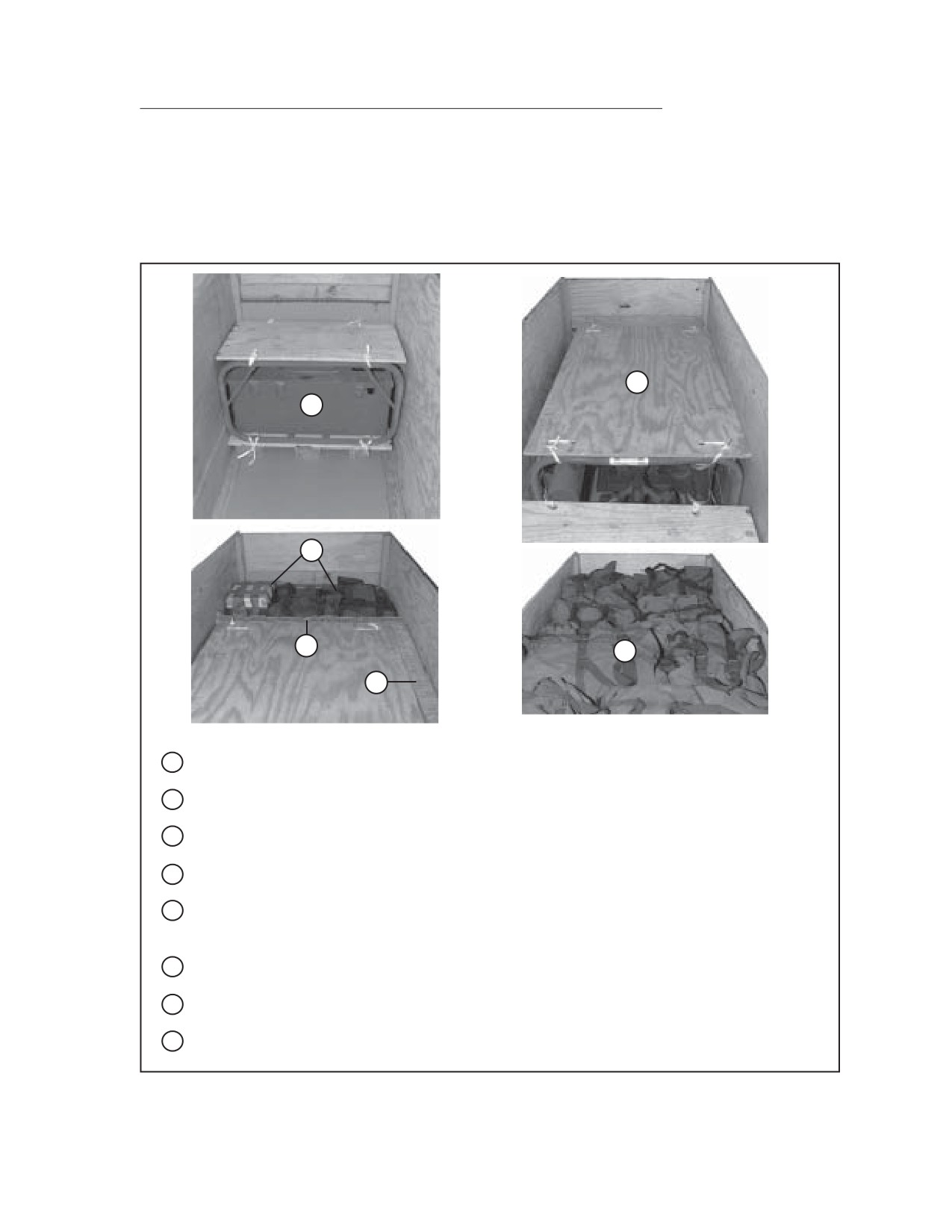

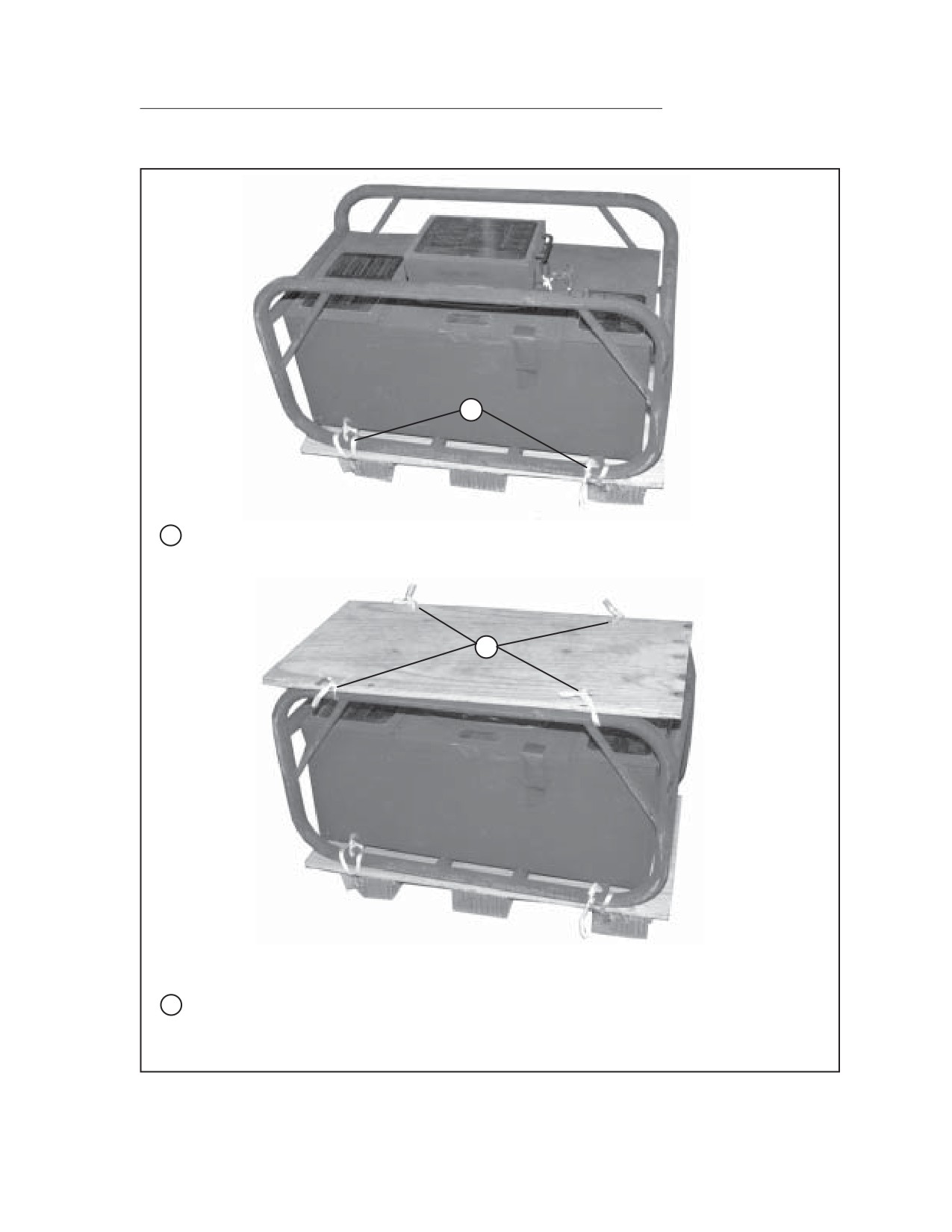

Place the battery box on the base plywood and secure with 1/2-inch tubular nylon webbing
around the rails.
7
7
Place the plywood top on the battery box and secure it with 1/2-inch tubular nylon webbing
around the rails.
Figure 4-11. Battery Box Secured (Continued)
4-17
FM 4-20.137/TO 13C7-1-19

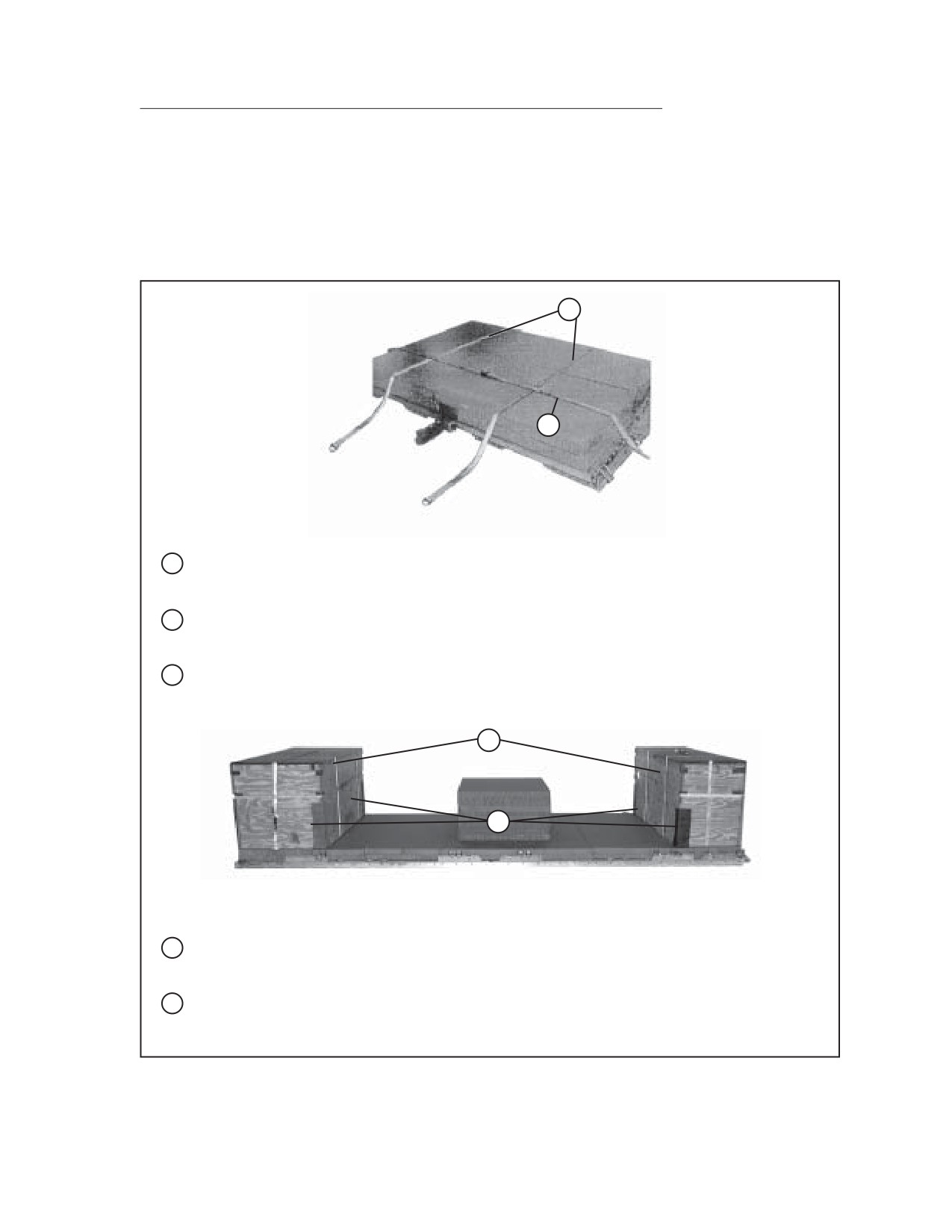

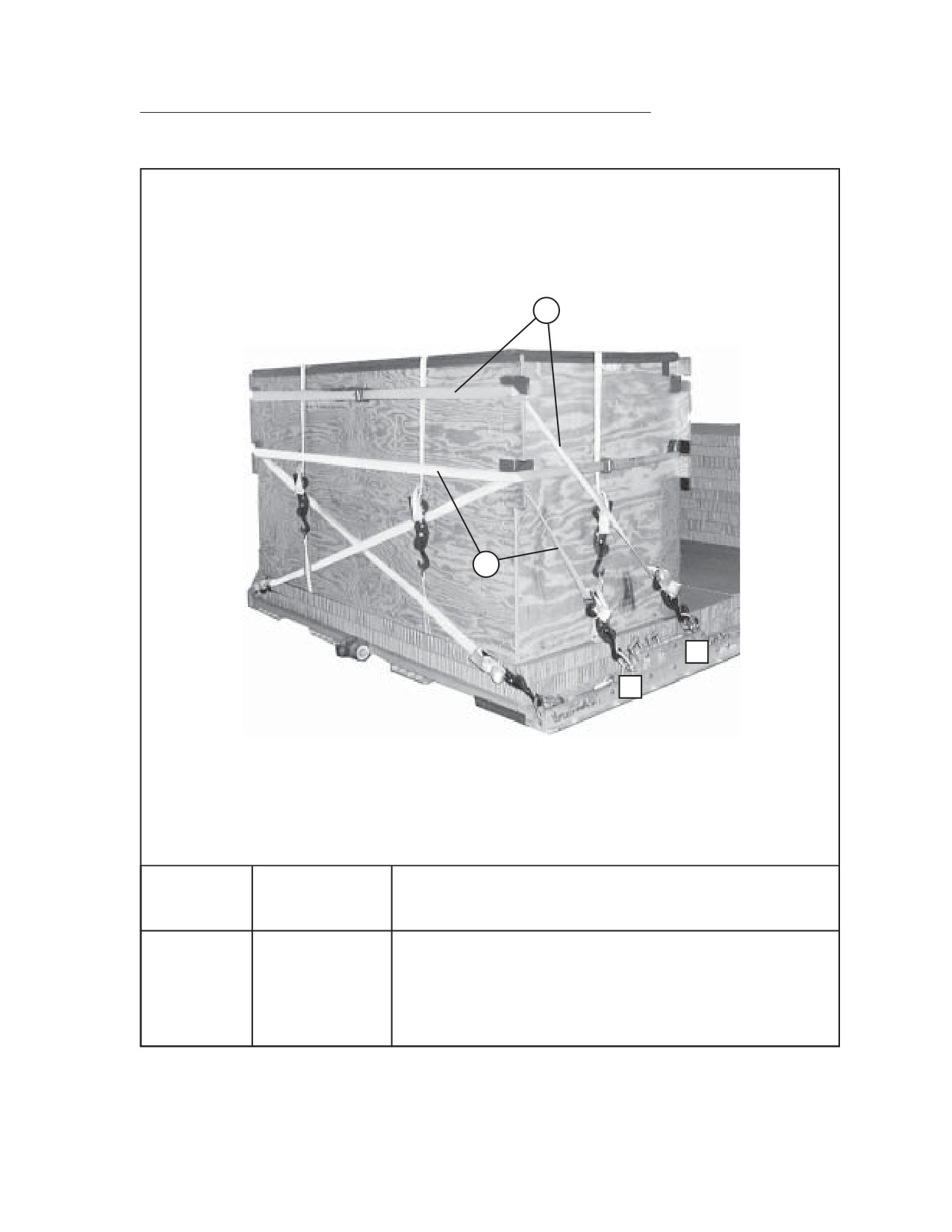

g. Prepare and secure the manuals and toolkit as shown in Figure 4-12.
1
Secure the manuals and toolkit together using cloth-backed tape.

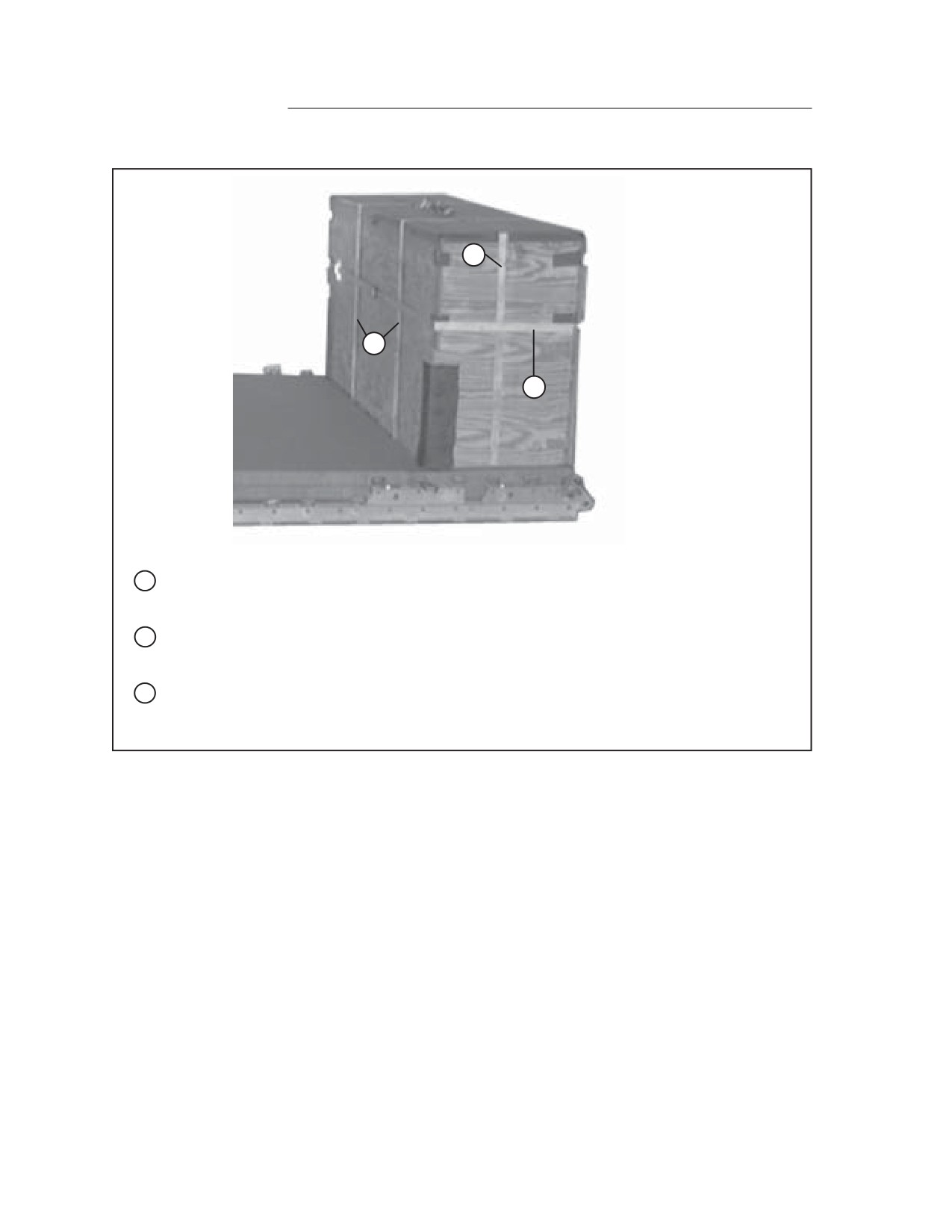

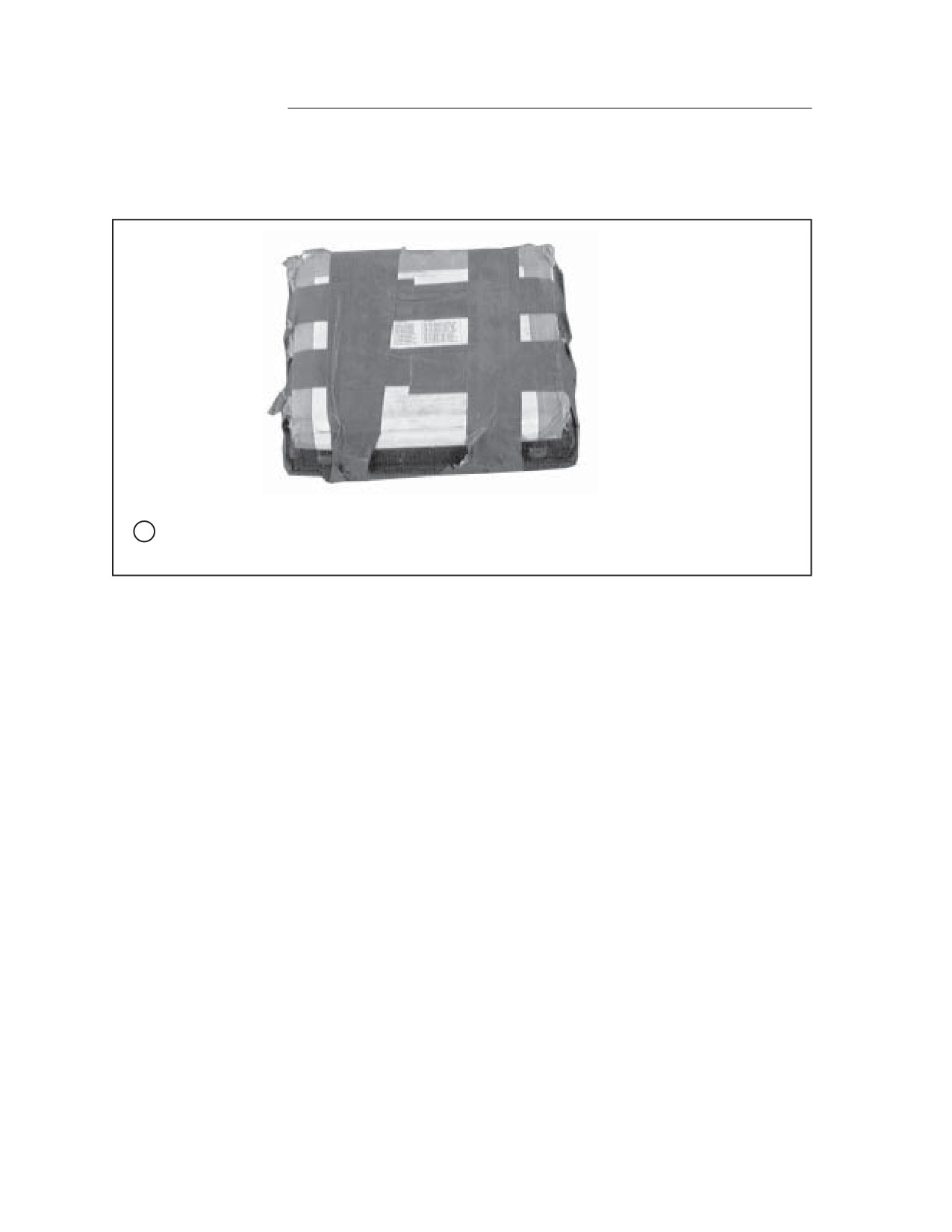

Figure 4-12. Manuals and Toolkit Secured
4-18
FM 4-20.137/TO 13C7-1-19
POSITIONING EQUIPMENT BOXES
4-7. Position the front and rear equipment boxes on the platform as shown in
Figure 4-13.
1
2
REAR
1
Pre-position two 15-foot lashings lengthwise across the end honeycomb stacks on each end
of platform 16-inches from the outside edges (rear edge shown).
2
Pre-position a 30-foot lashing across the width of the rear honeycomb stack 21 inches in
from the rear honeycomb edge.
3
Position a 30-foot lashing across the width of the front honeycomb stack 15 inches in from
the front honeycomb edge (not shown).
4
REAR
5
FRONT
4
Position the front and rear equipment boxes on the edges of the front and rear edges of the
honeycomb stacks.
5
Attach four 1/2-inch by 10-inch by 25-inch pieces of felt on the two bottom inboard corners
of the boxes as shown above.
Figure 4-13. Equipment Boxes Positioned
4-19
FM 4-20.137/TO 13C7-1-19
POSITIONING AND SECURING EQUIPMENT IN EQUIPMENT BOXES
4-8. Position and secure equipment in equipment boxes as shown in Figures 4-
14 and 4-15.
a. Prepare the front equipment box by placing a 22-inch by 82-inch piece of
honeycomb in the floor of the box and a 23-inch by 35-inch piece of honey-
comb against each end of box below the 2 x 4 lumber. Position equipment
in front equipment box as shown in Figure 4-14.

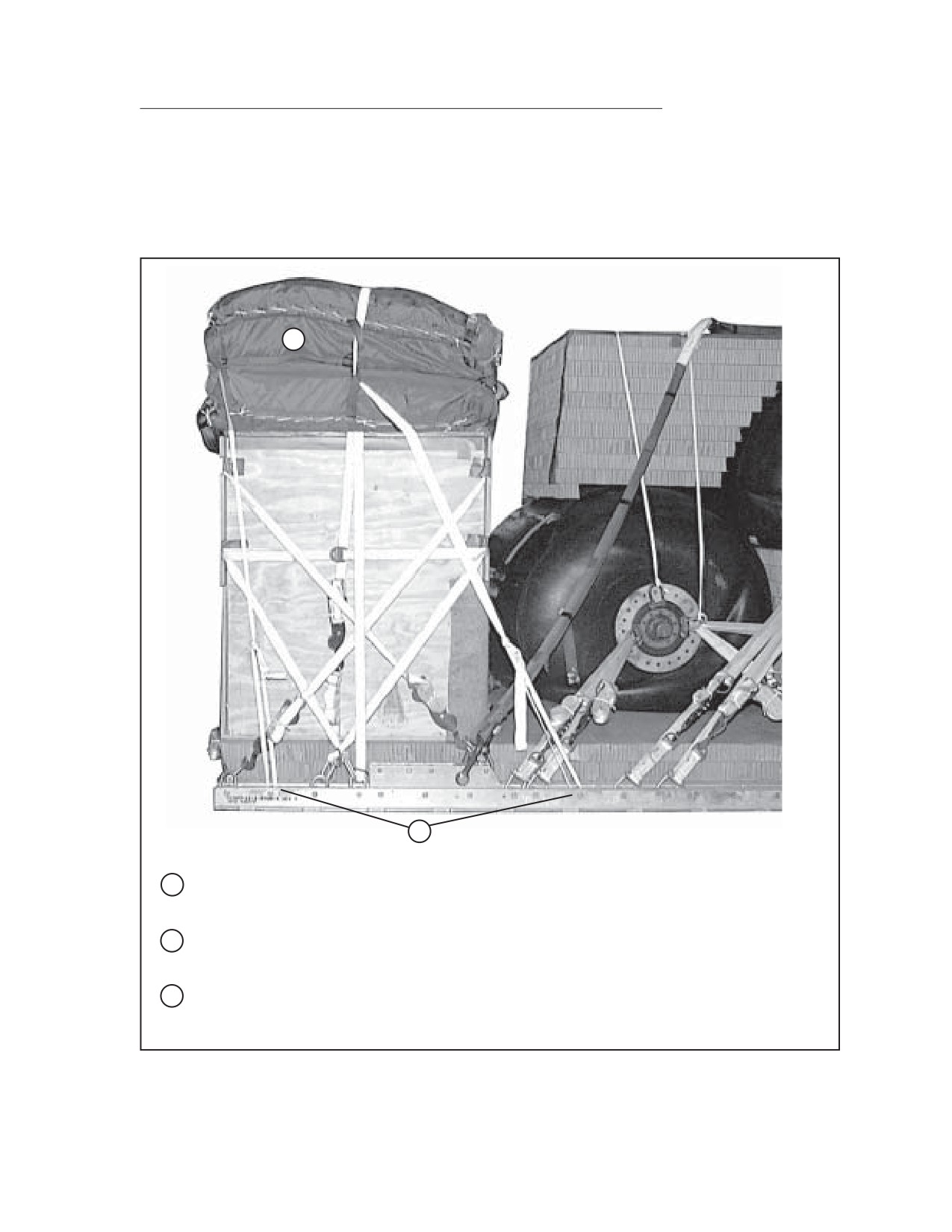

RIGHT
1
REAR
FRONT
3
2
LEFT
1
Place the fire extinguishers in the right side of the box with the three extinguishers sides
toward the inside.
2
Place the filter separator in the front left side of the box.
3
Place a 3/4-inch by 28 1/4-inch by 55-inch piece of plywood against the rear of the filter
separator.

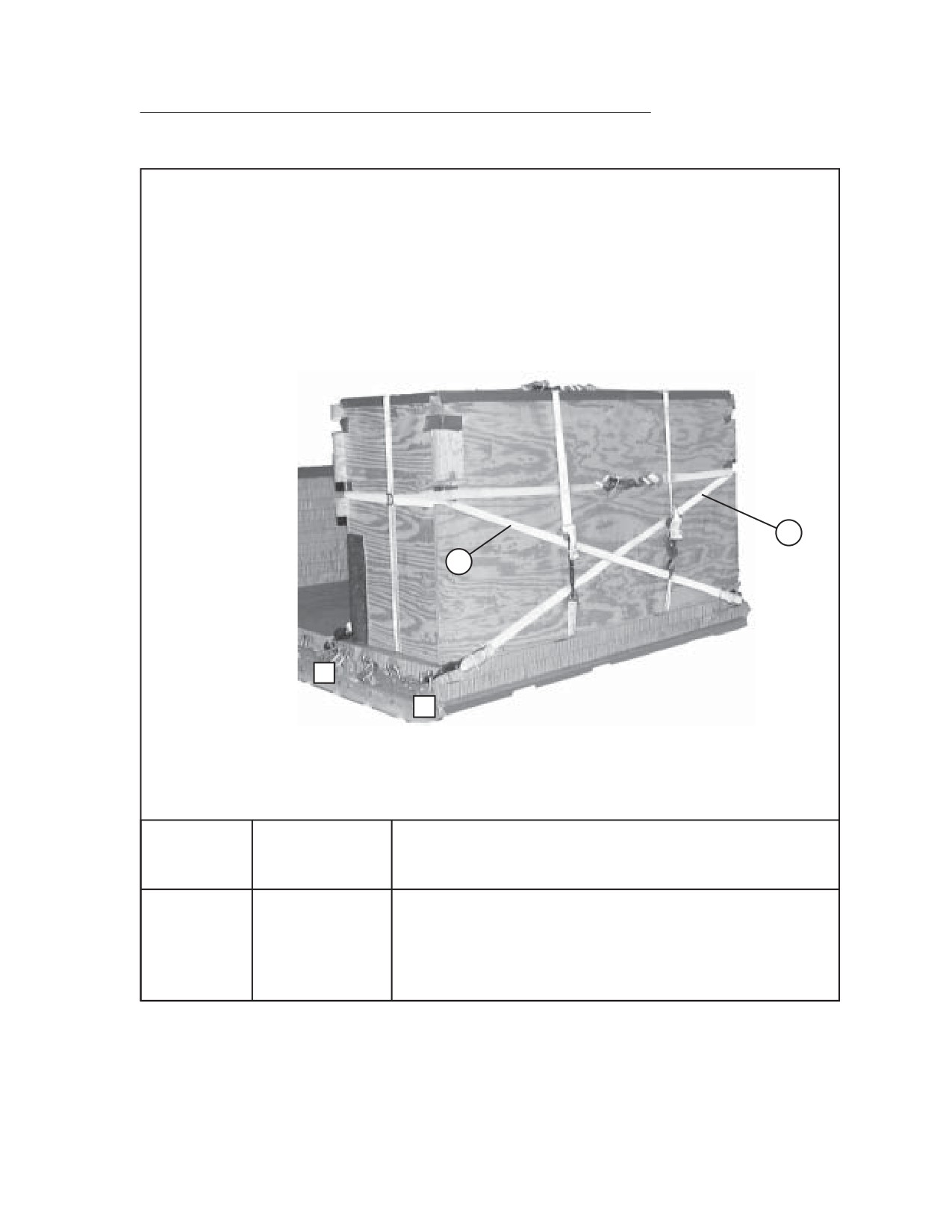

Figure 4-14. Equipment Positioned and Secured in Front Box
4-20
FM 4-20.137/TO 13C7-1-19

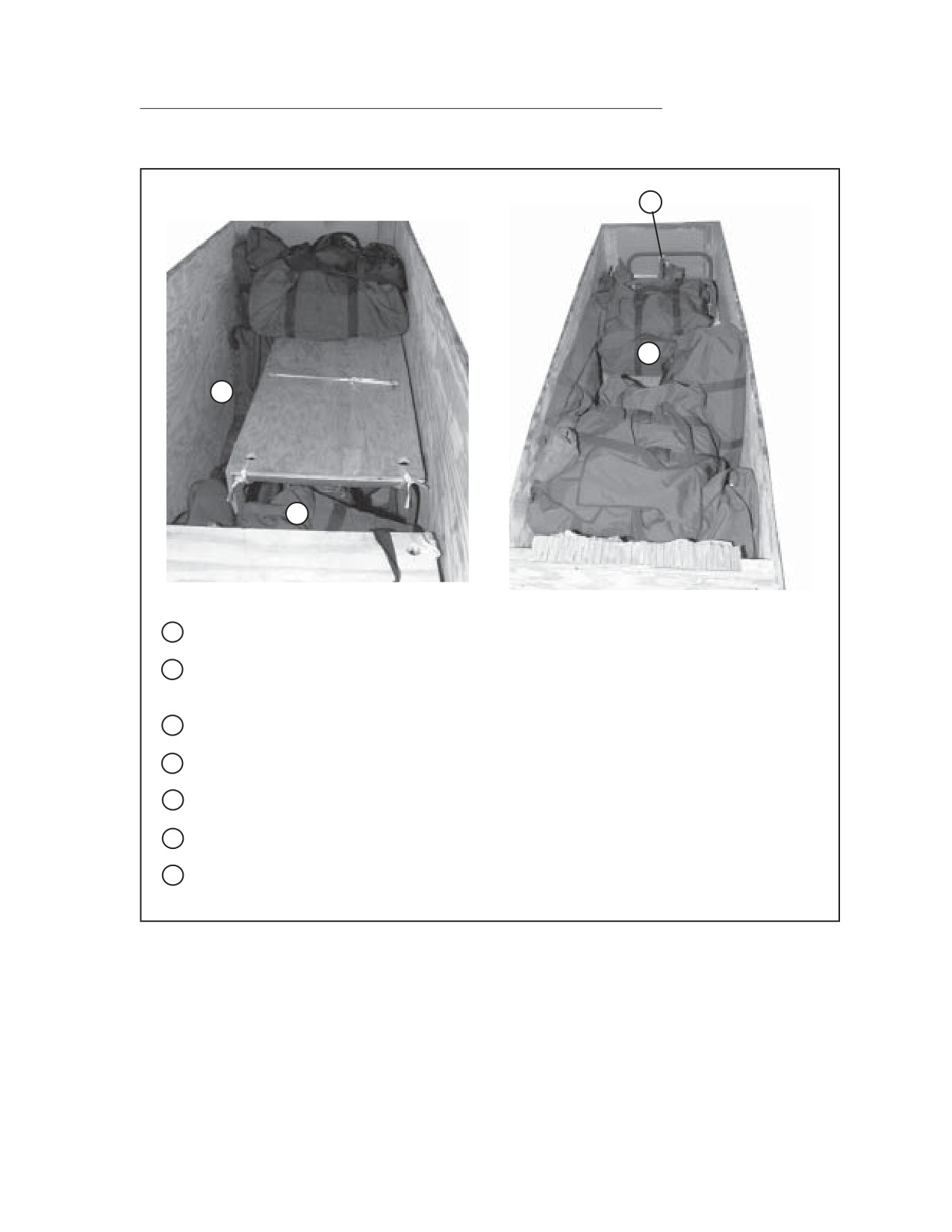

6
7
4
5
4
Place the suction hose bags in the space to the rear of the filter separator.
5
Place a bag containing one 50-foot by 3-inch and one 6-foot by 3-inch discharge hoses
between the filter separator and fire extinguishers.
6
Place the explosion-proof motor on top of the fire extinguishers.
7
Place the remaining hose bags to the rear and on top of the filter separator.
8
Place the ground rods on top of the hose bags (not shown).
9
Fill in remaining space with honeycomb to prevent movement (not shown).
10
Nail the top on box (not shown).
Figure 4-14. Equipment Positioned and Secured in Front Box (Continued)
4-21
FM 4-20.137/TO 13C7-1-19
12
11
13
FRONT
11
Secure the box from front to rear using the two pre-positioned 15-foot lashings. Load
bind at front of the box.
12
Secure the box from left to right using the pre-positioned 30-foot lashing. Load bind on
top of the box.
13
Route a 30-foot lashing around the box using the bottom cutouts. Load bind on the front of
the box.
Figure 4-14. Equipment Positioned and Secured in Front Box (Continued)
4-22
FM 4-20.137/TO 13C7-1-19
b. Prepare the rear equipment box by placing a 34-inch by 82-inch piece of
honeycomb in the floor of the box and a 37 1/2-inch by 35-inch piece of
honeycomb against each end of box below the 2 x 4 lumber. Position equip-
ment in front equipment box as shown in Figure 4-15.

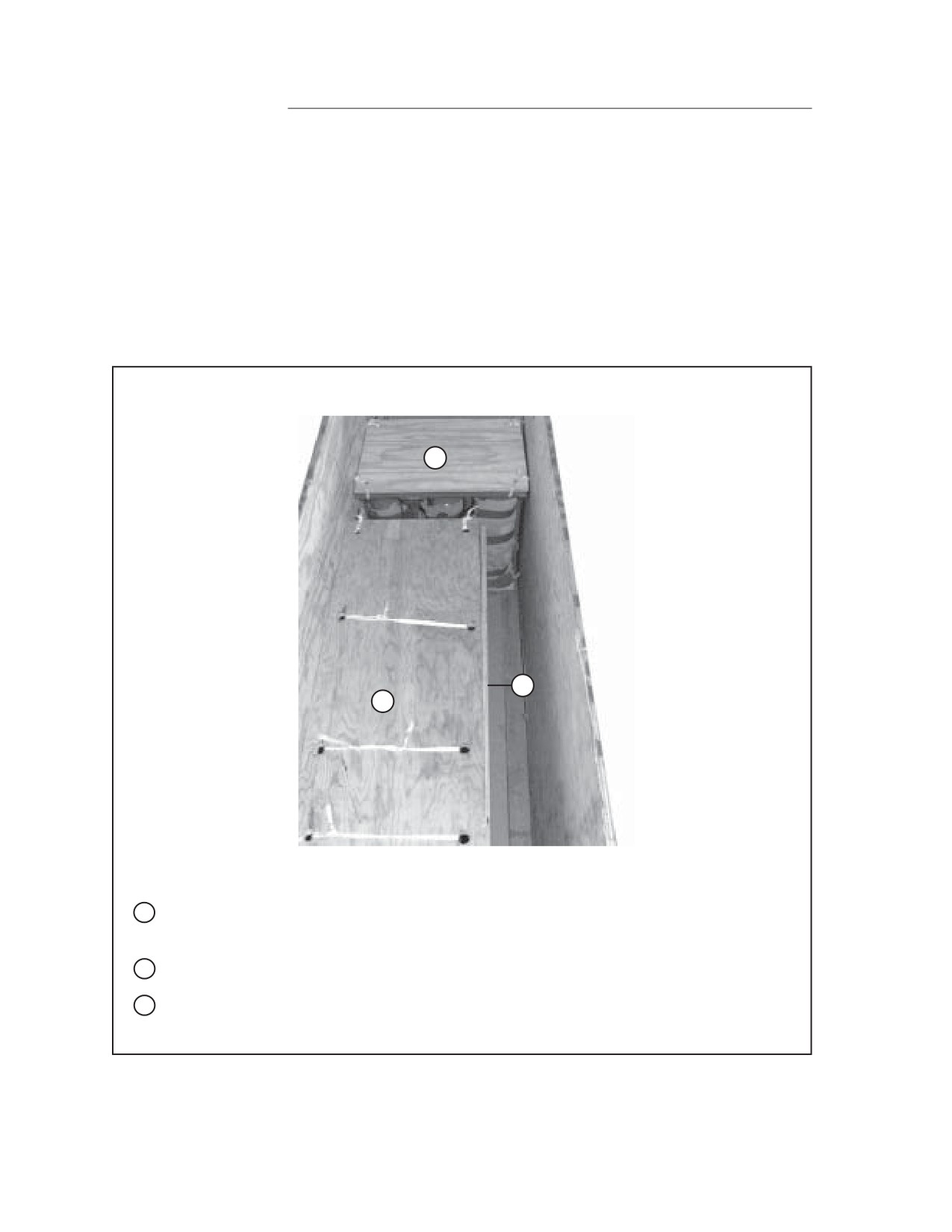

2
1
5
4
6
3
1
Place the battery box in the left side of the box.
2
Place the pump in the right front side of the box.
3
Place a 34-inch by 56-inch piece of honeycomb against the rear pump.
4
Place a 34-inch by 38-inch piece of honeycomb between the pump and the battery box.
5
Place the manuals/toolkit and two bags containing three nozzles each on top of the battery
box.
6
Place the remaining bags on top.
7
Place a 36-inch by 90-inch piece of honeycomb on top to prevent movement (not shown).
8
Nail the top on the box (not shown).

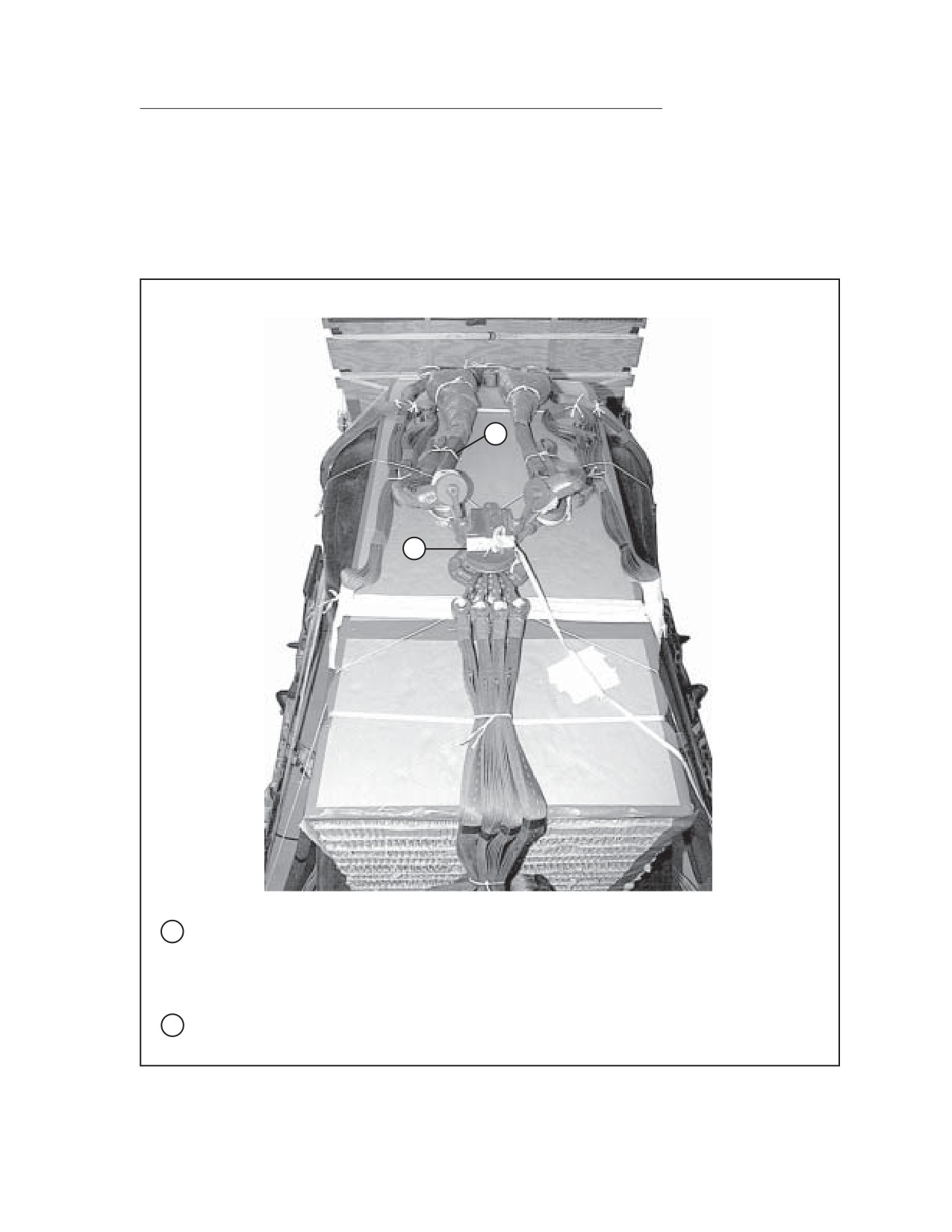

Figure 4-15. Equipment Positioned and Secured in Rear Box
4-23
FM 4-20.137/TO 13C7-1-19
11
9
10
REAR
9
Secure the box from front to rear using the two pre-positioned 15-foot lashings. Load
bind at rear of the box.
10
Secure the box from left to right using the pre-positioned 30-foot lashing. Load bind on
side of the box.
11
Route a 30-foot lashing around the box using the bottom cutouts. Load bind on the front of
the box.
Figure 4-15. Equipment Positioned and Secured in Rear Box (Continued)
4-24
FM 4-20.137/TO 13C7-1-19
LASHING THE EQUIPMENT BOXES TO THE PLATFORM
4-9. Lash the equipment boxes as shown in Figures 4-16 through 4-21.
a. Lash the front equipment box to the platform as shown in Figures 4-16
through 4-18.
2
1
1A
6
FRONT
1
Tie-dow n
Lashing
Clevis
Instruction s
Number
Number
1
1 and
6
Route a 30-foot lashing from clevis 1to the front bottom left
cutout, to the rear bottom left cutout, to clevis
6
2
1A and 6A
Route a 30-foot lashing from clevis 1A to the front bottom right
cutout, to the rear bottom right cutout, to clevis 6A

Figure 4-16. Lashings 1 and 2 Installed
4-25
FM 4-20.137/TO 13C7-1-19
3
4
FRONT
2
3
Lashing
Tie-dow n
Instruction s
Number
Clevis
Number
3
2 and 2A
Route a 30-foot lashing through it's own D-ring on clevis 2
t
the rear top right cutout, to the rear top left cutout, to clevis 2A
4
3 and 3A
Route a lashing through it's own D-ring on clevis 3 to
t
bottom left cutout, to the rear bottom right cutout, to clevis 3A
Figure 4-17. Lashings 3 and 4 Installed
4-26
FM 4-20.137/TO 13C7-1-19
6
7
5
7
5
FRONT
4
Lashing
Tie-dow n
Instruction s
Number
Clevis
Number
5
5 and 5A
Route a lashing through it's own D-ring on clevis 5 to the front
bottom right cutout, to the front bottom left cutout, to clevis 5A
6
7 and 7A
Route a 30-foot lashing from clevis 7 to the front top right
cutout, to the front top left cutout, to clevis 7A
7
4 and 4A
Route a lashing through it's own D-ring on clevis 4, repeat on
clevis 4A and load bind them together on top of the box.

Figure 4-18. Lashings 5 through 7 Installed
4-27
FM 4-20.137/TO 13C7-1-19
b. Lash the rear equipment box to the platform as shown in Figures 4-19
through 4-21.

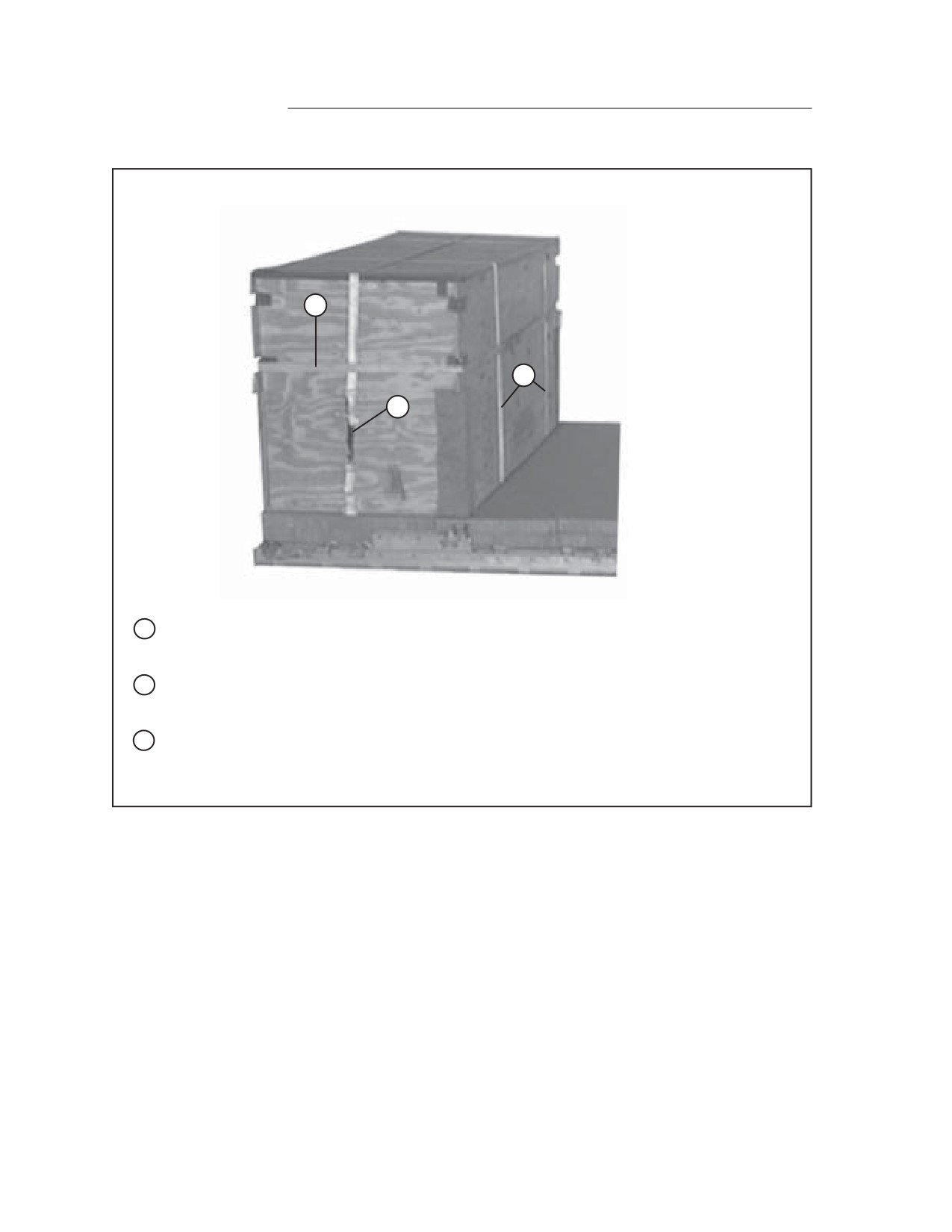

9
26A
8
20
REAR
26
Lashing
Tie-dow n
Instruction s
Number
Clevis
Number
8
20 and
26
Route a 30-foot lashing from clevis 20 to the front lower left
cutout, to the rear lower left cutout, to clevis 26
9
20A and 26A
Route a 30-foot lashing from clevis 20A to the front lower right
cutout, to the rear lower right cutout, to clevis 26A
Figure 4-19. Lashings 8 and 9 Installed
4-28
FM 4-20.137/TO 13C7-1-19
10
11
21
REAR
23
Lashing
Tie-dow n
Instruction s
Number
Clevis
Number
10
21 and 21A
Route a 30-foot lashing from clevis 21 to the rear top right
cutout, to the rear top left cutout, to clevis 21A
11
23 and 23A
Route a lashing through it's own D-ring on clevis 23 to the
rear bottom right cutout, to the rear bottom left cutout to clevis
23A
Figure 4-20. Lashings 10 and 11 Installed
4-29
FM 4-20.137/TO 13C7-1-19
12
13
14
27
25
22
Lashing
Tie-dow n
Instruction s
Number
Clevis
Number
12
27 and 27A
Route a 30-foot lashing from clevis 27 to the front top cutouts,
to clevis 27A
13
25 and 25A
Route a lashing through it's own D-ring on clevis 25 to the
front bottom right cutout, to the front bottom left cutout to clevis
25A
14
22 and 22A
Route a lashing through it's own D-ring on clevis 22, repeat on
clevis 22A and load bind on the left side of the box.
Figure 4-21. Lashings 12 Through 14 Installed
4-30
FM 4-20.137/TO 13C7-1-19
POSITIONING AND LASHING THE DRUMS
4-10. Position and lash the fuel drums to the platform as shown in Figures 4-22
through 4-29.

DRUM 2
DRUM 1
STACK 8
3
2
REAR
FRONT
1
Place a platform clevis on one end of two 9-foot (2-loop), type XXVI nylon webbing slings.
Attach a sling to each side of the drum (for lifting purposes only) and remove after the
drum is positioned (not shown).
2
Position drum 1 in front of and against stack 8 and centered on the platform.
3
Position drum 2 to the rear of and against stack 8 and centered on the platform.
NOTE: There should be a 3 inch to 4 inch gap between the drums and the
equipment boxes.

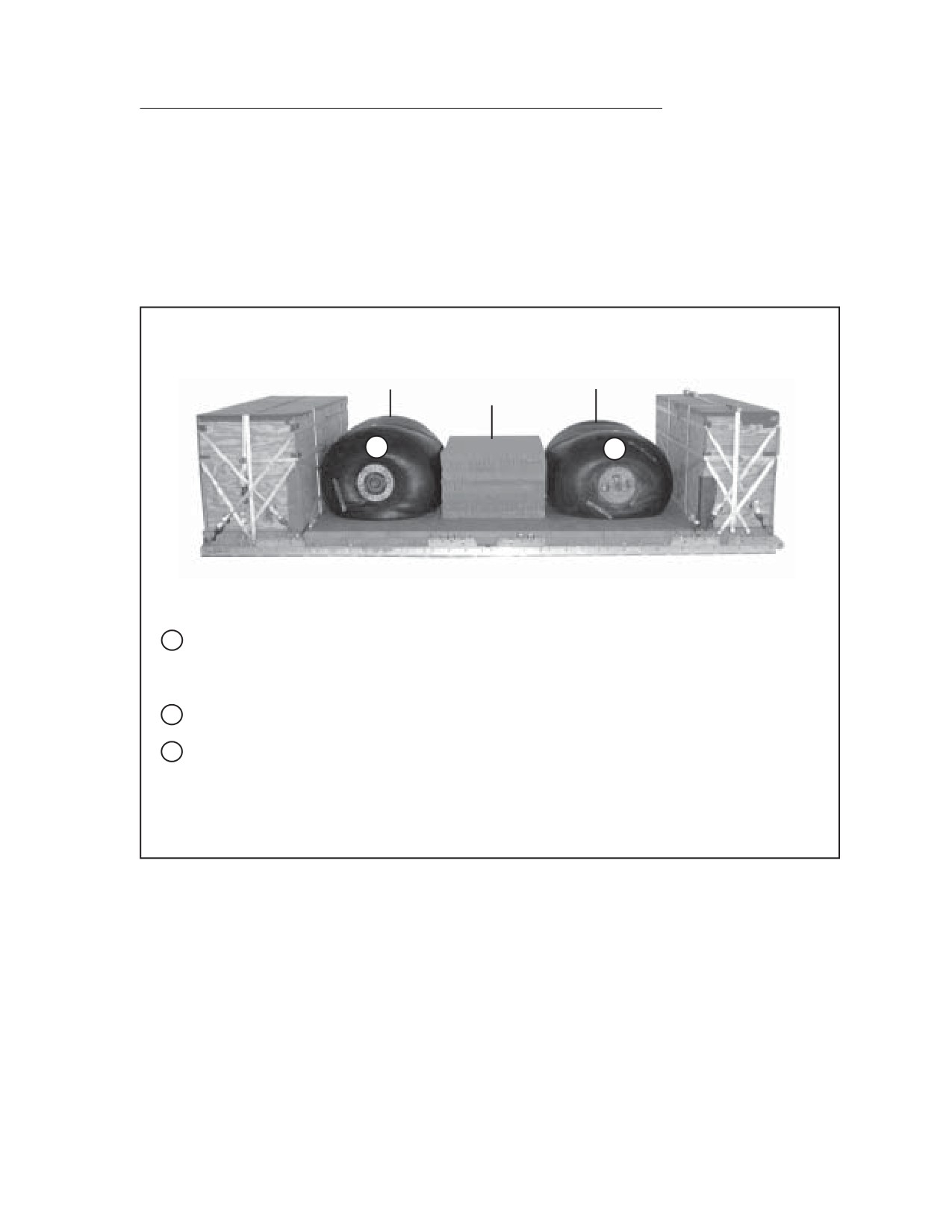

Figure 4-22. Fuel Drums 1 and 2 Positioned
4-31
FM 4-20.137/TO 13C7-1-19

15
17
19
REAR
FRONT
8
9
Lashing
Tie-dow n
Instruction s
Number
Clevis
Number
15
Route a lashing from the rear shackle of drum 1 to the front
shackle of drum 2 on the right side.
16
Route a lashing from the rear shackle of drum 1 to the front
shackle of drum 2 on the left side.
17
8
Route a lashing from clevis 8 to the front right shackle on
drum
1
18
8A
Route a lashing from clevis 8A to the front left shackle on
drum
1
19
9
Route a lashing from clevis 9 to the front right shackle of drum
1.
20
9A
Route a lashing from clevis 9A to the left front shackle of drum
1.
Figure 4-23. Lashings 15 through 20 Installed
4-32
FM 4-20.137/TO 13C7-1-19
21
23
REAR
FRONT
13
12
Tie-dow n
Lashing
Clevis
Instruction s
Number
Number
21
13
Route a lashing from clevis 13 to the rear right shackle on
drum
1
22
13A
Route a lashing from clevis 13A to the rear left shackle on
drum
1
23
12
Route a lashing from clevis 12 to the rear right shackle on
drum
1
24
12A
Route a lashing from clevis 12A to the rear left shackle on
drum
1
Figure 4-24. Lashings 21 through 24 Installed
4-33
FM 4-20.137/TO 13C7-1-19
27
25
REAR
FRONT
15
14
Tie-dow n
Lashing
Clevis
Instruction s
Number
Number
25
14
Route a lashing from clevis 14 to the front right shackle on
drum
2
26
14A
Route a lashing from clevis 14A to the front left shackle on
drum
2
27
15
Route a lashing from clevis 15 to the front right shackle on
drum
2
28
15A
Route a lashing from clevis 15A to the front left shackle on
drum
2

Figure 4-25. Lashings 25 through 28 Installed
4-34
FM 4-20.137/TO 13C7-1-19
29
31
REAR
FRONT
19
18
Tie-dow n
Lashing
Clevis
Instruction s
Number
Number
29
19
Route a lashing from clevis 19 to the rear right shackle on
drum
2
30
19A
Route a lashing from clevis 19A to the rear left shackle on
drum
2
31
18
Route a lashing from clevis 18 to the rear right shackle on
drum
2
32
18A
Route a lashing from clevis 18A to the rear left shackle on
drum
2

Figure 4-26. Lashings 29 through 32 Installed
4-35
FM 4-20.137/TO 13C7-1-19

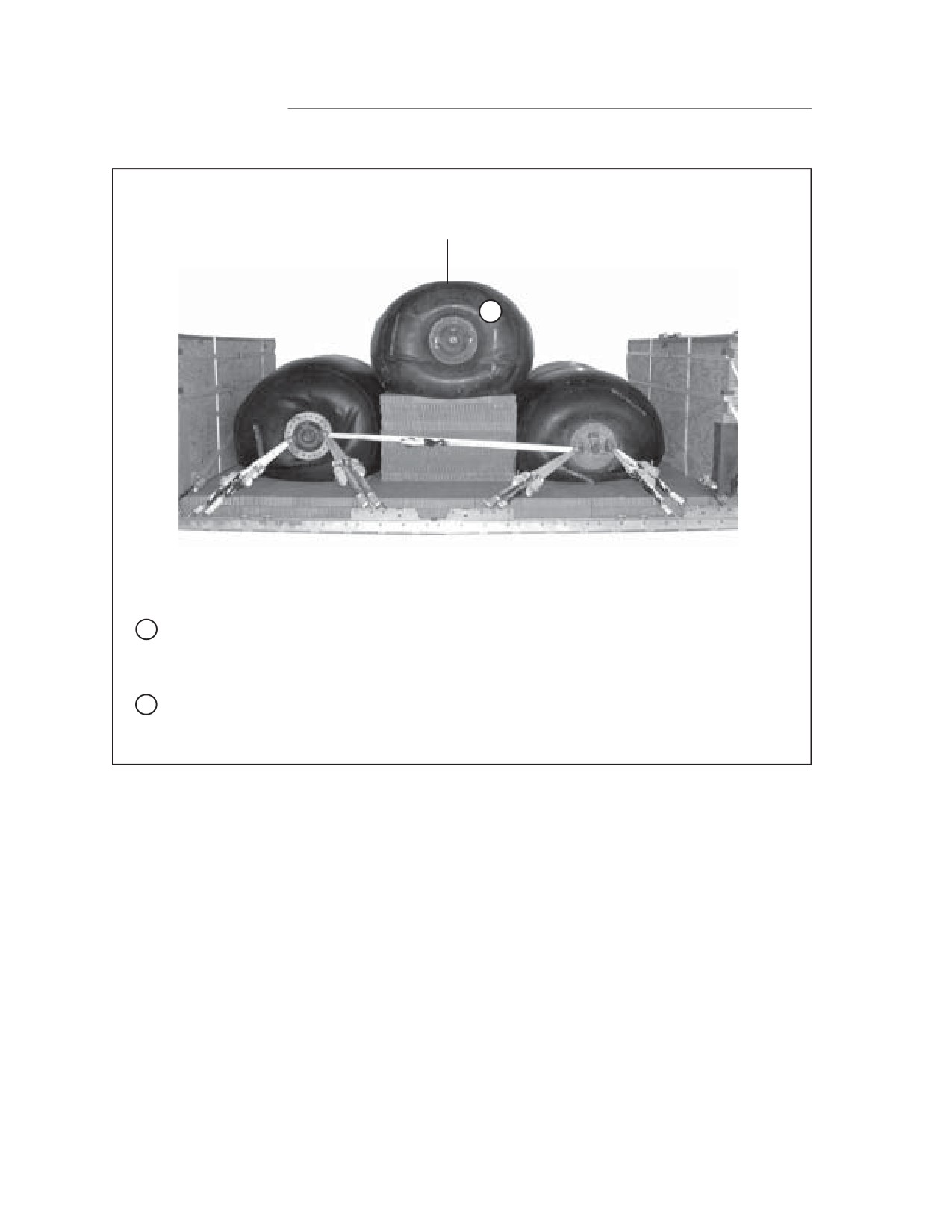

DRUM 3
2
STACK 8
REAR
FRONT
1
Place a platform clevis on one end of two 9-foot (2-loop), type XXVI nylon webbing slings.
Attach a sling to each side of the drum (for lifting purposes only) and remove after the
drum is positioned (not shown).
2
Position drum 3 centered on stack 8.
Figure 4-27. Fuel Drum 3 Positioned
4-36
FM 4-20.137/TO 13C7-1-19
33
35
REAR
FRONT
11
10
Tie-dow n
Lashing
Clevis
Instruction s
Number
Number
33
10
Route a lashing from clevis 10 to the front right shackle on
drum
3
34
10A
Route a lashing from clevis 10A to the front left shackle on
drum
3
35
11
Route a lashing from clevis 11 to the front right shackle on
drum
3
36
11A
Route a lashing from clevis 11A to the front left shackle on
drum
3
Figure 4-28. Lashings 33 through 36 Installed
4-37
FM 4-20.137/TO 13C7-1-19
37
39
REAR
FRONT
17
16
Tie-dow n
Lashing
Clevis
Instruction s
Number
Number
37
17
Route a lashing from clevis 17 to the rear right shackle on
drum
3
38
17A
Route a lashing from clevis 17A to the rear left shackle on
drum
3
39
16
Route a lashing from clevis 16 to the rear right shackle on
drum
3
40
16A
Route a lashing from clevis 16A to the rear left shackle on
drum
3
Figure 4-29. Lashings 37 through 40 Installed
4-38
FM 4-20.137/TO 13C7-1-19
BUILDING AND POSITIONING RELEASE PLATFORM
4-11. Build and position the release platform as shown in Figure 4-30.
LAYER 1
NOTE: Drawing not to scale
21”
51 1/2”
LAYER 2
46”
42”
1
39”
37 1/2”
36”
RELEASE PLATFORM
35”
33 1/2”
32 1/2”
4”
3
2
4
1
Build the release platform as shown above with all lengths 36 inches wide.
2
Place the release stack on top of drum 2 and against drum 3, centered.
3
Place a 36-inch by 96-inch piece of honeycomb on top of layer 2 and against layer 1.
Shape it around drum 3. Tape the top edges where the honeycomb fits together.
4
Secure the release stack with 1/2-inch tubular nylon webbing to the drum shackles.
Figure 4-30. Release Platform Built and Positioned
4-39
FM 4-20.137/TO 13C7-1-19
INSTALLING SUSPENSION SLINGS AND SAFETY TIES
4-12. Install suspension slings and safety ties as shown in Figure 4-31.
4
3
5
1
2
6
1
Place a large clevis in one end of a 16-foot (4-loop), type XXVI nylon suspension sling. Attach
the clevis to the right rear suspension bracket.
2
Place two large clevises on one end of a 12-foot (4-loop), type XXVI nylon suspension sling.
Attach the clevis to the right front supension bracket.
3
Attach the running end of the 12-foot sling to a 3-point link.
4
Place a 3-foot (4-loop), type XXVI nylon suspension sling on the 3-point link.
5
Place one end of a 20-foot (4-loop), type XXVI nylon suspension sling on a 3-foot (4-loop),
type XXVI nylon suspension sling. Route the running end of the 20-foot sling through the
remaining point on the 3-point link and place it on the 3-foot sling.
6
Attach large clevises to each running end of the 3-foot sling and attach the clevises to the
right center suspension brackets.
7
Repeat steps 1 through 6 for the left side (not shown).
8
Raise the suspension slings and install the suspension sling safety ties to the front and rear
suspension slings using doubled 1/2-inch tubular nylon webbing six to eight inches above
the highest point of the load (not shown). Refer to the Notice of Exception in the Introduc-
tion of this manual.
9
Pad and tape the link assemblies (not shown).
Figure 4-31. Suspension Slings and Safety Ties Installed
4-40
FM 4-20.137/TO 13C7-1-19
PREPARING AND STOWING CARGO PARACHUTES
4-13. Prepare and stow four G-11 cargo parachutes as shown in Figure 4-32.
1
2
1
Prepare and stow four G-11 cargo parachutes on the rear equipment box according to
FM 4-20.102/NAVSEA SS400-AB-MMO-010/TO 13C7-1-5.
2
Restrain the parachutes according to FM 4-20.102/NAVSEA SS400-AB-MMO-010/TO
13C7-1-5 using bushings 31,31A,39, and 39A on the platform.
3
Install the multicut parachute release strap according to FM 4-20.102/NAVSEA SS400-
AB- MMO-010/TO 13C-1-5 (not shown).
Figure 4-32. Cargo Parachutes Prepared and Stowed
4-41
FM 4-20.137/TO 13C7-1-19
INSTALLING THE EXTRACTION SYSTEM
4-14. Install the extraction system as shown in Figure 4-33.
1
2
3
1
Using the rear holes, install the extraction force transfer coupling (EFTC) according to FM
4-20.102/NAVSEA SS400-AB-MMO-010/TO 13C7-1-5.
2
Using a 24-foot EFTC cable, safety the cable using one turn type I, 1/4-inch cotton webbing.
3
Attach a 9-foot (2-loop), type XXVI nylon webbing sling for use as a deployment line.
Figure 4-33. Extraction System Installed
4-42
FM 4-20.137/TO 13C7-1-19
INSTALLING THE CARGO PARACHUTE RELEASE SYSTEM
4-15. Install the M-2 cargo parachute release system as shown in Figure 4-34.
2
1
1
Place the M-2 release on the release platform. Attach the suspension slings and the
parachute riser extensions to the M-2 cargo parachute release according to FM 4-20.102/
NAVSEA SS400-AB-MMO-010/TO 13C7-1-5. Secure the cargo parachute release with type
III nylon cord.
2
S-fold and tie any slack in the suspension slings with 1/4-inch cotton webbing.
Figure 4-34. Cargo Parachute Release Installed
4-43
FM 4-20.137/TO 13C7-1-19
PLACING EXTRACTION PARACHUTE
4-16. Select the extraction parachute and extraction line needed using the
extraction line requirements table in FM 4-20.102/NAVSEA SS400-AB-MMO-
010/TO 13C7-1-5. Rig the extraction line in an extraction line bag according to
TM 10-1670-286-20/TO 13C5-2-41. Place the extraction parachute and extrac-
tion line on the load for installation in the aircraft.
INSTALLING PROVISIONS FOR EMERGENCY RESTRAINTS
4-17. Select and install the provisions for emergency aft restraints according to
the emergency aft restraint requirements table in FM 4-20.102/NAVSEA SS400
-AB-MMO-010/TO 13C7-1-5.
MARKING RIGGED LOAD
4-18. Mark the rigged load according to FM 4-20.102/NAVSEA SS400-AB-MMO
-010/TO 13C7-1-5 and as shown in Figure 4-35. Complete Shipper’s Declaration
for Dangerous Goods and affix to the load. If the load varies from the one shown,
the weight, height, CB, tipoff curve, and parachute requirements must be
recomputed.
EQUIPMENT REQUIRED
4-19. Use the equipment list in Table 4-2 to rig the load shown in Figure 4-35.
4-44
FM 4-20.137/TO 13C7-1-19
CAUTION
Make the final inspection required by FM 4-20.102/NAVSEA
SS400-AB-MMO-010/TO 13C7-1-5 before the load leaves
the rigging site.
CB
RIGGED LOAD DATA
Weight
18,501 pounds
Maximum Weight
20,000 pounds
Height
88 inches
Width
108 inches
Overall Length
258 inches
Overhang: Front
0 inches
Overhang: Rear
18 inches
Center of Balance (CB) (from front edge of platform)
121 inches
Figure 4-35. AAFARS withThree 500-Gallon Drums Rigged
4-45
FM 4-20.137/TO 13C7-1-19
Table 4-2. Equipment Required for Rigging AAFARS With Three 500-Gallon Drums
National Stoc k
Item
Quantity
Number
8040-00-273-8713
Adhesive paste, 1-gal
As required
1670-01-035-6054
Bridle, extraction line bag (C-17 only)
1
4030-00-090-5354
Clevis, large
11
4030-00-678-8562
Clevis, medium
4
4020-00-240-2146
Cord, nylon, type
I
As required
1670-00-360-0328
Cover, clevis, large
4
8305-00-958-3685
Felt sheet, 1/2-inch
As required
1670-00-003-4391
Knife, parachute bag for DES
)
1
1670-01-183-2678
Leaf, extraction line (line bag)(add 1 for DES
)
2
Line, drogue (for C-17)
1670-01-064-4452
60-foot (1-loop),
t
1
1670-01-062-6304
Line, deployment:
9-foot (2-loop),
t
1
Line, extraction:
1670-01-062-6313
For C-130: 60-foot (3-loop),
t
1
1670-01-107-7651
For C-141: 140-foot (3-loop),
t
1
1670-01-107-7651
For C-17: 140-foot (3-loop),
t
1
Link assembly:
T
wo-point:
5306-00-435-8994
Bolt, 1-in diam, 4-in long
2
5310-00-232-5165
Nut, 1-in, hexagonal
2
1670-00-003-3454
Plate, side, 5 1/2-in
2
5365-00-007-3414
Spacer, large
2
T
wo-point, 3 3/4-in (for DES
)
5306-00-435-8994
Bolt, 1-in diam, 4-in long
2
5310-00-232-5165
Nut, 1-in, hexagonal
2
1670-00-003-1953
Plate, side, 3 3/4-in
2
5365-00-007-3414
Spacer, large
2
1670-01-307-1055
Three-poin t
2
1670-01-483-8259
Link,
t
1
4-46
FM 4-20.137/TO 13C7-1-19
Table 4-2. Equipment Required for Rigging AAFARS With Three 500-Gallon Drums (Continued)
National Stock
Item
Quantity
Number
Lumber:
5510-00-220-6146
2- by 4-in
As required
5315-00-753-3885
Nail, steel wire, common, 16d
As required
1670-00-753-3928
Pad, energy dissipating, honeycomb, 3- by 36- by
96-in
24 sheets
Parachute:
1670-01-016-7841
Cargo, G-11B
4
1670-00-040-8135
Cargo, extraction, 28ft
1
1670-01-063-3715
Drogue, 15ft (for C-17)
1
Platform, airdrop, type
V
, 20-foot:
1670-01-353-8425
Bracket assembly, component, (EFTC
)
(1
)
1670-01-247-2389
Bracket, suspension
(8
)
1670-01-162-2372
Clevis assembly, type V
(54)
1670-01-353-8424
Extraction bracket assembly
(1
)
1670-01-162-2381
Link, tandem, suspension link assembly
(2
)
5530-00-618-8073
Plywood, 3/4- by 48- by 96-in
11 sheets
1670-01-097-8817
Release, cargo parachute, M-2
1
Sling, cargo airdrop
For suspension:
1670-01-062-6306
3-ft (4-loop), type XXVI nylon webbing
4
1670-01-062-6307
12-ft (4-loop), type XXVI nylon webbing
2
1670-01-062-6308
16-ft (4-loop), Type XXVI nylon webbing
2
1670-01-064-4453
20-ft (4-loop), typeXXVI nylon webbing
2
For riser extension:
1670-01-062-6313
60-ft (3-loop), type XXVI nylon webbing
4
1670-00-040-8219
Strap, parachute release, multicut
2
7510-00-266-5016
T
ape, adhesive, 2-in
As required
7510-00-266-6710
T
ape, masking, 2-in
As required
1670-00-937-0271
Tie-down assembly, 15-ft
61
Webbing:
8305-00-268-2411
Cotton, 1/4-in, type I
As required
8305-00-082-5752
Nylon, tubular, 1/2-in
As required
8305-00-263-3591
T
ype VIII
As required
4-47
FM 4-20.105/TO 13C7-1-19
SECTION II - RIGGING AAFARS WITH FOUR 500-GALLON FUEL DRUMS
DESCRIPTION OF LOAD
4-20. The Advanced Aviation Forward Area Refueling System (AAFARS) is
rigged on a 20-foot, type V airdrop platform with five G-11 parachutes. The
AAFARS is designed for forward area refueling of up to four aircraft at a time
with a minimum output of 55 GPM. There are four collapsible fuel drums as an
accompanying load. Each drum is filled with 432 gallons of liquid. When empty,
each drum weighs 250 pounds and is 62 inches long and 53 inches in diameter.
The overall length of the load is 258 inches. The load is 88 inches high. Its
center of balance is 121 inches.
Notes:
1. For drums filled with a liquid other than water, use Table 1-1 to
recompute the weight.
2. If the load varies from the one shown, the weight, height, CB, tipoff
curve, and parachute requirements must be recomputed.
3. Do not pressurize drums with air.
PREPARING PLATFORM
4-21. Prepare a 20-foot type V airdrop platform using two tandem links, eight
suspension brackets and 62 tie-down clevises as shown in Figure 4-36.
Notes: 1. The nose bumper may or may not be installed.
2. Measurements given in this section are from the front edge of the
platform, NOT from the front edge of the nose bumper.
4-48
FM 4-20.105/TO 13C7-1-19
CLEVISES
31A THROUGH 1A
REAR
FRONT
CLEVISES
31 THROUGH 1
Steps:
1.
Inspect, or assemble and inspect, the platform as outlined in TM 10-1670-268-20&P/
TO 13C7-52-22.
2.
Install a tandem link on the front of each platform side rail using holes 1, 2, and 3.
3.
Install a suspension bracket to each platform side rail using holes 5, 6, and 7.
4.
Install a suspension bracket to each platform side rail using holes 17, 18, and 19.
5.
Install a suspension bracket to each platform side rail using holes 22, 23, and 24.
6.
Install a suspension bracket to each platform side rail using holes 34, 35, and 36.
7.
Install a tie-down clevis to bushings 1 (doubled), 3, and 4 (doubled) on each front
tandem link.
8.
Install a tie-down clevis to bushings 1 (doubled), 3 (doubled), and 4 on each of the
first suspension brackets.
9.
Install a tie-down clevis to bushings 2 and 3 of each of the second suspension
brackets.
10. Install a tie-down clevis to bushings 2 and 3 of each of the third suspension
brackets.
11. Install a tie-down clevis to bushings 1 (doubled), 3 and 4 of each of the fourth
suspension brackets.
12. Starting at the front of each platform side rail, install a tie-down clevis to the
bushings bolted to holes 8, 14, 15, 26, 27, 32, 33, 37 (doubled), 38 (doubled), and
40 (doubled).
13. Starting at the front of the platform, number the clevises bolted to the right side
from 1 through 31 and those bolted to the left side from 1A through 31A.
Figure 4-36. Platform Prepared
4-49
FM 4-20.105/TO 13C7-1-19
PREPARING AND POSITIONING HONEYCOMB STACKS
4-22. Prepare the honeycomb stacks as shown in Figure 4-2. Place the honey-
comb stacks on the platform as shown in Figure 4-3.
BUILDING THE EQUIPMENT BOXES
4-23. Build the front and rear equipment boxes as shown in Figures 4-4 and 4-5.
PREPARING EQUIPMENT FOR EQUIPMENT BOXES
4-24. Prepare the fire extinguishers, filter separator, explosion proof motor,
pumps, battery box, manuals and toolkit as explained and shown in paragraph
4-6. Using the lists printed on the equipment bags, place the equipment indi-
cated on each list into its bag.
POSITIONING EQUIPMENT BOXES
4-25. Pre-position three lashings at each end of the platform as shown in Figure
4-13, steps 1 through 3. Position the equipment boxes flush over the ends of the
honeycomb as shown in Figure 4-13, step 4. Pad the inside lower box corners as
shown in Figure 4-13, step 5.
POSITIONING EQUIPMENT IN EQUIPMENT BOXES AND SECURING
BOXES
4-26. Position and secure the equipment in the equipment boxes, and secure the
boxes and lids as explained in paragraph 4-8, and as shown in Figures 4-14 and
4-15.
LASHING THE EQUIPMENT BOXES TO THE PLATFORM
4-27. Lash the equipment boxes to the platform as given below.
a. Lash the front equipment box to the platform as shown in Figures 4-37
through 4-39.
4-50
FM 4-20.105/TO 13C7-1-19

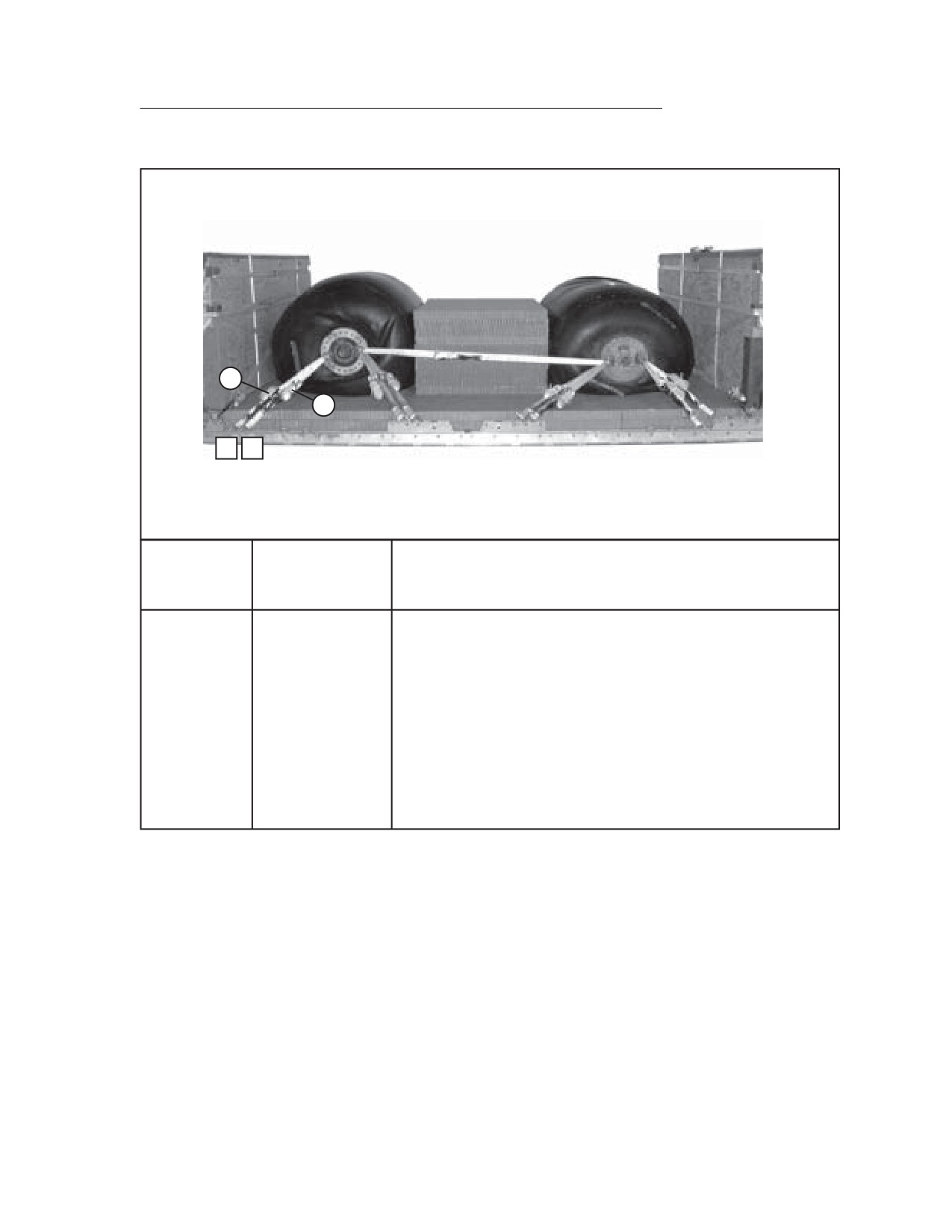

1
2
8
1
Tie-dow n
Lashing
Clevis
Instruction s
Number
Number
1
1 and
8

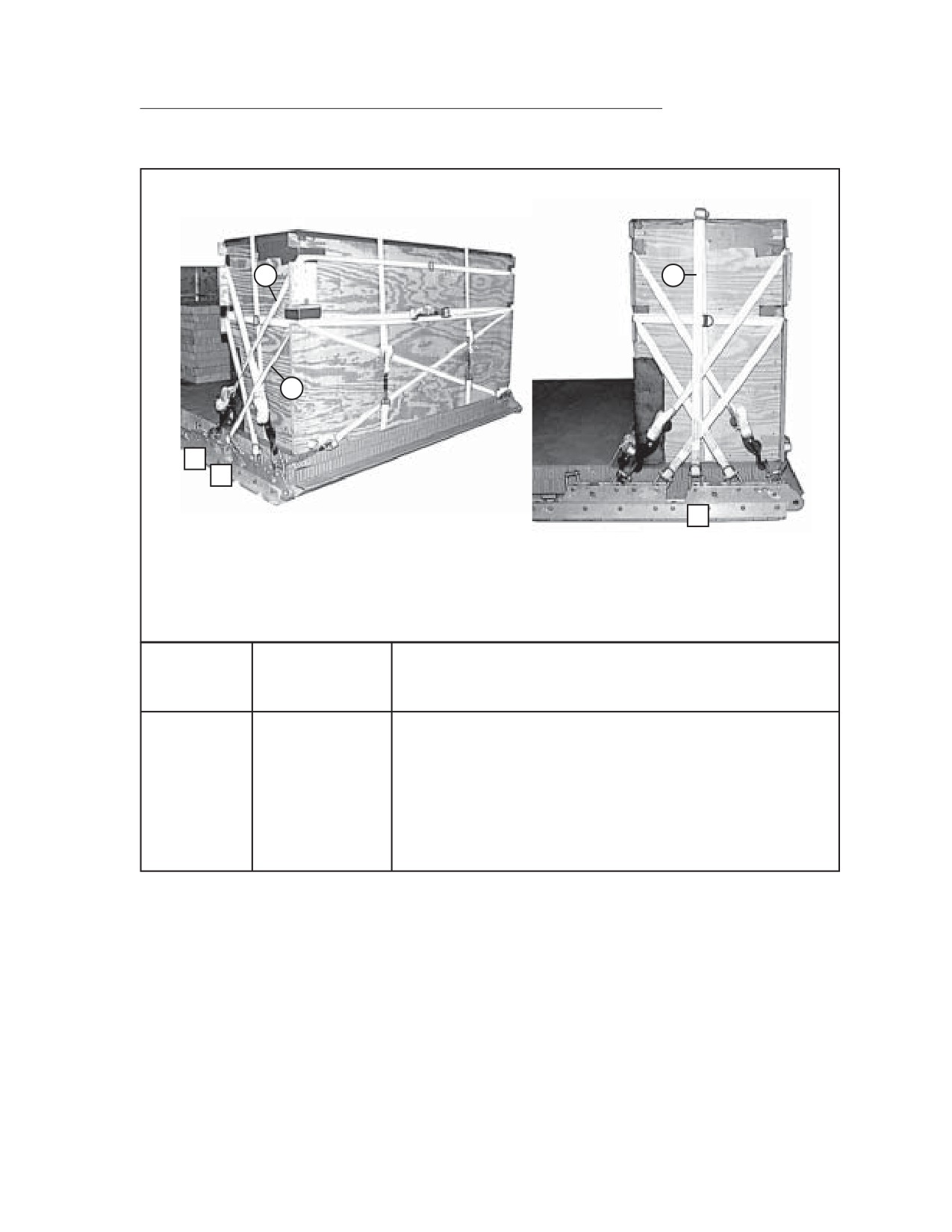

Route a 30-foot lashing from clevis 1 to the front bottom left
cutout, to the rear bottom left cutout, to clevis
8
2
1A and 8A
Route a 30-foot lashing from clevis 1A to the front bottom right
cutout, to the rear bottom right cutout, to clevis 8A
Figure 4-37. Lashings 1 and 2 Installed
4-51
FM 4-20.105/TO 13C7-1-19
3
4
2
3
Tie-dow n
Lashing
Clevis
Instruction s
Number
Number
3
2 and 2A

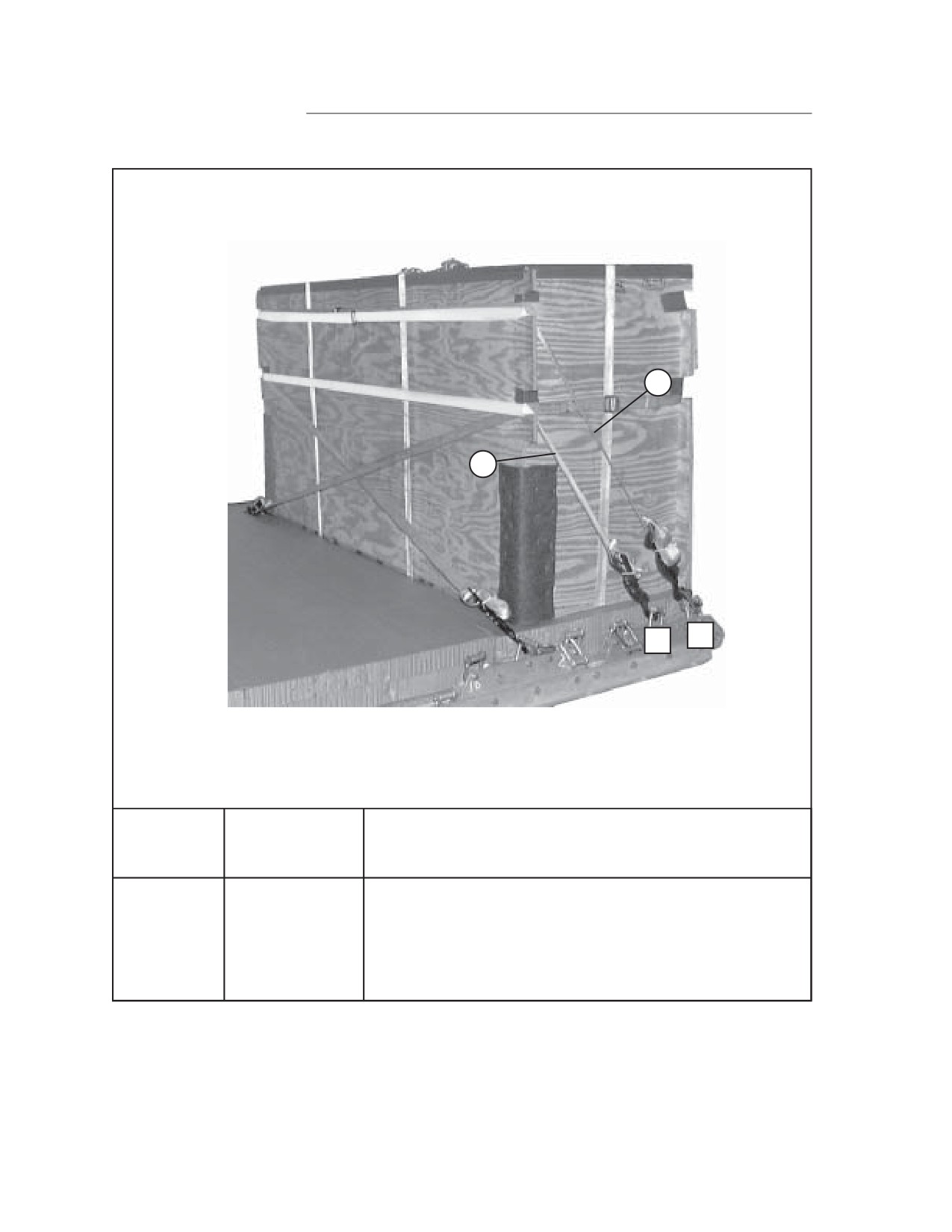

Route a 30-foot lashing from clevis 2 to the rear top right
cutout, to the rear top left cutout, to clevis 2A
4
3 and 3A
Route a lashing from clevis 3A and through its own D-ring
t
the rear bottom left cutout, to the rear bottom right cutout,
t
clevis
3
Figure 4-38. Lashings 3 and 4 Installed
4-52
FM 4-20.105/TO 13C7-1-19
7
6
5
9
6
7
6
9
6
4
Tie-dow n
Lashing
Clevis
Instruction s
Number
Number
5
4 and 4A
Route a lashing through it's own D-ring on clevis 4, repeat on
clevis 4A and load bind them together on top of the box.
6

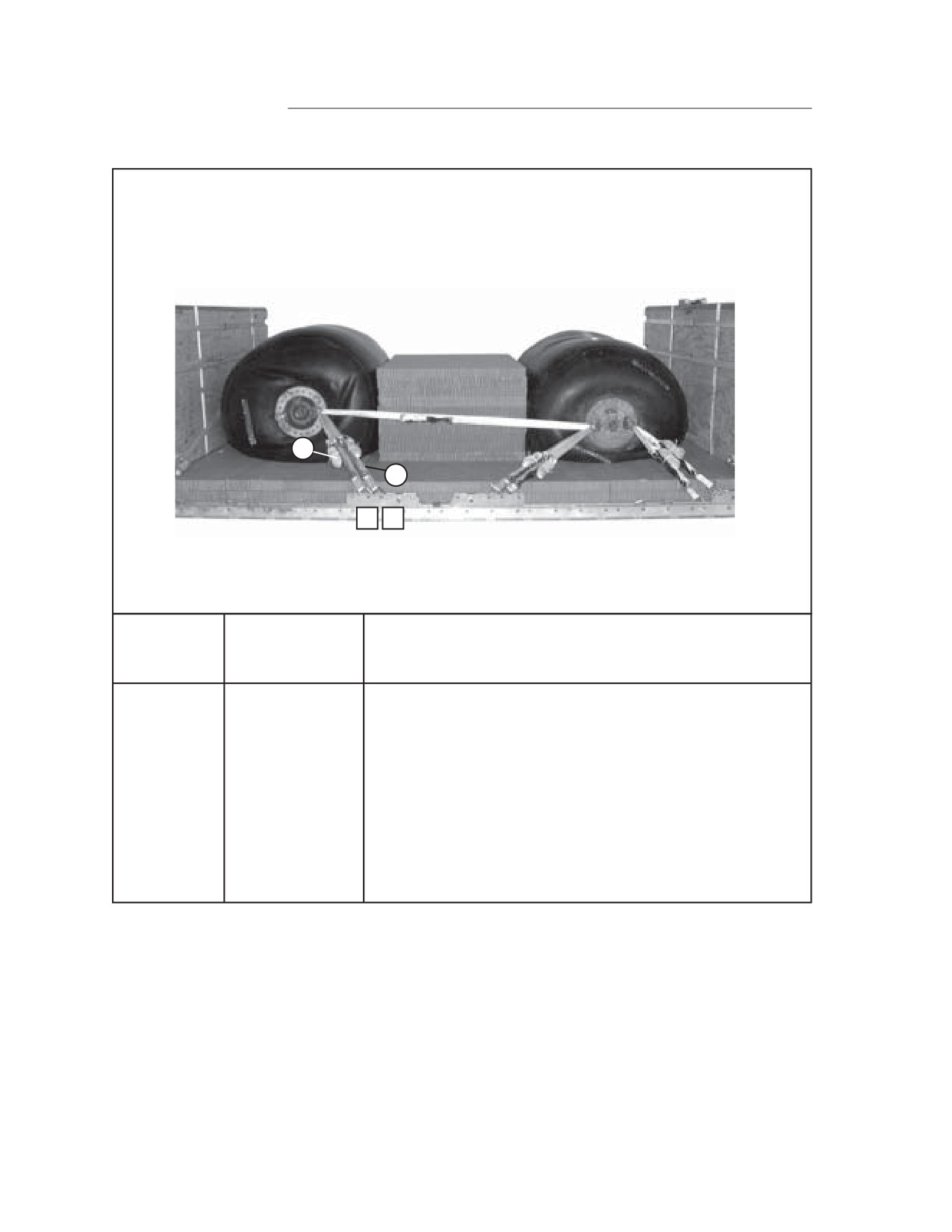

6 and 6A
Route a lashing through it's own D-ring on clevis 6 to the front
bottom right cutout, to the front bottom left cutout, to clevis 6A
7
9 and 9A
Route a 30-foot lashing from clevis 9 to the front top right
cutout, to the front top left cutout, to clevis 9A
Figure 4-39. Lashings 5 through 7 Installed
4-53
FM 4-20.105/TO 13C7-1-19
b. Lash the rear equipment box to the platform as shown in Figures 4-40
through 4-42.
9
9
8
22
8
30
Tie-dow n
Lashing
Clevis
Instruction s
Number
Number
8
22 and
30

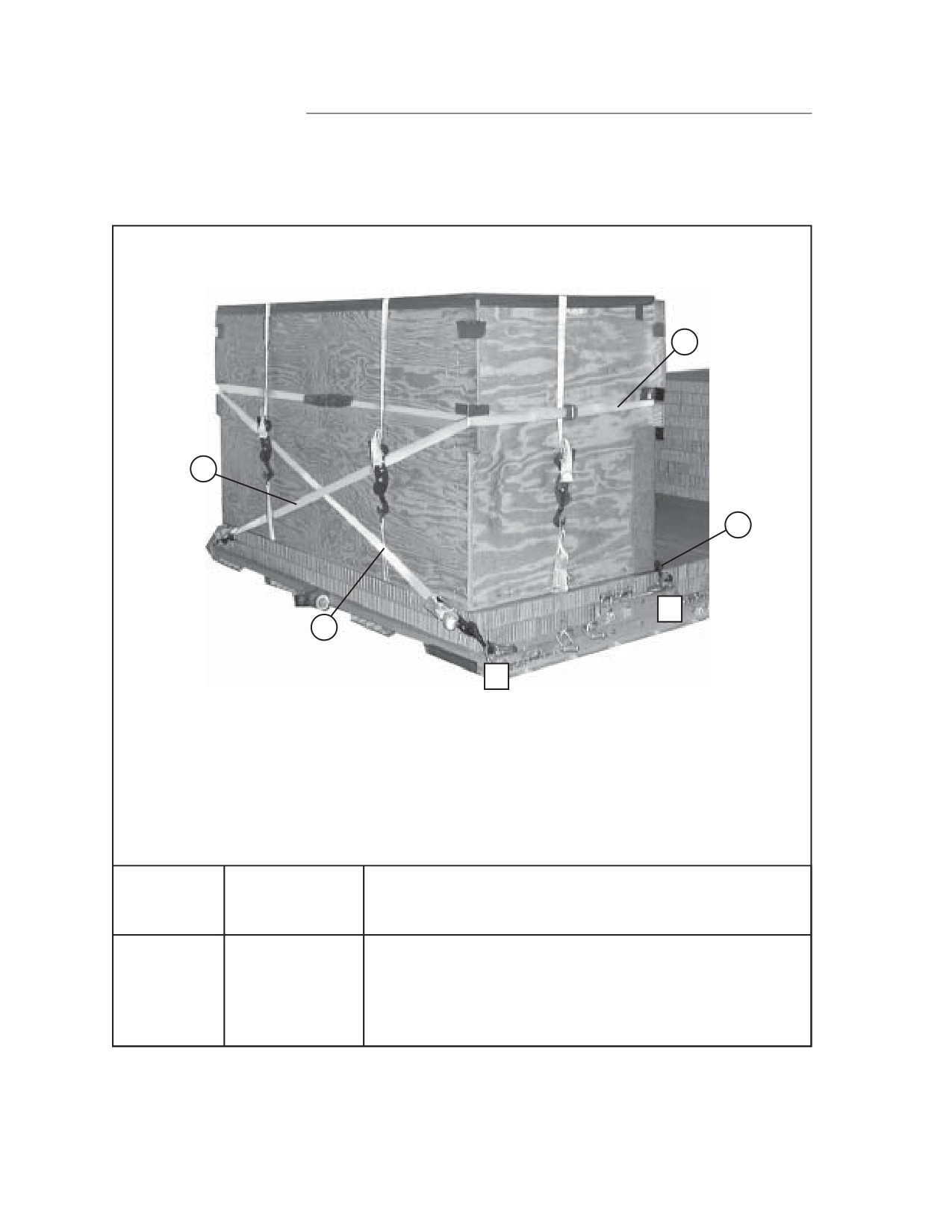

Route a 30-foot lashing from clevis 22 to the front lower left
cutout, to the rear lower left cutout, to clevis 30
9
22A and 30A
Route a 30-foot lashing from clevis 22A to the front lower right
cutout, to the rear lower right cutout, to clevis 30A
Figure 4-40. Lashings 8 and 9 Installed
4-54
FM 4-20.105/TO 13C7-1-19
10
11
23
27
Tie-dow n
Lashing
Clevis
Instruction s
Number
Number
10
23 and 23A

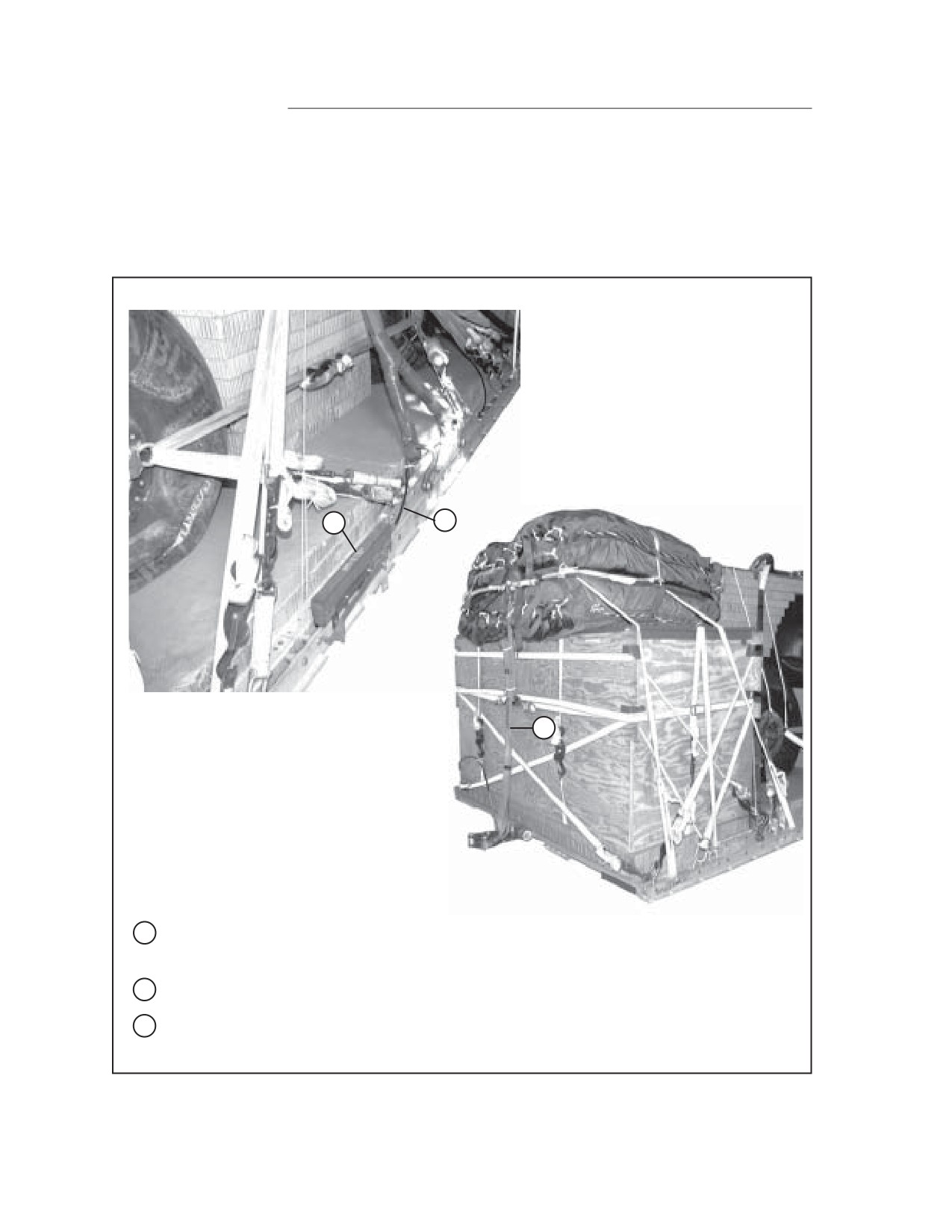

Route a 30-foot lashing from clevis 23 to the rear top right
cutout, to the rear top left cutout, to clevis 23A
11
27 and 27A
Route a lashing through it's own D-ring on clevis 27A to the
rear bottom left cutout, to the rear bottom right cutout to clevis
27.
Figure 4-41. Lashings 10 and 11 Installed
4-55
FM 4-20.105/TO 13C7-1-19
14
13
31
12
29
14
13
31
29
26
Tie-dow n
Lashing
Clevis
Instruction s
Number
Number
12

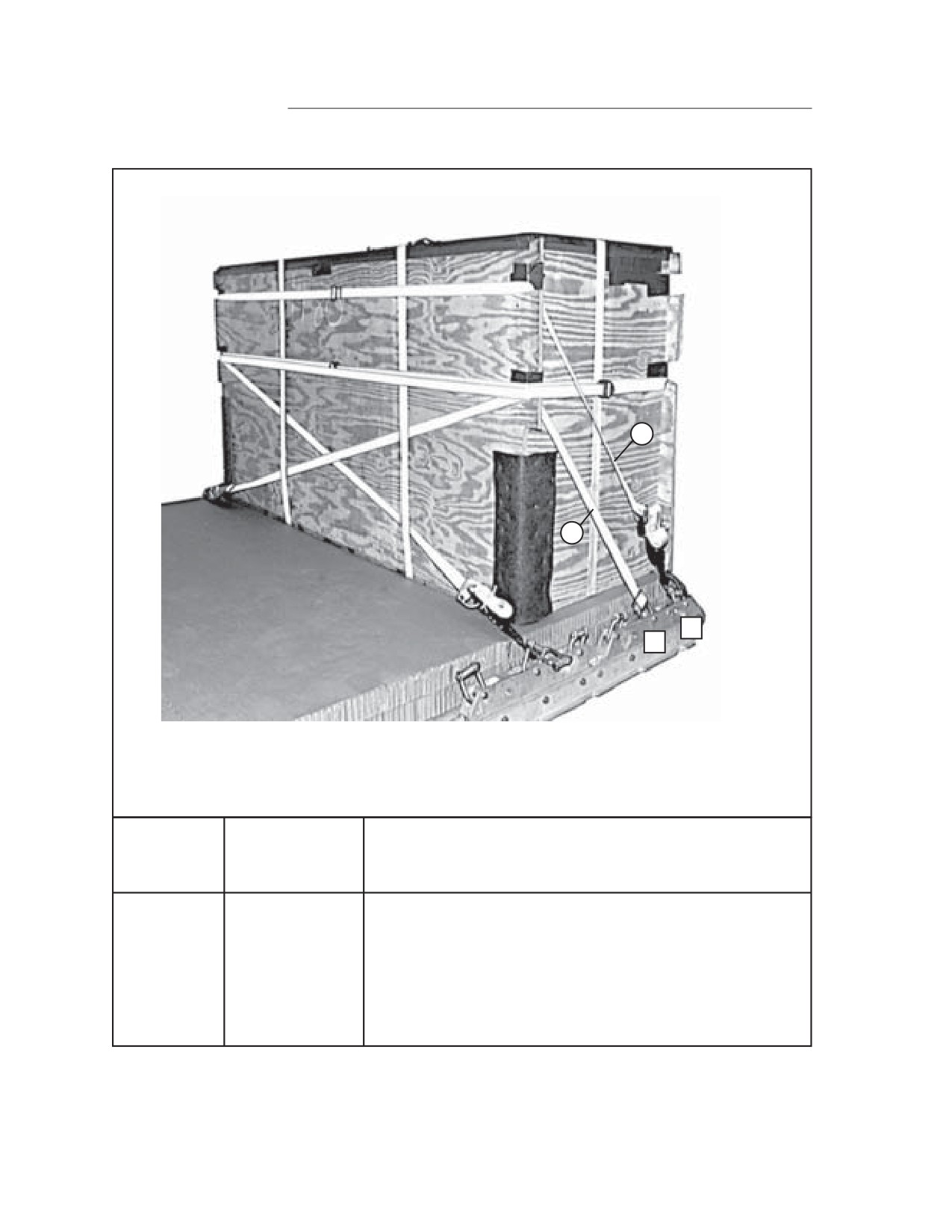

26 and 26A
Route a lashing through it's own D-ring on clevis 26, repeat on
clevis 26A and load bind on the side of the box.
13
29 and 29A
Route a lashing through it's own D-ring on clevis 29 to the
front bottom right cutout, to the front bottom left cutout to clevis
29A
14
31 and 31A
Route a 30-foot lashing from clevis 31 to the front top right
cutout to the front top left cutout, and to clevis 31A
Figure 4-42. Lashings 12 through 14 Installed
4-56

Content      ..     6      7      8      9     ..
