FM 4-20.137 RIGGING FORWARD AREA REFUELING EQUIPMENT (FARE) AND ADVANCED AVIATION FORWARD AREA REFUELING SYSTEM (AAFARS, JUNE 2003) - page 5

  Главная      Manuals     FM 4-20.137 RIGGING FORWARD AREA REFUELING EQUIPMENT (FARE) AND ADVANCED AVIATION FORWARD AREA REFUELING SYSTEM (AAFARS, JUNE 2003)

Search            copyright infringement

Content      ..     3      4      5      6     ..

FM 4-20.137 RIGGING FORWARD AREA REFUELING EQUIPMENT (FARE) AND ADVANCED AVIATION FORWARD AREA REFUELING SYSTEM (AAFARS, JUNE 2003) - page 5

FM 4-20.137/TO 13C7-1-19
10
14
12
17
16

Tie-dow n
Lashing
Clevis
Number
Number
Instructions
10
Route a lashing from the front shackle of the rear drum
to the rear shackle of the front drum on the right side.
11
Route a lashing from the front shackle of the rear drum
to the rear shackle of the front drum on the left side.
12
16
Route a lashing through the right rear shackle of the rear
drum
13
16A
Route a lashing through the left rear shackle of the rear
drum
Route a lashing through the right rear shackle of the rear
14
17
drum
Route a lashing through the left rear shackle of the rear
15
17A
drum
Figure 3-13. Lashings 10 through 35 Installed
3-20
FM 4-20.137/TO 13C7-1-19
18
22
16
20
12
11
10
9

Tie-dow n
Lashing
Clevis
Number
Number
Instructions
16
12
Route a lashing through the right front shackle of the
rear drum
17
12A
Route a lashing through the left front shackle of the rear
drum
18
11
Route a lashing through the right front shackle of the
rear drum
19
11A
Route a lashing through the left front shackle of the rear
drum
20
9
Route a lashing through the right rear shackle of the
front drum
21
9A
Route a lashing through the left rear shackle of the front
drum
22
10
Route a lashing through the right rear shackle of the
front drum
23
10A
Route a lashing through the left rear shackle of the front
drum
Figure 3-13. Lashings 10 through 35 Installed (continued)
3-21
FM 4-20.137/TO 13C7-1-19
26
34
30
28
32
24
14
13
8
7
5
4

Tie-dow n
Lashing
Clevis
Number
Number
Instructions
24
5
Route a lashing through the right front shackle of the front
drum
25
5A
Route a lashing through the left front shackle of the front
drum
26
4
Route a lashing through the right front shackle of the front
drum
27
4A
Route a lashing through the left front shackle of the front
drum
28
13
Route a lashing through the right rear shackle of the top
drum
29
13A
Route a lashing through the left rear shackle of the top
drum
30
14
Route a lashing through the right rear shackle of the top
drum
31
14A
Route a lashing through the left rear shackle of the top
drum
32
8
Route a lashing through the right front shackle of the top
drum
33
8A
Route a lashing through the left front shackle of the top
drum
34
7
Route a lashing through the right front shackle of the top
drum
35
7A
Route a lashing through the left front shackle of the top
drum
Figure 3-13. Lashings 10 through 35 Installed (continued)
3-22
FM 4-20.137/TO 13C7-1-19

PREPARING AND POSITIONING THE PUMP
3-12. Prepare the pump according to paragraph 2-5 and as shown in Figure 2-8.
Position the load as shown in Figure 3-14.
3
2
1
1
Raise the legs and secure with the pins.
2
Retract the lunette.
3
Position the pump on stack 1 and align the front frame edge with the front edge
of the platform.
4
Pad the tie-down points with cellulose wadding and tape (not shown).
Figure 3-14. Pump Prepared and Positioned on Platform
3-23
FM 4-20.137/TO 13C7-1-19
LASHING PUMP TO THE PLATFORM
3-13. Lash the pump to the platform as shown in Figure 3-15.
42
38
36
40
6
3
2
1

Tie-dow n
Lashing
Clevis
Number
Number
Instructions

36
6
Route a lashing through the right rear tie-dow n point.
37
6A
Route a lashing through the left rear tie-dow n point.
38
3
Route a lashing through the right rear tie-dow n point.
39
3A
Route a lashing through the left rear tie-dow n point.
40
2
Route a lashing through the right front tie-dow n point.
41
2A
Route a lashing through the left front tie-dow n point.
42
1
Route a lashing around the right side frame.
43
1A
Route a lashing around the left side frame.
Figure 3-15. Lashings 36 through 43 Installed

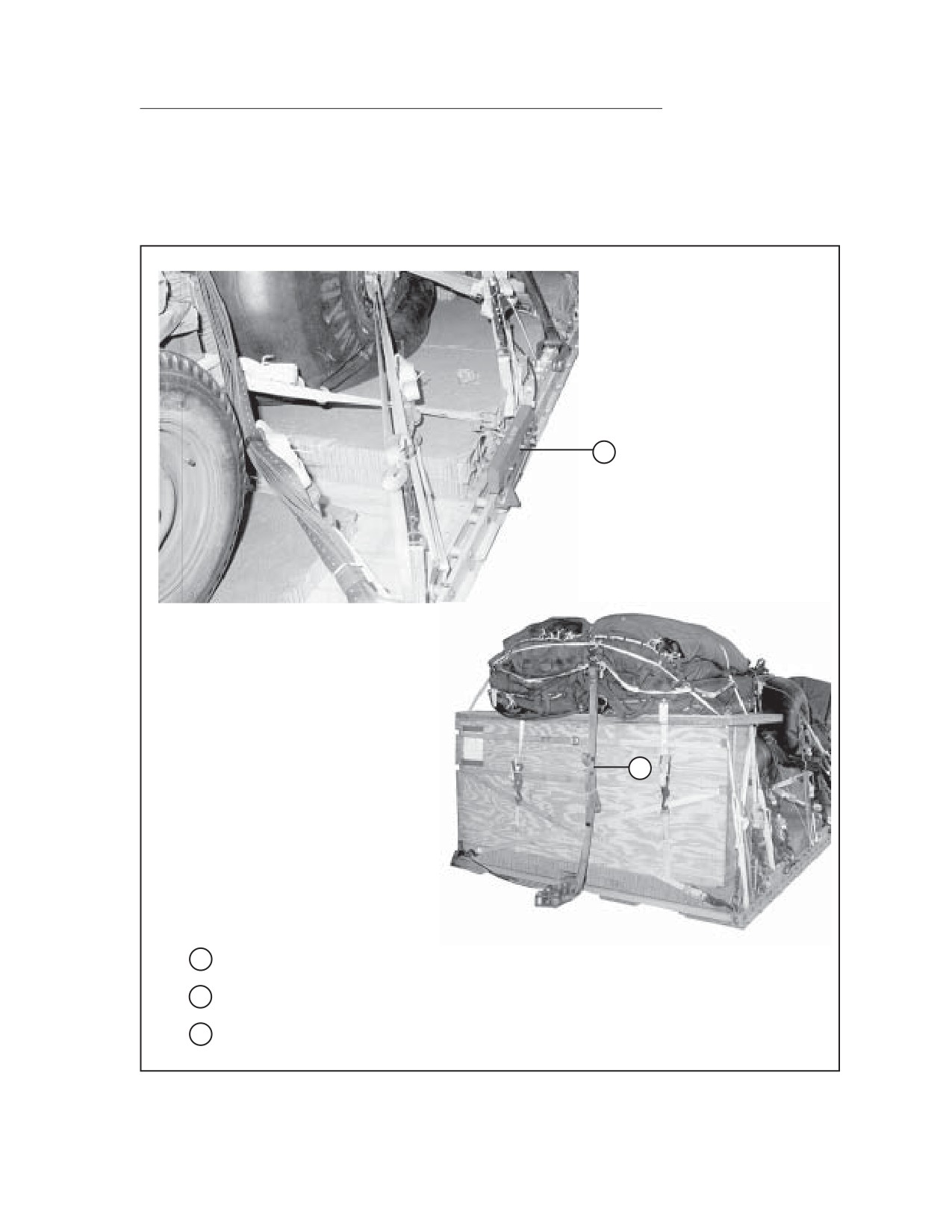

3-24
FM 4-20.137/TO 13C7-1-19
COVERING THE PUMP
3-14. Place a canvas cover over the pump as shown in Figure 3-16.
2
1
1
Place two pieces of 48- by 28-inch honeycomb between the pump and the drum.
Secure the honeycomb to the pump with type III nylon cord.
2
Cover the pump with a canvas cover and secure the cover with type III nylon
cord.
Figure 3-16. Pump Covered and Secured
3-25
FM 4-20.137/TO 13C7-1-19

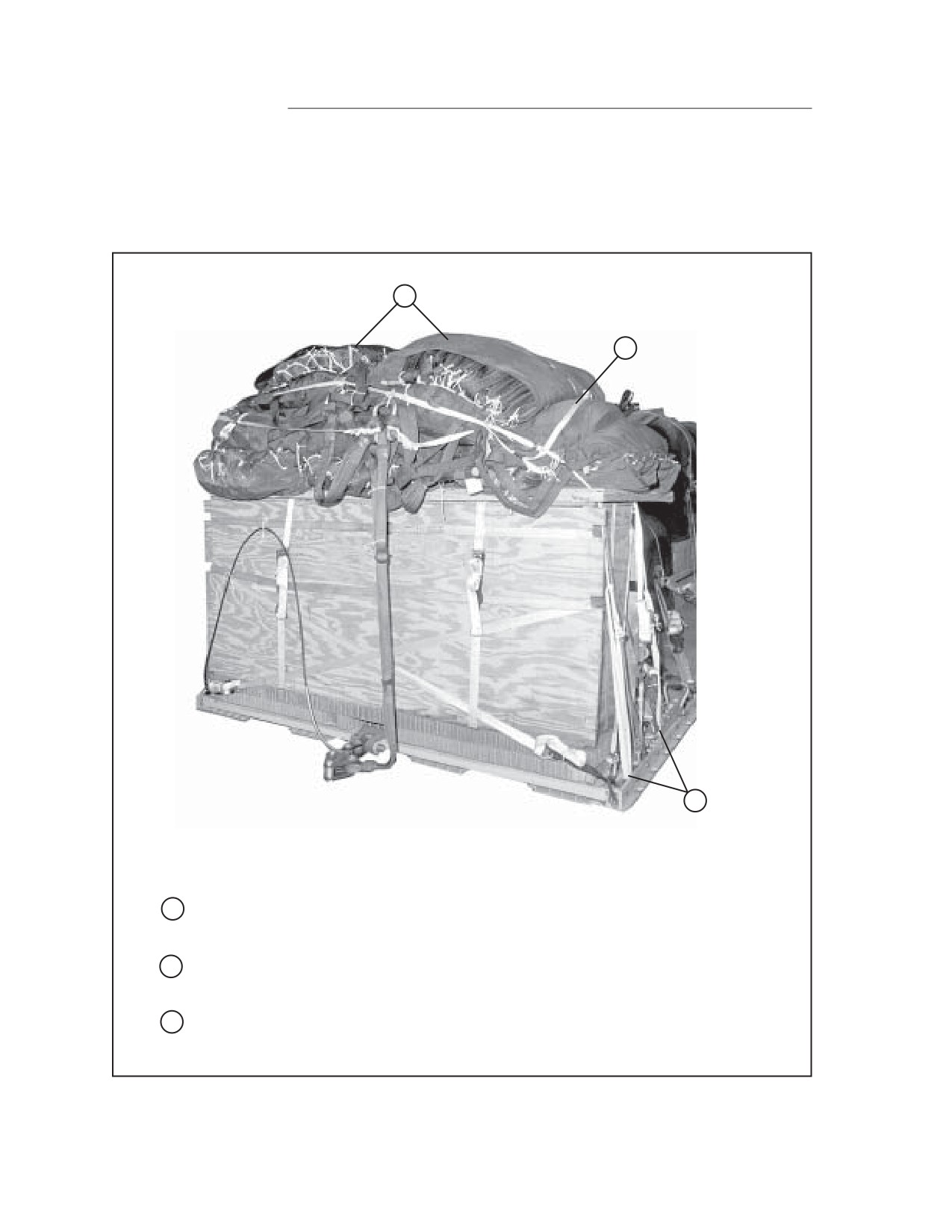

INSTALLING SUSPENSION SLINGS AND SAFETY TIES

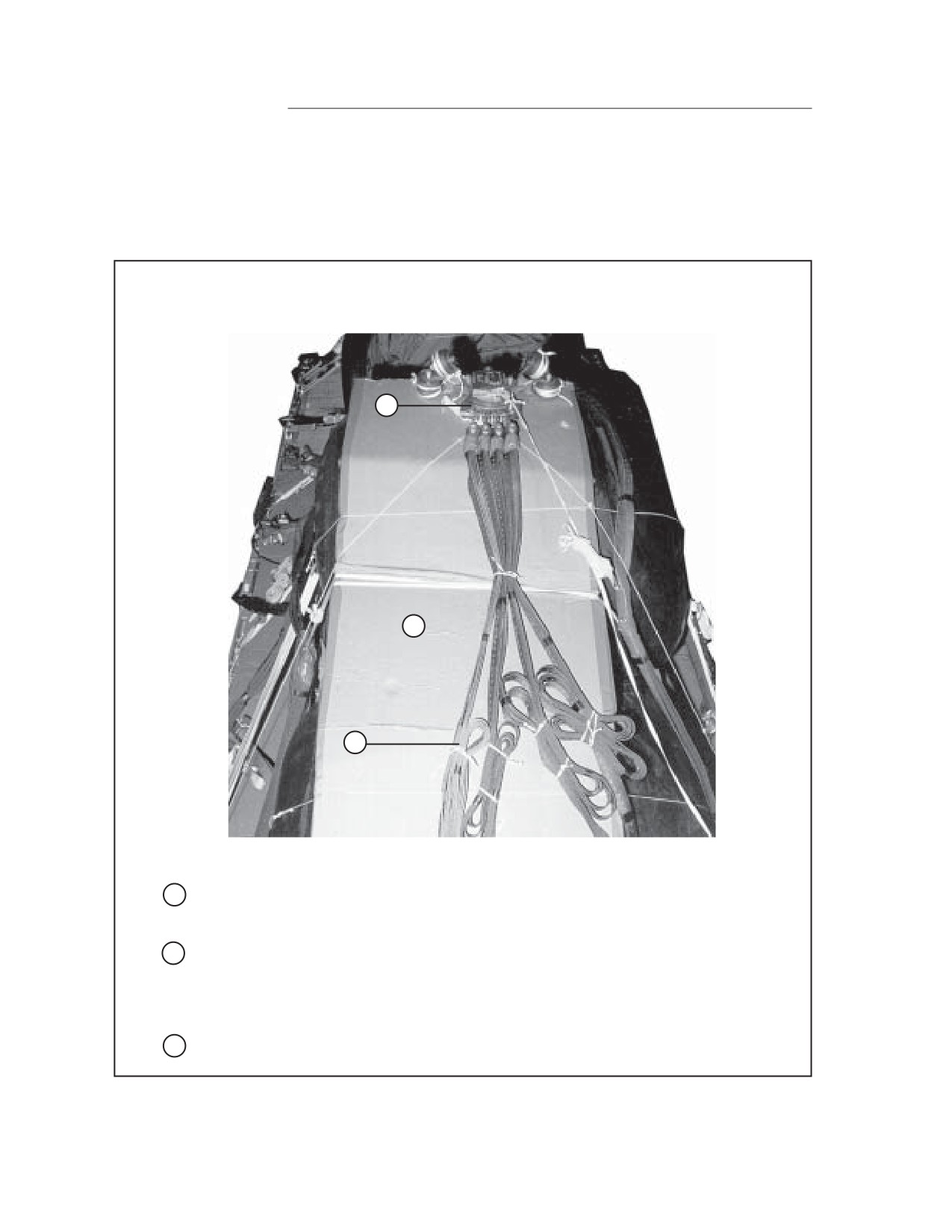

3-15. Install suspension slings and safety ties as shown in Figure 3-17.
6
5
8
4
1
2
3
1
Attach a 16-foot (4-loop), type XXVI nylon webbing sling to each rear suspension
bracket with a large clevis.
2
Attach a 3-foot (4-loop), type XXVI nylon webbing sling to each second and third suspen-
sion bracket with a large suspension clevis.
3
Place the 3-foot slings on each side of the load in the bell of a large suspension clevis.
4
Bolt a 9-foot (4-loop), type XXVI nylon webbing sling to each large suspension clevis.
Tie the large suspension clevises to the top drum with type III nylon cord (not shown).
5
Join the rear and center suspension slings together with a 3-point link on each side of
the load.
6
Attach a 3-foot (4-loop), type XXVI nylon webbing sling to the top point on the 3-point
links.
7
Pad and tape the link assemblies (not shown).
8
Attach a 20-foot (4-loop), type XXVI nylon webbing sling to each front suspension
bracket with a large suspension clevis.
9
Raise the suspension slings and install the suspension sling safety ties as shown in
Appendix A, to the front and rear suspension slings, six to eight inches above the
highest point of the load (not shown).
Figure 3-17. Suspension Slings and Safety Ties Installed
3-26
FM 4-20.137/TO 13C7-1-19

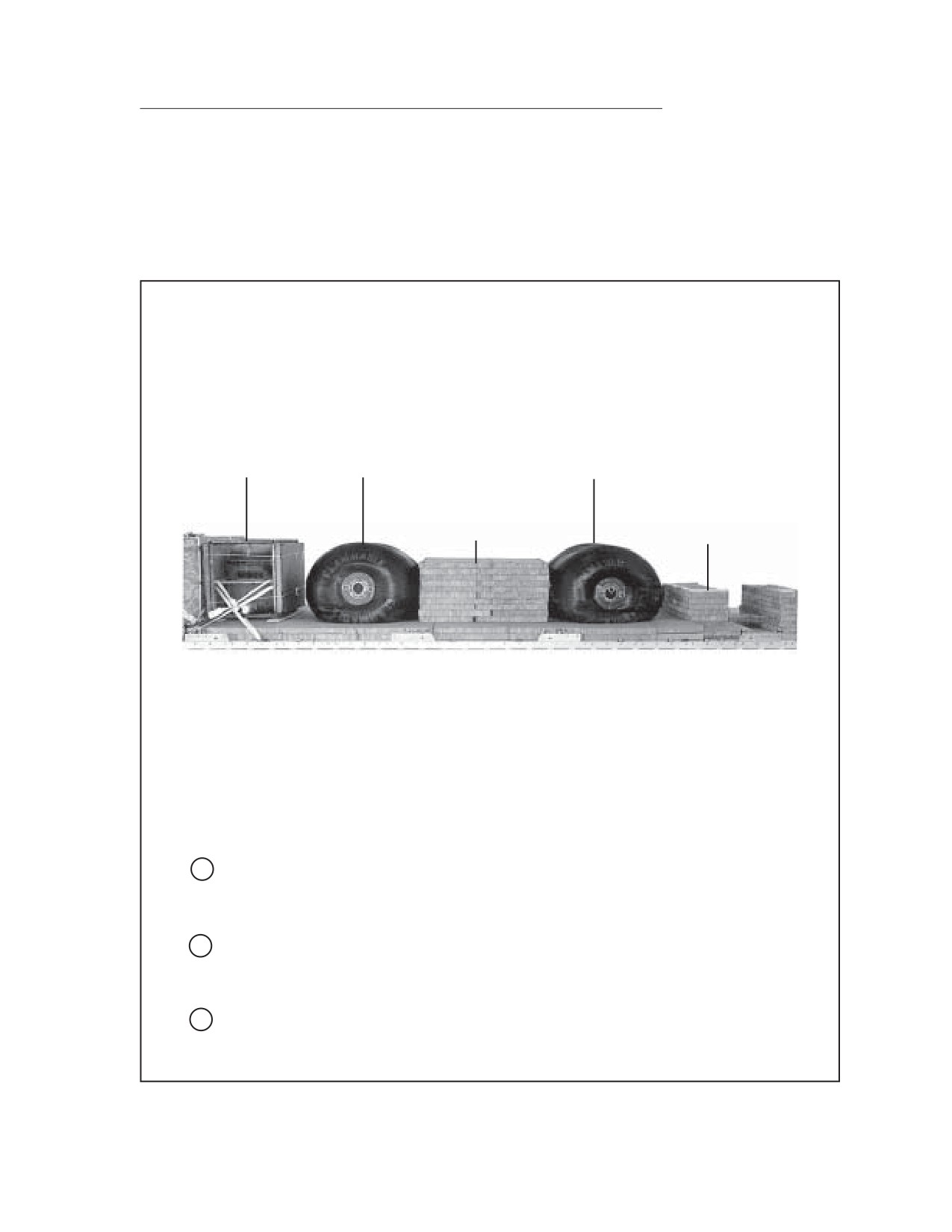

BUILDING AND POSITIONING PARACHUTE STOWAGE PLATFORM
3-16. Build and stow the parachute stowage platform as shown in Figure 3-18.
Align the rear edge of the stowage platform on the rear edge of the box.

96”
2”
2” x 6” x 85”
LUMBER
22”
2” x 6” x 48”
LUMBER
48”
3/4” PLYWOOD
22”
2” x 6” x 85”
LUMBER
2”
2”
44
22
Tie-dow n
Lashing
Clevis
Number
Number
Instructions
44
22
Route a 15-foot lashing through both right rear holes in
the stowage platform
45
22A
Route a 15-foot lashing through both left rear holes in the
stowage platform
Figure 3-18. Parachute Stowage Platform Built and Positioned
3-27
FM 4-20.137/TO 13C7-1-19
PREPARING AND STOWING CARGO PARACHUTES
3-17. Prepare and stow four G-11 cargo parachutes as shown in Figure 3-19.
1
3
2
1
Prepare and stow four G-11 cargo parachutes according to FM 4-20.102/NAVSEA
SS400-AB-MMO-010/TO 13C7-1-5.
2
Restrain the parachutes according to FM 4-20.102/NAVSEA SS400-AB-MMO-010/TO
13C7-1-5 by using bushings 47 and 47A on the platform and bushings 3 and 3A on the
rear suspension link.
3
Install the multicut parachute release strap according to FM 4-20.102/NAVSEA SS400-
AB-MMO-010/TO 13C7-1-5.
Figure 3-19. Cargo Parachutes Prepared and Stowed
3-28
FM 4-20.137/TO 13C7-1-19
INSTALLING THE EXTRACTION SYSTEM
3-18. Install the extraction system as shown in Figure 3-20.
3
2
1
Install the EFTC according to FM 4-20.102/NAVSEA SS400-AB-MMO-010/TO 13C7-1-5.
2
Attach a 9-foot (2-loop), type XXVI nylon webbing sling for use as the deployment line.
3
Use the rear mounting holes for the EFTC actuator mounting bracket and a 24-foot
cable.
Figure 3-20. Extraction System Installed
3-29
FM 4-20.137/TO 13C7-1-19

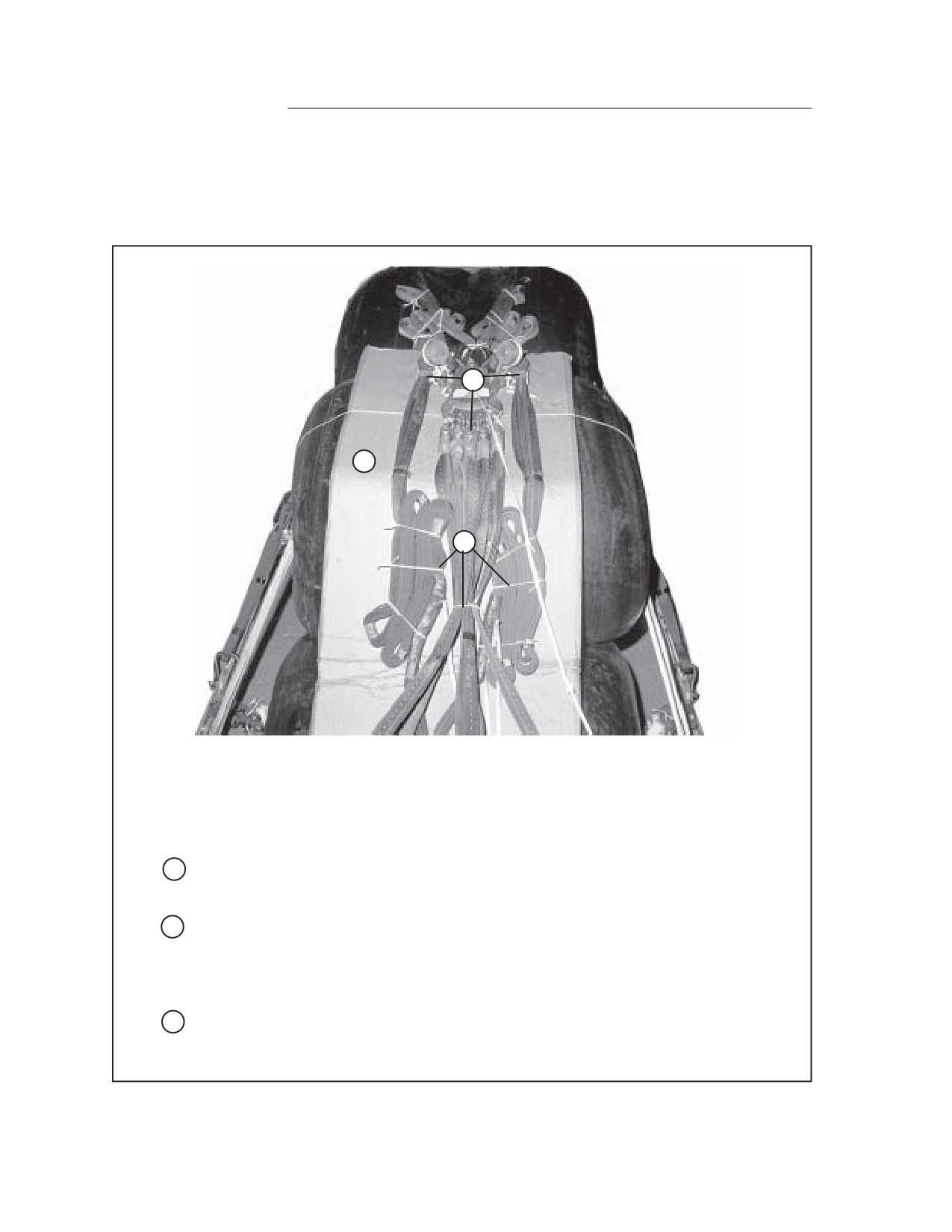

INSTALLING THE CARGO PARACHUTE RELEASE SYSTEM
3-19. Install the M-2 cargo parachute release system as shown in Figure 3-21.
2
1
3
1
Place a 96- by 24-inch piece of honeycomb from the separator to the top of the top
drum. Secure the honeycomb with type III nylon cord.
2
Place the M-2 cargo parachute release on the honeycomb placed on top of the top
drum. Attach the suspension slings and the parachute riser extension to the M-2
cargo parachute release according to FM 4-20.102/NAVSEA SS400-AB-MMO-
010/TO 13C7-1-5. Secure the cargo parachute release with type III nylon cord.
3
S-fold and tie any slack in the suspension slings with Type I, 1/4-inch cotton
webbing.
Figure 3-21. Cargo Parachute Release Installed
3-30
FM 4-20.137/TO 13C7-1-19
PLACING EXTRACTION PARACHUTE
3-20. Select the extraction parachute and extraction line needed using the
extraction line requirements table in FM 4-20.102/NAVSEA SS400-AB-MMO-
010/TO 13C7-1-5. Rig the extraction line in an extraction line bag according to
TM 10-1670-286-20/TO 13C5-2-41. Place the extraction parachute and extrac-
tion line on the load for installation in the aircraft.
INSTALLING PROVISIONS FOR EMERGENCY RESTRAINTS
3-21. Select and install the provisions for emergency aft restraints according to
the emergency aft restraint requirements table in FM 4-20.102/NAVSEA SS400-
AB-MMO-010/TO 13C7-1-5.
MARKING RIGGED LOAD
3.22. Mark the rigged load according to FM 4-20.102/NAVSEA SS400-AB-MMO-
010/TO 13C7-1-5 and as shown in Figure 3-22. Complete Shipper’s Declaration
for Dangerous Goods and affix to the load. If the load varies from the one
shown, the weight, height, CB, tipoff curve, and parachute requirements must
be recomputed.
EQUIPMENT REQUIRED
3-23. Use the equipment list in Table 3-1 to rig the load shown in Figure 3-22.
3-31
FM 4-20.137/TO 13C7-1-19
CAUTION:
Make the final inspection required by FM 4-20.102/NAVSEA
SS400-AB-MMO-010/TO 13C7-1-5 before the load leaves
the rigging site.
CB
RIGGED LOAD DATA
Weight
19,689 pounds
Maximum Weight
21,000 pounds
Height
89 inches
Width
108 inches
Overall Length
315 inches
Overhang: Front (Tongue of Pump)
9 inches
Rear (EFTC)
18 inches
Center of Balance (CB) (from front edge of platform)
144 inches
Extraction System
EFTC
Figure 3-22. Three 500-Gallon Drums with Pump and Separator Rigged for Low-Velocity Airdrop
3-32
FM 4-20.137/TO 13C7-1-19
Table 3-1. Equipment Required for Rigging Three 500-Gallon Drums with Pump and Separator
National Stock
Number
Item
Quantity
8040-00-273-8713
Adhesive, paste, 1-gal
As required
1670-01-035-6054
Bridle, extraction line bag (for DES)
1
4030-00-090-5354
Clevis, large
9
4030-00-678-8562
Clevis, medium
6
8305-00-880-8155
Cloth coated, green, 60-inch
As required
4020-00-240-2146
Cord, nylon, type III, 550-lb
As required
1670-00-434-5782
Coupling, airdrop, extraction force transfer with cable,
24-ft
1
1670-00-360-0328
Cover, Clevis, large
4
8135-00-664-6958
Cushioning material, packaging, cellulose wadding
As required
5365-00-937-0147
D-ring, heavy-duty, 10,000-lb
24
8305-00-958-3685
Felt, 1/2-in thick
As required
1670-00-003-4391
Knife, miniature, cutter (for DES)
1
1670-01-183-2678
Leaf, extraction line (line bag)(add 1
f
2
Line, drogue (for DES
)
1670-01-064-4452
60-ft (1-loop), type XXV I
1
Line, extraction
:
1670-01-062-6313
For C-130: 60-ft (3-loop), type XXV I
1
1670-01-107-7651
For C-141, C-5, C-17: 140-ft (3-loop), type XXV I
1
Link Assembly:
T
wo-point:
5306-00-435-8994
Bolt, 1-in diam, 4-in long (add 2 for DES
)
(2
)
5310-00-232-5165
Nut, 1-in, hexagonal (add 2 for DES
)
(2
)
1670-00-003-3454
Plate, side, 5 1/2-in
(2
)
1670-00-003-1953
Plate, side, 3 3/4-in (for DES
)
(2
)
5365-00-007-3414
Spacer, large (add 2 for DES
)
(2
)
1670-01-307-1055
Three-point
2
1670-01-483-8259
Link, tow release mechanism (H-Block) C-17 aircraft
1
5510-00-220-6146
Lumber, 2- by 4- by 96-in:
4
5510-00-220-6148
Lumber, 2- by 6 by 96-in:
3
5315-00-010-4659
Nail, steel wire, 8d
As required
3-33
FM 4-20.137/TO 13C7-1-19
Table 3-1. Equipment Required for Rigging Three 500-Gallon Drums with Pump and Separator
(continued)
National Stock
Number
Item
Quantity
1670-00-753-3928
Pad, energy-dissipating (honeycomb), 3- by 36- by 96-in
30 sheets
Parachute:
Cargo:
1670-01-016-7841
G-11B
4
Cargo extraction:
1670-00-040-8135
28-ft
1
Drogue (for DES
)
1670-01-063-3715
15-ft
1
Platform, airdrop, type V, 24-ft:
1670-01-353-8425
Bracket assembly, coupling
(1
)
1670-01-162-2372
l
(53
)
1670-01-162-2376
Extraction bracket assembly
(1
)
1670-01-247-2389
Bracket, suspensio n
(8
)
1670-01-162-2381
T
andem link assembly (Multipurpose
l
(2
)
5530-00-128-4981
Plywood, 3/4-in
4
sheets
1670-01-097-8817
Release, cargo parachute, M-2
1
Sling, cargo, airdrop
For suspension and
l
1670-01-062-6306
3-ft (4-loop), type XXVI nylon webbing
6
1670-01-062-6305
9-ft (4-loop), type XXVI nylon webbing
2
1670-01-062-6308
16-ft (4-loop), type XXVI n
l
2
1670-01-064-4453
20-ft (4-loop), type XXVI n
l
2
For deployment:
1670-01-062-6304
9-ft (2-loop), type XXVI nylon webbing
1
For riser extension:
1670-01-062-6313
60-ft (3-loop), type XXVI n
l
4
5340-00-040-8219
Strap, parachute release, multi-cut, comes w/ 2
knives
2
7510-00-266-5016
T
ape, adhesive, 2-in
As required
1670-00-266-6710
T
ape, masking, 2-in
As required
1670-00-937-0271
Tie-down assembly, 15-foot
53
8310-00-917-3945
Thread, Cotton, Ticket 8/7
As required
Webbing:
8305-00-268-2411
Cotton, 1/4-in, type I
As required
8305-00-082-5752
Nylon, tubular, 1/2-in
As required
8305-00-263-3591
Nylon, Type V
I
As required
3-34
FM 4-20.137/TO 13C7-1-19
SECTION II - RIGGING FOUR 500-GALLON DRUMS
DESCRIPTION OF LOAD
3-24. The four collapsible drums are rigged on a 28-foot platform with five G-11
cargo parachutes. Each drum is filled with a maximum of 432 gallons of liquid.
When empty, each drum weighs 250 pounds and is 62 inches long and 53 inches
in diameter. The 350-GPM pump with filter/separator and hose box are accom-
panying loads. The total rigged load has a maximum rigged weight of 25,700
pounds with a width of 108 inches and a length of 372 inches. It has an over-
hang of 18 inches in the front and 9 inches in the rear. The load has a center of
balance of 172 inches from the front of the platform.
Notes: 1. For drums filled with liquid other than water, use Table 1-1 to
recompute the weight.
2. If the load varies from the one shown, the weght, height, CB, tipoff
curve, and parachute requirements must be recomputed.
3. Do not pressurze drums with air.
PREPARING PLATFORM
3-25. Prepare a 28-foot type V airdrop platform using two tandem links, eight
suspension brackets, and 68 tie-down clevises as shown in Figure 3-23.
Notes: 1. The nose bumper may or may not be installed.
2. Measurements given in this section are from the front edge of the
platform, NOT from the front edge of the nose bumper.
3-35
FM 4-20.137/TO 13C7-1-19
CLEVISES 28A THROUGH 1A
FRONT
REAR
CLEVISES 28 THROUGH 1
Steps:
1. Inspect, or assemble and inspect, the platform as outlined in TM 10-1670-268-
20&P/TO 13C7-52-22.
2. Install a tandem link on the front of each platform side rail using holes 1, 2, and 3.
3. Install a suspension bracket to bushings 6, 7, and 8 on each platform side rail.
4. Install a suspension bracket to bushings 22, 23, and 24 on each platform side rail.
5. Install a suspension bracket to bushings 33, 34, and 35 on each platform side rail.
6. Install a suspension bracket to bushings 49, 50, and 51 on each platform side rail.
7. Install a tie-down clevis to bushing 4 of each tandem link.
8. Install a tie-down clevis to bushings 1 and 4 of each first suspension bracket.
9. Install a tie-down clevis to bushings 2, 3, and 4 of each second suspension bracket.
10. Install a tie-down clevis to bushings 1, 2, and 3 of each third suspension bracket.
11. Install a tie-down clevis to bushing 3 of the fourth suspension bracket.
12. Starting at the front of each platform side rail, install a tie-down clevis to the
bushings bolted to holes 10, 11, 13, 14, 18, 26, 31, 42, 43, 46 (doubled), 47, 52
(tripled), 53, 54, and 56 (doubled).
13. Starting at the front of the platform, number the clevises bolted to the right side
from 1 through 28 and those bolted to the left side from 1A through 28A.
14. Number the clevis on bushing 46 as clevis 20, and 20A and the doubled clevis as
19 and 19A.
15. Number the clevis on bushing 56 as clevis 28, and 28A and the doubled clevis as
27 and 27A.
Figure 3-23. Platform Prepared
3-36
FM 4-20.137/TO 13C7-1-19
PREPARING HONEYCOMB

3-26. Build honeycomb stacks as shown in Figure 3-2 and Figures 3-24 and 3-
25.
STACK 2
96” X 22 1/2”
HONEYCOMB
STACKS 3-9
96” X 36”
HONEYCOMB
Stack
Width
Length
Numbe r
Pieces
(Inches)
(Inches)
Material
Instructions
1
Prepare as shown in Figure 3-2.
2
2
96
22 1/2
Honeycomb
Glue
l
-
2
96
36
Honeycomb
Glue
l
Figure 3-24. Honeycomb Stacks 1 through 9 Prepared
3-37
FM 4-20.137/TO 13C7-1-19
STACK 10
56” X 36”
56” X 28”
HONEYCOMB
HONEYCOMB
56” X 28”
HONEYCOMB
56” X 36”
HONEYCOMB
t
Width
Length
Numbe r
Pieces
(Inches
)
(Inches
)
Material
Instru
t
10
10
56
36
Honeycomb
Form a stack of 10
l
56 x 36-inch piece of honeycomb and a
56 x 28-inch piece of honeycomb side
by side. Alternate and glue the pieces
to the previous
l
10
56
28
Honeycomb
Same as above.
Figure 3-25. Honeycomb Stack 10 Prepared
3-38
FM 4-20.137/TO 13C7-1-19
POSITIONING HONEYCOMB STACKS
3-27. Position honeycomb stacks as shown in Figure 3-26.
STACK 10
STACK 1
STACKS
9 THROUGH 3
STACK 2
1
Center stack 1 on the front edge of the platform.
2
Center stack 9 on the rear edge of the platform.
3
Place stack 8 against and in front of stack 8.
4
Place stack 7 against and in front of stack 8.
5
Place stack 6 against and in front of stack 7.
6
Place stack 5 against and in front of stack 6.
7
Place stack 4 against and in front of stack 5.
8
Place stack 3 against and in front of stack 4.
9
Place stack 2 against and in front of stack 3.
10
Center stack ten 172 inches from the front edge of the platform. Ensure the 64-
inch length is aligned with the platform side rails.
Figure 3-26. Honeycomb Stacks Positioned
3-39
FM 4-20.137/TO 13C7-1-19
BUILDING EQUIPMENT HOSE BOX
3-28. Build the equipment hose box as shown in Figure 3-5.
POSITIONING EQUIPMENT HOSE BOX
3-29. Position the equipment hose box on stack 9 as shown in Figure 3-6.
STORING EQUIPMENT IN THE EQUIPMENT HOSE BOX
3-30. Store the equipment in the equipment hose box as shown in Figure 3-7.
LASHING EQUIPMENT HOSE BOX TO PLATFORM
3-31. Lash the equipment hose box to the platform as shown in Figures 3-27
and 3-28.
1
2
28A
24
28
Note: Ensure lashings 1 and 2 are routed under the load binders on the rear
of the box.
Tie-dow n
Lashing
Clevis
Number
Number
Instructions
1
28 and 24
Route a 30-foot lashing from clevis 28 around the rear of
the equipment hose box, through the left bottom notches
of the box to clevis 24.
2
28A and 24A
Route a 30-foot lashing from clevis 28A around the rear
of the equipment hose box, through the right bottom
notches of the box to clevis 24A
Figure 3-27. Lashings 1 and 2 Installed
3-40
FM 4-20.137/TO 13C7-1-19
3
4
5
27
25
22
Tie-dow n
Lashing
Clevis
Number
Number
Instructions
3
27 and 27A
Route a 15-foot lashing through its ow n D-ring on clevis
27, around the front top cutouts and load bind on clevis
27A
4
25 and 25A
Route a 15-foot lashing through its ow n D-ring on clevis
25, around the rear bottom cutouts and load bind on
clevis 25A
5
22 and 22A
Route a 30-foot lashing through the rear top cutouts of
the equipment hose box. Ensure the lashing is routed
under the load binders on the rear of the box. Load bind
to clevises 22 and 22A
Figure 3-28. Lashings 3 through 5 Installed
3-41
FM 4-20.137/TO 13C7-1-19
PREPARING AND POSITIONING FUEL SEPARATOR
3-32. Prepare and position the fuel separator as shown in Figure 3-10.
LASHING FUEL SEPARATOR TO PLATFORM
3-33. Lash the fuel separator to the platform as shown in Figure 3-29.
6
8
23
20
Tie-dow n
Lashing
Clevis
Number
Number
Instructions
6
23
Route a 15-foot lashing around the front right middle
cross member.
7
23A
Route a 15-foot lashing around the front left middle cross
member.
8
20
Route a 15-foot lashing around the right rear middle
cross member.
9
20A
Route a 15-foot lashing around the left rear middle cross
member.
Figure 3-29. Lashings 6 through 9 Installed
3-42
FM 4-20.137/TO 13C7-1-19
POSITIONING AND LASHING THE DRUMS
3-34. Position and lash the fuel drums to the platform as shown in Figures 3-30
through 3-35.
REAR
FRONT
SEPARATOR
DRUM
DRUM
STACK 10
STACK 1
1
Place a platform clevis on one end of two 9-foot (2-loop), type XXVI nylon web-
bing slings. Attach the slings to each side of the drum (for lifting purposes only)
and remove after the drum is positioned (not shown).
2
Position the rear drum next to the fuel separator and centered on the platform.
Stack 10 may need to be moved for placement. There should be 6 inches between
the drum and the separator.
3
Position the front drum in front of stack 10 centered on the platform. There
should be 6 inches between the drum and stack 1.
Figure 3-30. Front and Rear Drums Positioned
3-43
FM 4-20.137/TO 13C7-1-19
10
12
18
14
16
21
19
17
16
Tie-dow n
Lashing
Clevis
Number
Number
Instructions
10
Route a lashing from the front shackle of the rear drum
to the rear shackle of the front drum on the right side.
11
Route a lashing from the front shackle of the rear drum
to the rear shackle of the front drum on the left side.
12
21
Route a lashing through the right rear shackle of the rear
drum
13
21A
Route a lashing through the left rear shackle of the rear
drum
14
19
Route a lashing through the right rear shackle of the rear
drum
15
19A
Route a lashing through the left rear shackle of the rear
drum
16
17
Route a lashing through the right front shackle of the
rear drum
17
17A
Route a lashing through the left front shackle of the rear
drum
18
16
Route a lashing through the right front shackle of the
rear drum
19
16A
Route a lashing through the left front shackle of the rear
drum
Figure 3-31. Lashings 10 through 19 Installed
3-44
FM 4-20.137/TO 13C7-1-19
22
26
20
24
10
9
5
4
Tie-dow n
Lashing
Clevis
Number
Number
Instructions
20
9
Route a lashing through the right rear shackle of the
front drum
21
9A
Route a lashing through the left rear shackle of the front
drum
22
10
Route a lashing through the right rear shackle of the
front drum
23
10A
Route a lashing through the left rear shackle of the front
drum
Route a lashing through the right front shackle of th e
24
5
front drum
Route a lashing through the left front shackle of the fron t
25
5A
drum
Route a lashing through the right front shackle of th e
26
4
front drum
Route a lashing through the left front shackle of the fron t
27
4A
drum
Figure 3-32. Lashings 20 through 27 Installed
3-45
FM 4-20.137/TO 13C7-1-19
TOP REAR DRUM TOP FRONT DRUM
STACK 10
1
Position the top rear drum to the rear of stack 10.
2
Position the top front drum to the front of stack 10. Ensure each drum is equally
placed on stack 10.
Figure 3-33. Top Rear and Top Front Drums Positioned
3-46
FM 4-20.137/TO 13C7-1-19
28
34
32
30
18
17
12
11
Tie-dow n
Lashing
Clevis
Number
Number
Instructions
28
18
Route a lashing through the right rear shackle of the top
rear drum
29
18A
Route a lashing through the left rear shackle of the top
rear drum
30
17
Route a lashing through the right rear shackle of the top
rear drum
31
17A
Route a lashing through the left rear shackle of the top
rear drum
32
12
Route a lashing through the right front shackle of the top
rear drum
33
12A
Route a lashing through the left front shackle of the top
rear drum
34
11
Route a lashing through the right front shackle of the top
rear drum
35
11A
Route a lashing through the left front shackle of the top
rear drum
Figure 3-34. Lashings 28 through 35 Installed
3-47
FM 4-20.137/TO 13C7-1-19
36
40
38
42
14
13
7
6
Tie-dow n
Lashing
Clevis
Number
Number
Instructions
36
14
Route a lashing through the right rear shackle of the top
front drum
37
14A
Route a lashing through the left rear shackle of the top
front drum
38
13
Route a lashing through the right rear shackle of the top
front drum
39
13A
Route a lashing through the left rear shackle of the top
front drum
40
6
Route a lashing through the right front shackle of the top
front drum
41
6A
Route a lashing through the left front shackle of the top
front drum
42
7
Route a lashing through the right front shackle of the top
front drum
43
7A
Route a lashing through the left front shackle of the top
front drum
Figure 3-35. Lashings 36 through 43 Installed
3-48
FM 4-20.137/TO 13C7-1-19
PREPAING AND POSITIONING THE PUMP
3-35. Prepare the pump according to paragraph 2-5 and as shown in Figure 2-8.
Position the pump as shown in Figure 3-14.
LASHING THE PUMP TO THE PLATFORM
3-36. Lash the pump to the platform as shown in Figure 3-36.
46
48
44
3
2
1
Tie-dow n
Lashing
Clevis
Number
Number
Instructions
44
3
Route a lashing through the right rear tiedow n point.
45
3A
Route a lashing through the left rear tiedow n point.
46
2
Route a lashing through the right front tiedow n point.
47
2A
Route a lashing through the left front tiedow n point.
48
1
Route a lashing around the right side frame.
49
1A
Route a lashing around the left side frame.
50
8
Route a lashing through the right rear tiedow n point (not
show n).
51
8A
Route a lashing through the right rear tiedow n point.
Figure 3-36. Lashings 44 through 51 Installed
3-49
FM 4-20.137/TO 13C7-1-19
COVERING THE PUMP
3-37. Place a canvas cover over the pump as shown in Figure 3-16. Position the
pump as shown in Figure 3-14.
INSTALLING SUSPENSION SLINGS AND SAFETY TIES
3-38. Install suspension slings and safety ties as shown in Figure 3-37.
6
5
8
4
1
3
2
1
Attach a 16-foot (4-loop), type XXVI nylon webbing sling to each front suspension bracket
with a large clevis.
2
Attach a 3-foot (4-loop), type XXVI nylon webbing sling to each second and third suspen-
sion bracket with a large suspension clevis.
3
Place the 3-foot slings on each side of the load in the bell of a large suspension clevis.
4
Bolt a 9-foot (4-loop), type XXVI nylon webbing sling to each large suspension clevis. Tie
the large suspension clevises to both top drums with type III nylon cord (not shown).
5
Join the front and center suspension slings together with a 3-point link on each side of
the load.
6
Attach a 3-foot (4-loop), type XXVI nylon webbing sling to the top point on the 3-point
links.
7
Pad and tape the link assemblies (not shown).
8
Attach a 20-foot (4-loop), type XXVI nylon webbing sling to each rear suspension bracket
with a large suspension clevis.
9
Raise the suspension slings and install the suspension sling safety ties as shown in Appen-
dix A, to the front and rear suspension slings, six to eight inches above the highest point
of the load (not shown).
Figure 3-37. Suspension Slings and Safety Ties Installed
3-50
FM 4-20.137/TO 13C7-1-19
BUILDING AND POSITIONING PARACHUTE STOWAGE PLATFORM
3-39. Build and stow the parachute stowage platform as shown in Figure 3-38.
Align the rear edge of the stowage platform on the rear edge of the box.
96”
2” x 6” x 85”
2”
LUMBER
22”
48”
3/4” PLYWOOD
22”
2” x 6” x 85”
LUMBER
2”
2”
2” HOLES
2” x 6” x 48” LUMBER
52
26
Tie-dow n
Lashing
Clevis
Number
Number
Instructions
52
26
Route a lashing from clevis 26 through the rear and
center right holes of the stowage platform
53
26A
Route a lashing from clevis 26A through the rear and
center left holes in the stowage platform
Figure 3-38. Parachute Stowage Platform Built and Positioned
3-51
FM 4-20.137/TO 13C7-1-19
PREPARING AND STOWING CARGO PARACHUTES
3-40. Prepare and stow cargo parachutes as shown in Figure 3-39.
1
3
2
1
Prepare and position five G-11 parachutes according to FM 4-20.102/NAVSEA
SS400-AB-MMO-010/TO 13C7-1-5.
2
Restrain the parachutes using bushings 55 and 55A on the platform and bushings
4 and 4A on the rear suspension link.
3
Install the multicut parachute release strap according to FM 4-20.102/NAVSEA
SS400-AB-MMO-010/TO 13C7-1-5.
Figure 3-39. Parachute Stowage Platform Built and Positioned
3-52
FM 4-20.137/TO 13C7-1-19
INSTALLING THE EXTRACTION SYSTEM
3-41. Install the extraction system as shown in Figure 3-40.
1
3
2
1
Install the extraction force transfer coupling according to FM 4-20.102/NAVSEA
SS400-AB-MMO-010/TO 13C7-1-5.
2
Install a 9-foot (2-loop), type XXVI nylon sling as the deployment line.
3
Use the rear mounting holes for the EFTC actuator mounting bracket and a 28-
foot cable.
Figure 3-40. Extraction System Installed
3-53
FM 4-20.137/TO 13C7-1-19
INSTALLING THE PARACHUTE RELEASE SYSTEM
3-42. Install the parachute release system as shown in Figure 3-41.
2
1
3
1
Place and secure a 96- by 24-inch piece of honeycomb from the separator to the
top of the top rear drum.
2
Position and secure the M-2 parachute release assembly on the honeycomb.
Attach the suspension slings and the parachute riser extensions to the M-2
parachute release assembly according to FM 4-20.102/NAVSEA SS400-AB-
MMO-010/TO 13C7-1-5.
3
S-fold and tie any slack in the suspension slings with type I, 1/4-inch cotton
webbing. Tie the riser extentions together with type I, 1/4-inch cotton webbing.
Figure 3-41. Parachute Release Assembly Installed
3-54
FM 4-20.137/TO 13C7-1-19
PLACING EXTRACTION PARACHUTE
3-43. Select the extraction parachute and extraction line needed using the
extraction line requirements table in FM 4-20.102/NAVSEA SS400-AB-MMO-
010/TO 13C7-1-5. Rig the extraction line in an extraction line bag according to
TM 10-1670-286-20/TO 13C5-2-41. Place the extraction parachute and extrac-
tion line on the load for installation in the aircraft.
INSTALLING PROVISIONS FOR EMERGENCY RESTRAINTS
3-44. Select and install the provisions for emergency aft restraints according to
the emergency aft restraint requirements table in FM 4-20.102/NAVSEA SS400-
AB-MMO-010/TO 13C7-1-5.
MARKING RIGGED LOAD
3-45. Mark the rigged load according to FM 4-20.102/NAVSEA SS400-AB-MMO-
010/TO 13C7-1-5 and as shown in Figure 3-42. Complete Shipper’s Declaration
for Dangerous Goods and affix to the load. If the load varies from the one
shown, the weight, height, CB, tipoff curve, and parachute requirements must
be recomputed.
EQUIPMENT REQUIRED
3-46. Use the equipment list in Table 3-2 to rig the load shown in Figure 3-42.
3-55
FM 4-20.137/TO 13C7-1-19
CAUTION:
Make the final inspection required by FM 4-20.102/NAVSEA
SS400-AB-MMO-010/TO 13C7-1-5 before the load leaves
the rigging site.
CB
RIGGED LOAD DATA
Weight
24,408 pounds
Maximum Weight
25,700 pounds
Height
89 inches
Width
108 inches
Overall Length
363 inches
Overhang: Front ( Tongue of Pump)
9 inches
Rear (EFTC)
18 inches
Center of Balance (CB) (from front edge of platform)
172 inches
Extraction System
EFTC
Figure 3-42. Four 500-Gallon Drums with Pump and Separator Rigged for Low- Velocity Airdrop
3-56
FM 4-20.137/TO 13C7-1-19
Table 3-2. Equipment Required for Rigging Four 500-Gallon Drums with Pump and Separator
3-57
FM 4-20.137/TO 13C7-1-19
Table 3-2. Equipment Required for Rigging Four 500-Gallon Drums with Pump and Separator
(continued)
National Stock
Numbe r
Item
Quantity
1670-00-753-3928
Pad, energy-dissipating (honeycomb), 3- by 36- by 96-in
30 sheets
Parachute:
Cargo:
1670-01-016-7841
G-11C
5
Cargo extraction:
1670-00-040-8135
28-ft
1
Drogue (for DES
)
1670-01-063-3715
15-ft
1
Platform, airdrop, type V, 28-ft:
1670-01-353-8425
Bracket assembly, coupling
(1
)
1670-01-162-2372
l
(68
)
1670-01-162-2376
Extraction bracket assembly
(1
)
1670-01-247-2389
Bracket, suspensio n
(8
)
1670-01-162-2381
T
andem link assembly (Multipurpose
l
(2
)
5530-00-128-4981
Plywood, 3/4-in
4
sheets
1670-01-097-8817
Release, cargo parachute, M-2
1
Sling, cargo, airdrop
For suspension and
l
1670-01-062-6306
3-ft (4-loop), type XXVI nylon webbing
6
1670-01-062-6305
9-ft (4-loop), type XXVI nylon webbing
2
1670-01-062-6308
16-ft (4-loop), type XXVI n
l
2
1670-01-064-4453
20-ft (4-loop), type XXVI n
l
2
For deployment:
1670-01-062-6304
9-ft (2-loop), type XXVI nylon webbing
1
For riser extension:
1670-01-062-6311
120-ft (2-loop), type XXVI n
l
5
5340-00-040-8219
Strap, parachute release, multi-cut, comes w/ 2
knives
2
7510-00-266-5016
T
ape, adhesive, 2-in
As required
1670-00266-6710
T
ape, masking, 2-in
As required
1670-00-937-0271
Tie-down assembly, 15-foot
68
8310-00-917-3945
Thread, Cotton, Ticket 8/7
As required
Webbing:
8305-00-268-2411
Cotton, 1/4-in, type I
As required
8305-00-082-5752
Nylon, tubular, 1/2-in
As required
8305-00-263-3591
Nylon, Type V
I
As required
3-58
FM 4-20.137/TO 13C7-1-19
SECTION III- RIGGING FIVE 500-GALLON DRUMS
DESCRIPTION OF LOAD
3-47. The five collapsible fuel drums are rigged on a 32-foot, type V platform
with six G-11 cargo parachutes. Each drum is filled with 432 gallons of liquid.
When empty, each drum weighs 250 pounds and is 62 inches long and 53 inches
in diameter. The five drums also have a 350-GPM pump with a separator and
hose box as an accompanying load. The total rigged load has a maximum weight
of 30,355 pounds with a width of 108 inches and length of 411 inches. It has an
overhang of 18 inches in the front and 18 inches in the rear.
Notes: 1. For drums filled with a liquid other than water, use Table 1-1 to
recompute the weight.
2. If the load varies from the one shown, the weight, height, CB, tipoff
curve, and parachute requirements must be recomputed.
3. Do not pressurize drums with air.
PREPARING PLATFORM
3-48. Prepare a 32-foot type V airdrop platform using two tandem links, eight
suspension brackets and 72 tie-down clevises as shown in Figure 3-43.
Notes: 1. The nose bumper may or may not be installed.
2. Measurements given in this section are from the front edge of the
platform, NOT from the front edge of the nose bumper.
3-59

Content      ..     3      4      5      6     ..
