Главная Manuals FM 4-20.158 AIRDROP OF SUPPLIES AND EQUIPMENT: RIGGING WATER PURIFICATION UNITS (MAY 2005)
|
|
|
FM 4-20.158/TO 13C7-7-61
11
13
12
15
11
8

Lashing
Tiedown Clevis
Instructions
Number
Number
11

15 and 15A
Route a 15-foot lashing through clevis 15 and through its own D-ring.
Route it to the top of equipment box 3. Route a 15-foot lashing
through clevis 15A and through its own D-ring. Route it to the top of
equipment box 3. Secure the lashing with the lashing from clevis 15
on top of equipment box 3 with two D-rings and a load binder.
12
11 and 11A
Route a 15-foot lashing through clevis 11 and through its own D-ring.
Route the lashing to the rear right bottom cutout of equipment box 3.
Route a 15-foot lashing through clevis 11A and through its own D-
ring. Route the lashing to the rear left bottom cutout of equipment box
3. Secure the lashing with the lashing from clevis 11 centered on the
rear of equipment box 3 with two D-rings and a load binder.
13
8 and 8A
Form a 45-foot lashing. Route a free end through clevis 8 and the
other free end through clevis 8A. Route the lashing through the rear
top cutouts of equipment box 3. Secure the lashing centered on the
rear of equipment box 3 with two D-rings and a load binder.
Figure 2-33. Lashings Installed (Continued)
2-54
11 May 2005
FM 4-20.158/TO 13C7-7-61

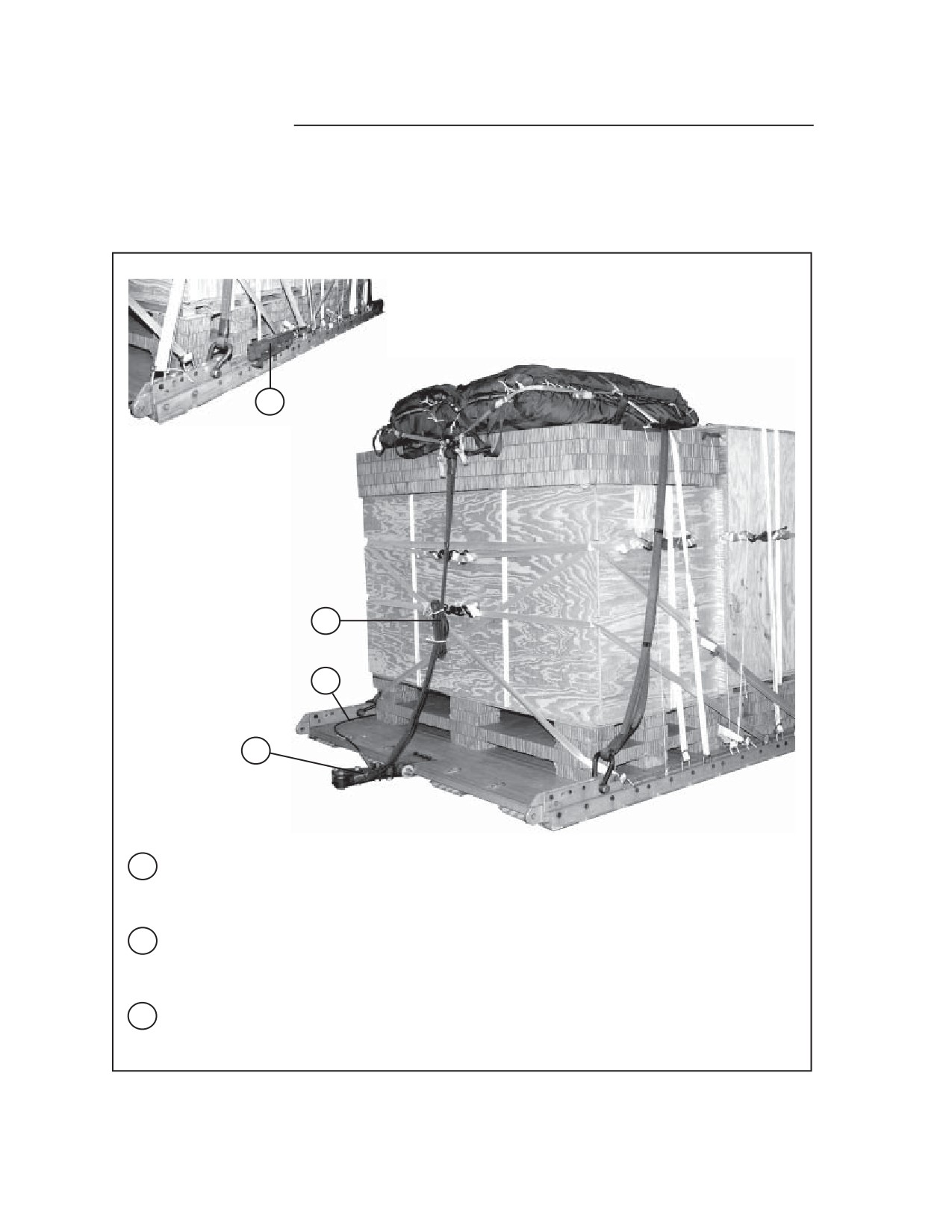

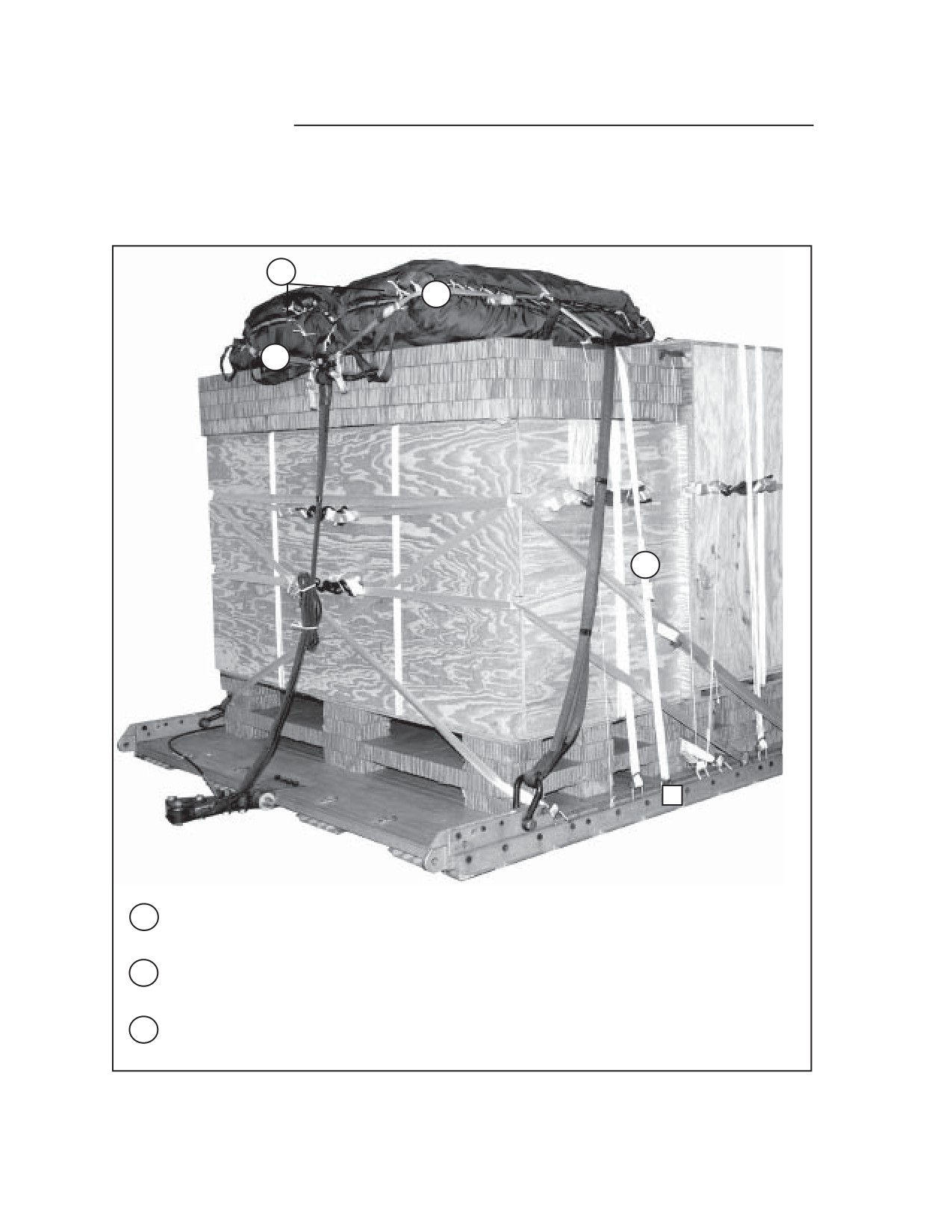

POSITIONING THE ATTITUDE CONTROL BAR (ACB) AND
INSTALLING SUSPENSION SLINGS AND SAFETY TIE
2-16. Position the ACB and install the suspension slings and safety tie as shown in
Figure 2-34.
2
3
1
REAR
FRONT
1
Position and center the ACB on top of equipment box 1 with the attaching holes facing
toward the rear of the platform.
2
Attach a 16-foot (2-loop), type XXVI nylon suspension sling to each tandem link with a
large clevis. Route the opposite end of the front slings up through the ACB ends.
Extend the slings upward to position the ACB.
3
Pad the front suspension slings with felt and tape in place 24 inches below the ACB to
a point 6 inches above the top of the ACB. Extend the tape beyond the top and bottom
of the felt to secure in place.
Figure 2-34. ACB, Suspension Slings and Safety Tie Positioned and Installed
2-55
11 May 2005
FM 4-20.158/TO 13C7-7-61
4
5
6
8
5
4
7
7
REAR
FRONT
1
9
4
Route a 15-foot lashing through clevis 1, up through the front inside of the hole of the
ACB, around the front, and back to clevis 1. Connect the lashing using a D-ring and
load binder but do not tighten at this time. Repeat for clevis 1A on the left side.
5
Route a 15-foot lashing through clevis 9, up through the rear inside of the hole of the
ACB, around the rear, and back to clevis 9. Connect the lashing using a D-ring and load
binder but do not tighten at this time. Repeat for clevis 9A on the left side.
6
At this point tighten all lashings at the same time.
7
Safety tie each front suspension sling to the ACB using type III nylon cord.
8
Make a suspension sling safety tie between the rear suspension slings only using 1/2-
inch tubular nylon webbing according to the Appendix at the rear of this manual.
Figure 2-34. ACB, Suspension Slings and Safety Tie Positioned and Installed (Continued)
2-56
11 May 2005
FM 4-20.158/TO 13C7-7-61

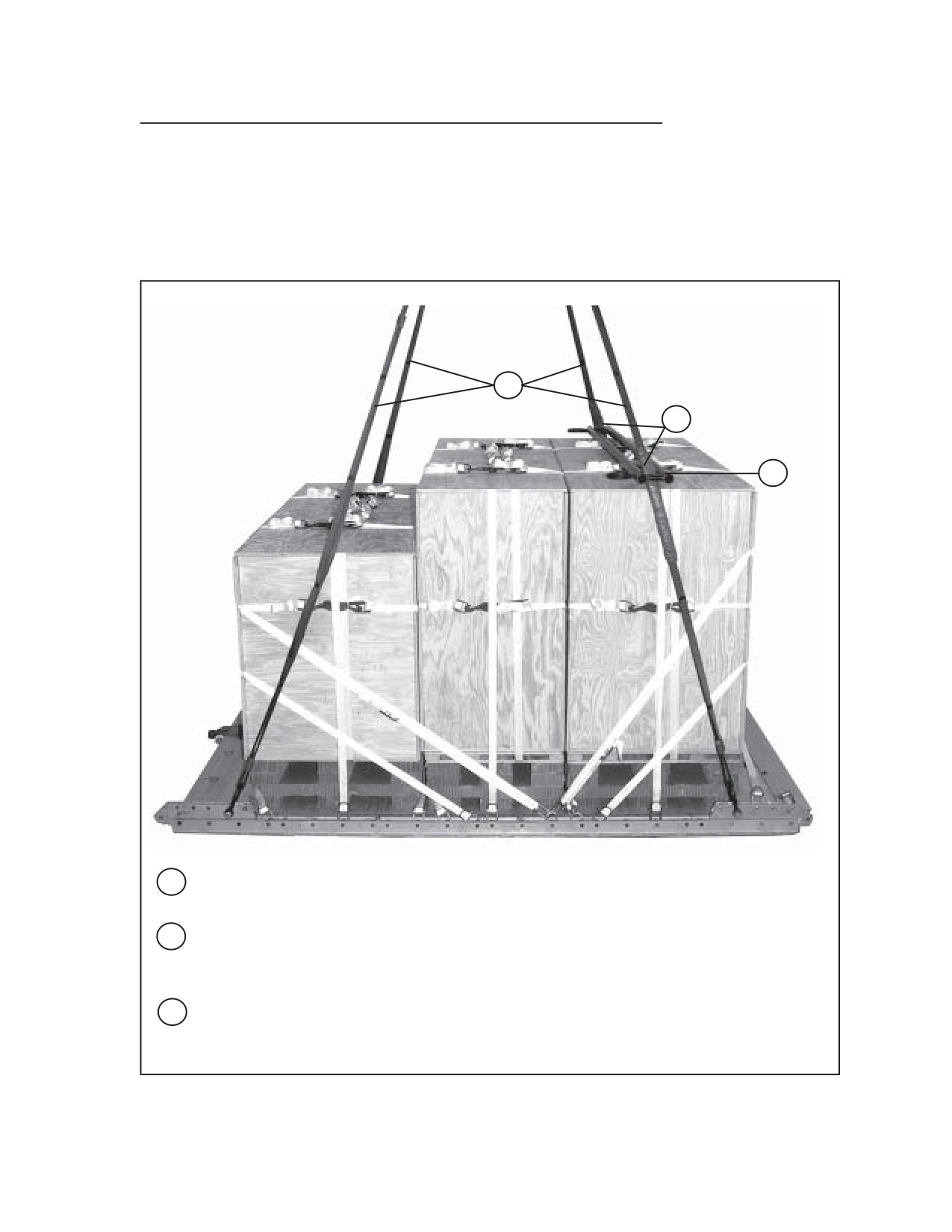

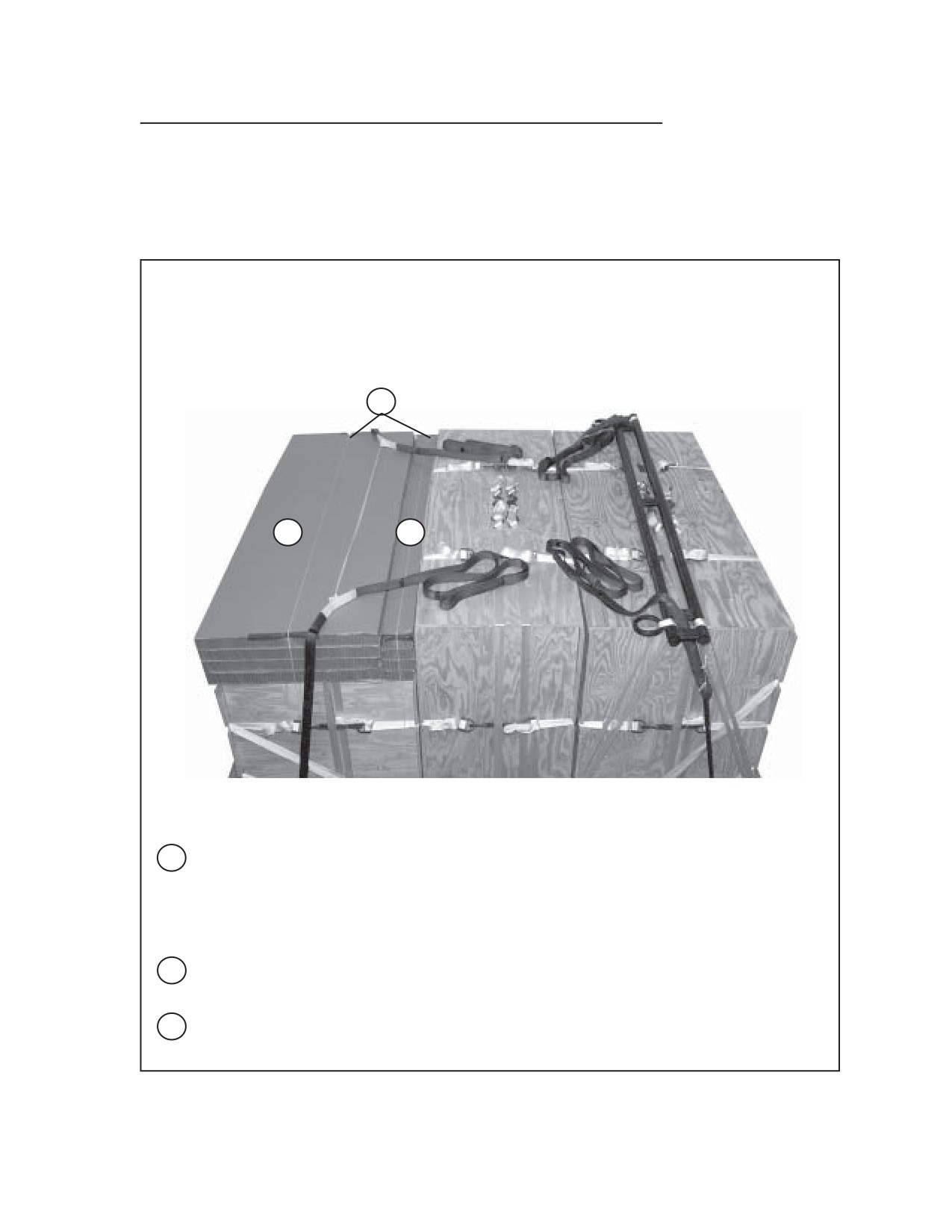

BUILDING AND POSITIONING PARACHUTE STOWAGE PLATFORM
2-17. Build and position the parachute stowage platform as shown in Figure 2-35.
Note: Make sure the safety tie and suspension slings are on top of the parachute stowage
platform.
3
1
2
1
Prepare a parachute platform by cutting and positioning a 36- by 96-inch piece of
honeycomb on top of equipment box 3 flush with the rear edge. Make cutouts in this
piece where it comes in contact with the lashings on top of equipment box 3. Place three
additional pieces of 36- by 96-inch pieces on top of the first piece. Tape the 36-inch side
with 2-inch adhesive tape.
2
Cut and position four 6- by 96-inch pieces of honeycomb to the front of the 36- by 96-inch
pieces of honeycomb previously placed. Tape the 6-inch side with 2-inch adhesive tape.
3
Secure the parachute platform to the bushings on the type V platform on each side
using type III nylon cord.
Figure 2-35. Parachute Stowage Platform Built and Positioned
2-57
11 May 2005
FM 4-20.158/TO 13C7-7-61

PREPARING AND STOWING CARGO PARACHUTES
2-18. Prepare and stow the cargo parachutes as shown in Figure 2-36.
1
3
3
2
14
1
Prepare, position and stow two G-11B cargo parachutes on the parachute stowage
platform according to FM 4-20.102/NAVSEA SS400-AB-MMO-010/TO 13C7-1-5.
2
Using type VIII nylon webbing install the cargo parachute restraint to clevises 14 and
14A according to FM 4-20.102/NAVSEA SS400-AB-MMO-010/TO 13C7-1-5.
3
Install the parachute release straps according to FM 4-20.102/NAVSEA SS400-AB-
MMO-010/TO 13C7-1-5.
Figure 2-36. Cargo Parachutes Prepared and Stowed
2-58
11 May 2005
FM 4-20.158/TO 13C7-7-61
INSTALLING THE RELEASE SYSTEM
2-19. Prepare, attach and safety an M-1 cargo parachute release according to FM
4-20.102/NAVSEA SS400-AB-MMO-010/TO 13C7-5-1 and as shown in Figure 2-
37.
4
4
2
3
3
4
1
4
1
Center a 15- by 18-inch piece of honeycomb to the rear of the ACB. Tape the edges of the
piece of honeycomb. Secure the honeycomb to the load using two lengths of type III cord.
2
Prepare and install the M-1 cargo parachute release according to FM 4-20.102/
NAVSEA SS400-AB-MMO-010/TO 13C7-1-5. Center the assembly on top of honeycomb.
3
S-fold and tie any excess in the suspension slings using one turn single type I, 1/4-inch
cotton webbing.
4
Safety tie the M-1 cargo parachute release to convenient bushings on the type V
platform using type III nylon cord according to FM 4-20.102/ NAVSEA SS400-AB-
MMO-010/TO 13C7-1-5.
Figure 2-37. Cargo Parachute Release Installed
2-59
11 May 2005
FM 4-20.158/TO 13C7-7-61
INSTALLING THE EXTRACTION SYSTEM
2-20. Install the extraction system as shown in Figure 2-38.
LEFT
1
3
2
1
REAR
1
Install the components of the EFTC according to FM 4-20.102/NAVSEA SS400-AB-MMO-
010/TO 13C7-1-5. Use the front mounting holes on the left side of the platform for the
EFTC brackets.
2
Install a 12-foot EFTC cable according to FM 4-20.102/NAVSEA SS400-AB-MMO-
010/TO 13C7-1-5 and safety the cable to convenient places on the platform with one turn
of type I, 1/4-inch cotton webbing.
3
Attach a 9-foot (2-loop) type XXVI nylon sling according to FM 4-20.102/NAVSEA SS400-
AB-MMO-010/TO 13C7-1-5 to be used as a deployment line. S-fold the excess and tie it in
two places with type I, 1/4-inch cotton webbing.
Figure 2-38. Extraction System Installed
2-60
11 May 2005
FM 4-20.158/TO 13C7-7-61
PLACING EXTRACTION PARACHUTE
2-21. Select the extraction parachute and extraction line needed using the extraction
line requirements table in FM 4-20.102/ NAVSEA SS400-AB-MMO-010/TO 13C7-1-5.
Place the extraction parachute and line on the load for installation in the aircraft.
INSTALLING PROVISIONS FOR EMERGENCY RESTRAINTS
2-22. Select and install the provisions for the emergency aft restraints according to
the emergency aft restraint requirements table in FM 4-20.102/NAVSEA SS400-AB-
MMO-010/TO 13C7-1-5.

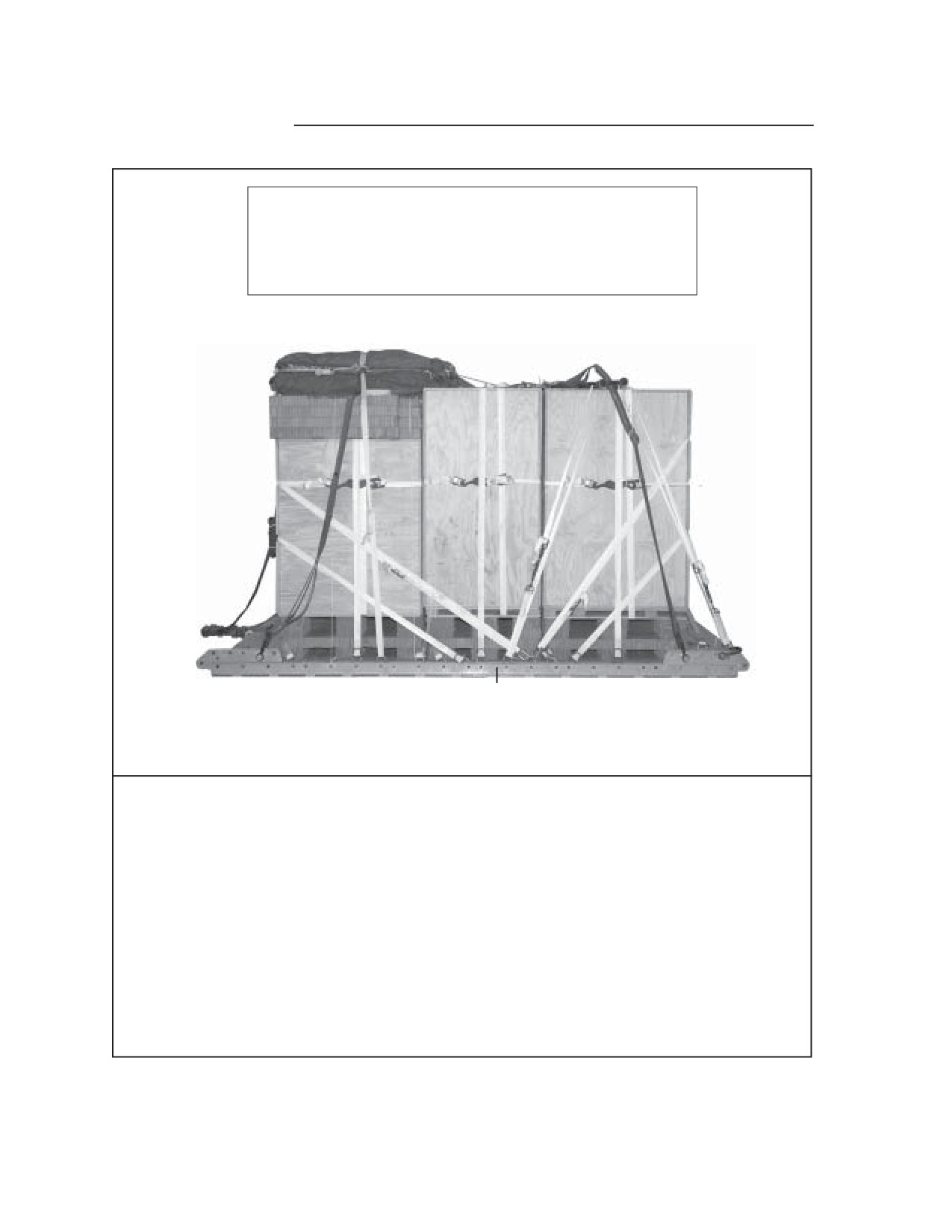

MARKING RIGGED LOAD
2-23. Mark the rigged load according to FM 4-20.102/NAVSEA SS400-AB-
MMO-010/TO 13C7-1-5, and as shown in Figure 2-39. Complete Shipper's
Declaration for Dangerous Goods. If the load varies from the one shown, the weight,
height, CB, and parachute requirements must be recomputed.
EQUIPMENT REQUIRED
2-24. Use the equipment listed in Table 2-1 to rig this load.
2-61
11 May 2005
FM 4-20.158/TO 13C7-7-61
CAUTION
Make the final rigger inspection required by AR 59-4/
OPNAVINST 4630.24C/AFJ 13-210(I)/MCO 13480.1B and
FM 4-20.102/NAVSEA SS400-AB-MMO-010/TO 13C7-1-5
before the load leaves the rigging site.
CB
RIGGED LOAD
Weight:
Load shown:
6,140 pounds
Maximum weight:
6,700 pounds
Height:
92 inches
Width:
108 inches
Length:
144 inches
Overhang:
Front:
N/A
Rear:
18 inches
(EFTC)
CB (from front edge of platform):
70 inches
Figure 2-39. Lightweight Water Purifier (LWP) Rigged on a 12-Foot, Type V Platform for Low-
Velocity Airdrop
2-62
11 May 2005
FM 4-20.158/TO 13C7-7-61
Table 2-1. Equipment Required for Rigging a Lightweight Water Purifier (LWP) on a 12-
Foot, Type V Platform for Low-Velocity Airdrop
Items
Quantity
National Stock
Number
8040-00-273-8713
Adhesive paste, 1-gallon
As required
1670-00-251-1153
A-7A, cargo strap
7
1670-00-003-4389
Bar, attitude control
1
4030-00-678-8562
Clevis, 3/4-inch medium
2
4030-00-090-5354
Clevis, 1-inch large
5
4020-00-240-2146
Cord, nylon, type III, 550-lb.
As required
1670-00-434-5783
Coupling, airdrop extraction force transfer, w/12-ft. cable
1
1670-00-360-0328
Cover, clevis
2
8135-00-664-6958
Cushioning material (Cellulose wadding)
As required
8305-00-958-3685
Felt, 1/2-inch thick
As required
1670-01-183-2678
Leaf, extraction line (line bag) (for C-130)
1
1670-01-183-2678
Leaf, extraction line (line bag) (for C-17)
2
1670-00-003-4391
Knife, parachute bag (for C-17)
1
Line extraction:
1670-01-064-4452
60-foot (1-loop), type XXVI (for C-130)
1
1670-01-107-7652
160-foot (1-loop), type XXVI (for C-17)
1
1670-01-064-4452
60-foot (1-loop), type XXVI (for C-17), (drogue line)
1
Link assembly:
Two-point, 3 3/4-in
5306-00-435-8994
Bolt, 1-in diam, 4-in long (for C-130)
2
5306-00-435-8994
Bolt, 1-in diam, 4-in long (for C-17)
4
5310-00-232-5165
Nut, 1-in, hexagonal (for C-130)
2
5310-00-232-5165
Nut, 1-in, hexagonal (for C-17)
4
1670-00-003-1953
Plate, side, 3 3/4-in (for C-130)
2
1670-00-003-1953
Plate, side, 3 3/4-in (for C-17)
4
5365-00-007-3414
Spacer, large (for C-130)
2
5365-00-007-3414
Spacer, large (for C-17)
4
Lumber:
5510-00-220-6146
2- by 4- by 96-in
As required
2-63
11 May 2005
FM 4-20.158/TO 13C7-7-61
Table 2-1. Equipment Required for Rigging a Lightweight Water Purifier (LWP) on a 12-
Foot, Type V Platform for Low-Velocity Airdrop (Continued)
Items
Quantity
National Stock
Number
5530-00-618-8073
Plywood, 3/4-in
As required
5315-00-010-4659
Nail, steel wire, common, 8d
As required
1670-00-753-3928
Pad, energy dissipating, honeycomb, 3- by 36- by 96-in
40 sheets
Parachute:
Cargo:
1670-01-016-7841
G-11B
2
Parachute, cargo extraction:
1670-00-063-3715
15-ft. (for C-130)
1
1670-00-063-3715
15-ft. (for C-17)
2
Platform, airdrop, type V, 12-ft:
1670-01-162-2372
Clevis assembly
32
1670-01-353-8424
Extraction bracket assembly
1
1670-01-162-2381
Tandem link assembly (multipurpose link)
4
1670-01-097-8816
Release, cargo parachute, M-1
1
Sling, cargo, airdrop:
1670-01-062-6304
9-ft. (2-loop), type XXVI
1
1670-01-063-7761
16-ft. (2-loop), type XXVI
4
1670-01-062-6302
20-ft. (2-loop), type XXVI
2
1670-00-040-8219
Strap, parachute release, multicut
2
7510-00-266-5016
Tape, adhesive, 2-in
As required
7510-00-266-6710
Tape, masking
As required
Textile;
8305-00-433-5986
Cloth, cotton muslin, type III (for C-17)
As required
8310-00-917-3945
Thread, cotton, ticket no 8/7 (for C-17)
As required
1670-00-937-0271
Tiedown assembly, 15-ft.
55
1670-01-483-8259
Towplate release mechanism (h-block) (C-17 only)
1
Webbing:
8305-00-268-2411
Cotton, 1/4-inch, type I
As required
8305-00-082-5752
Nylon, tubular, 1/2-inch
As required
8305-00-268-2455
Nylon, tubular, 1-inch
As required
8305-00-261-8585
Type VIII nylon
As required
2-64
11 May 2005
FM 4-20.158/TO 13C7-7-61
Appendix
INSTALLING SUSPENSION SLING SAFETY TIES
Installing the suspension sling safety ties keeps the suspension slings from making contact with the
load. The procedures in this Appendix are different from those in FM 4-20.102/NAVSEA
SS400-AB-MMO-010/TO 13C7-1-5. An exception to FM 4-20.102/NAVSEA SS400-AB-MMO-
010/TO 13C7-1-5 is granted. The procedures in this Appendix must be followed. Safety tie
the rear suspension slings according to instructions shown below.
1
2
1
Cut two lengths of 1/2-inch tubular nylon webbing, making each long enough to reach
from the left rear suspension sling to the right rear suspension sling plus 8 feet. Split the
plies of the left rear suspension sling. Route two lengths of the 1/2-inch tubular webbing
through the plies of the sling from inboard to outboard about 3 feet.
2
Route the 3 foot running end from outboard to inboard around the inside plies and
around the outboard plies from inboard to outboard. Tie it in place on the inboard side
with three alternating half-hitches with an overhand knot in the running end.
Appendix -1
11 May 2005
FM 4-20.158/TO 13C7-7-61
3
4
4
4
5
3
Split the plies of the right rear suspension sling and route the running ends of the two
lengths of 1/2-inch tubular nylon webbing through the plies of the sling from inboard to
outboard. Pass enough of the webbing through the sling to take the slack out, but not
enough to keep the slings from hanging in their natural position.
4
Route the running end from outboard to inboard around the inside plies and around the
outboard plies from inboard to outboard. Tie it in place on the inboard side with three
alternating half-hitches with an overhand knot in the running end.
5
Tape the webbing to the slings with masking tape.
6
When using four-loop, type XXVI suspension slings, wrap each four plies with a 10-by 10-
inch piece of cotton muslin. Secure each wrap with one single turn of 1/4-inch cotton
webbing (not shown).
Appendix -2
11 May 2005
FM 4-20.158/TO 13C7-7-61
Glossary
ACB
Attitude Control Bar
AFB
Air Force Base
AFMAN
Air Force Manual
AFR
Air Force Regulation
AFTO
Air Force Technical Order
AMC
Air Mobility Command
AR
Army Regulation
attn
attention
BII
basic issue items
CB
center of balance
COEI
components of end items
CWK1
cold weather kit 1
CWK2
cold weather kit 2
CWK3
cold weather kit 3
d
penny
DA
Department of the Army
DD
Department of Defense
EFTC
extraction force transfer coupling
FM
Field Manual
ft
feet
GPH
gallons per hour
HQ
headquarters
in
inch
kw
kilowatt
lb
pound
Glossary-1
11 May 2005
FM 4-20.158/TO 13C7-7-61
LWP lightweight water purifier
MCO Marine Corp Order
NBC nuclear, biological and chemical
no number
JAI joint airdrop inspection
ROWPU reverse osmosis water purification unit
TM technical manual
TO technical order
TRADOC United States Army Training and Doctrine Command
US United States
yd yard
Glossary-2
11 May 2005
FM 4-20-158/TO 13C7-7-61
Bibliography
AFMAN 24-204(I)
Preparing Hazardous Materials for Military Air Shipments.
TM 38-250
14 February 2002.
AR 59-4
Joint Airdrop Inspection Records, Malfunction Investigations
OPNAVINST 4630.24C
and Activity Reporting. 1 May 1998.
AFJ 13-210(I)
MCO 13480.1B
AFTO Form 22
Technical Order Publication Improvement Report.
DA Form 2028
Recommended Changes to Publication and Blank Forms.
February 1974.
FM 4-20.102
Airdrop of Supplies and Equipment: Rigging Airdrop Platforms.
NAVSEA SS400-AB-MMO-010
22 August 2001.
TO 13C7-1-5
TM 10-1670-268-20&P
Operational Maintenance Manual Including Repair Parts and
TO 13C5-52-22
Special Tools List for Type V Platform and Dual Row Airdrop
Platforms. 15 September 2002.
Shipper's Declaration for
Locally Procured Form.
Dangerous Goods
Bibliography-1
11 May 2005
|
