FM 10-450-4 MULTISERVICE HELICOPTER SLING LOAD: SINGLE-POINT LOAD RIGGING PROCEDURES (September 2003) - page 1

  Главная      Manuals     FM 10-450-4 MULTISERVICE HELICOPTER SLING LOAD: SINGLE-POINT LOAD RIGGING PROCEDURES (September 2003)

Search            copyright infringement

Content      ..      1       2         ..

FM 10-450-4 MULTISERVICE HELICOPTER SLING LOAD: SINGLE-POINT LOAD RIGGING PROCEDURES (September 2003) - page 1

FM 10-450-4
AFJMAN 11-223, VOL II
MCRP 4-23E, VOL II
COMDTINST M13482.3A
NWP 3-04.12
MULTISERVICE
HELICOPTER SLING LOAD:
SINGLE-POINT LOAD
RIGGING PROCEDURES
DISTRIBUTION RESTRICTION: APPROVED FOR PUBLIC RELEASE; DISTRIBUTION IS UNLIMITED
HEADQUARTERS
DEPARTMENT OF THE ARMY
UNITED STATES MARINE CORPS
DEPARTMENT OF THE NAVY
DEPARTMENT OF THE AIR FORCE
UNITED STATES COAST GUARD
C3, FM 10-450-4
HEADQUARTERS
DEPARTMENT OF THE ARMY
UNITED STATES MARINE CORPS
DEPARTMENT OF THE NAVY
DEPARTMENT OF THE AIR FORCE
Change 3
UNITED STATES COAST GUARD
Washington, DC, 3 September 2003
MULTISERVICE HELICOPTER SLING LOAD:
SINGLE-POINT RIGGING PROCEDURES
1.
This change adds several items that are certified for sling load in the single-point configuration.
2.
The United States Marine Corps has changed the Short Title of this manual to MCRP 4-11.3E, Vol II. This Short Title will
be included in the next revision of this manual.
3.
The United States Air Force has changed the Publication Number of this manual to AFMAN 11-223(I), Vol II. This
Publication Number will be included in the next revision of this manual.
4. Change FM 10-450-4, 30 May 1998, as follows:
Remove old pages
Insert new pages
iii through xi
iii through xii
2-1 and 2-2
2-1 and 2-2
2-7 and 2-8
2-7 and 2-8
2-23 and 2-24
2-23 and 2-24
2-64.1 and 2-64.2
2-65 and 2-66
2-65 and 2-66
2-73 and 2-74
2-73 and 2-74
2-83
2-83 through 2-89
3-1 and 3-2
3-1 and 3-2
3-29 and 3-30
3-29 and 3-30
3-59 and 3-60
3-59 through 3-64
4-3 and 4-4
4-3 and 4-4
6-1 and 6-2
6-1 and 6-2
6-29
6-29 through 6-31
7-1 and 7-2
7-1 and 7-2
7-15 through 7-17
8-1 and 8-2
8-1 and 8-2
8-52.1 through 8-52.4
8-83 through 8-85
11-1 through 11-4
11-1 through 11-4
11-21 and 11-22
13-11 and 13-12
13-11 and 13-12
14-1 and 14-2
14-1 and 14-2
14-13 through 14-16
A1 and A2
A1 and A2
Glossary-1 and Glossary-2
Glossary-1 and Glossary-2
5. New or changed material is identified by a vertical (
) bar in the margin opposite the changed material.
6. File this transmittal sheet in the front of the publication.
DISTRIBUTION RESTRICTION: Approved for public release; distribution is unlimited.
HEADQUARTERS
DEPARTMENT OF THE ARMY
UNITED STATES MARINE CORPS
DEPARTMENT OF THE NAVY
DEPARTMENT OF THE AIR FORCE
Change 2
UNITED STATES COAST GUARD
Washington, DC, 1 April 2002
MULTISERVICE HELICOPTER SLING LOAD:
SINGLE-POINT RIGGING PROCEDURES
1.
This change adds several items that are certified for sling load in the single-point configuration.
2. The United States Marine Corps has changed the Short Title of this manual to MCRP 4-11.3E, Vol II. This
Short Title will be included in the next revision of this manual.
3. Change FM 10-450-4, 30 May 1998, as follows:
Remove old pages
Insert new pages
iii through xi
iii through xi
1-1 through 1-5
1-1 through 1-5
2-1 and 2-2
2-1 and 2-2
2-9 through 2-12
2-9 through 2-12
2-15 and 2-16
2-15 and 2-16
2-23 and 2-24
2-23 and 2-24
2-41 through 2-44
2-41 through 2-44
2-61 and 2-62
2-61 and 2-62
2-65 through 2-83
3-1 and 3-2
3-1 and 3-2
3-35 and 3-36
3-35 and 3-36
3-53 through 3-60
4-13 and 4-14
4-13 and 4-14
6-17 and 6-18
6-17 through 6-18.3
11-17 and 11-18
11-17 and 11-18
Glossary-1 and Glossary-2
Glossary-1 and Glossary-2
4. New or changed material is identified by a vertical bar in the margin opposite the changed material.
5. File this transmittal sheet in the front of the publication.
DISTRIBUTION RESTRICTION: Approved for public release; distribution is unlimited.
C1, FM 10-450-4/MCRP 4-23E, VOL II/NWP 3-04.12/AFJMAN 11-223, VOL II/
COMDTINST M13482.3A
HEADQUARTERS
DEPARTMENT OF THE ARMY
UNITED STATES MARINE CORPS
DEPARTMENT OF THE NAVY
DEPARTMENT OF THE AIR FORCE
Change 1
UNITED STATES COAST GUARD
Washington, DC, 1 February 2000
MULTISERVICE HELICOPTER SLING LOAD:
SINGLE-POINT RIGGING PROCEDURES
1. In this change the name US Army Natick Research, Development, and Engineering Center has been replaced
with US Army Soldiers System Center.
2. Change FM 10-450-4, 30 May 1998, as follows:
Remove old pages
Insert new pages
iii through x
iii through xi
2-1 and 2-2
2-1 and 2-2
2-21 through 2-26
2-21 through 2-26
2-47 through 2-64
3-1 through 3-4
3-1 through 3-4
3-41 through 3-52
5-1 through 5-7
5-1 through 5-7
6-13 through 6-18
6-13 through 6-18
8-1 and 8-2
8-1 and 8-2
8-77 and 8-78
8-77 through 8-82
11-1 and 11-2
11-1 and 11-2
11-5 through 11-8
11-5 through 11-8
11-15 through 11-20
12-1 and 12-2
12-1 and 12-2
12-23 and 12-24
Appendix A
Appendix A
Glossary-1 and Glossary-2
Glossary-1 and Glossary-2
References-1
References-1
3. New or changed material is identified by a vertical bar in the margin opposite the changed material.
4. File this transmittal sheet in the front of the publication.
DISTRIBUTION RESTRICTION: Approved for public release; distribution is unlimited.
*FM 10-450-4/MCRP 4-23E, VOL II/NWP 3-04.12/AFJMAN 11-223, VOL II/
COMDTINST M13482.3A
HEADQUARTERS
FIELD MANUAL 10-450-4
DEPARTMENT OF THE ARMY
MARINE CORPS REFERENCE PUBLICATION 4-23E, VOL II
UNITED STATES MARINE CORPS
NAVAL WARFARE PUBLICATION 3-04.12
DEPARTMENT OF THE NAVY
AIR FORCE JOINT MANUAL 11-223, VOL II
DEPARTMENT OF THE AIR FORCE
COMMANDANT INSTRUCTIONS M13482.2A
UNITED STATES COAST GUARD
30 May 1998, Washington, DC,
MULTISERVICE HELICOPTER SLING LOAD:
SINGLE-POINT RIGGING PROCEDURES
PREFACE
This manual is one of a series of manuals for aviation and ground personnel who perform helicopter sling load
missions ashore or aboard ship. Other manuals in this series are FM 10-450-3/MCRP 4-23E, VOL I/NWP 3-04.11/
AFJMAN 11-223, VOL I/COMDTINST M13482.2A and FM 55-450-5/FMFRP 5-31, VOL III/NWP 42-1,VOL III/
AFR 50-16, VOL III/COMDTINST M13482.4.
These manuals are a coordinated effort of the US Army, US Marine Corps, US Navy, US Air Force, and US
Coast Guard. All services participate in the sling load certification program begun by the Army in 1984. These
manuals include standardized rigging procedures and other information from that program. Chapters 2 through 14
contain rigging procedures for single-point loads which have been certified for sling load. Chapters 15 through 24
contain rigging procedures which have not been certified but have demonstrated acceptable static lift and flight
characteristics during a flight test.
Efforts were made to standardize ground crew and hookup procedures and terminology. Where service-unique
requirements apply to an entire chapter or body of text, the service initials are at the beginning of the chapter or text.
Otherwise the initials are at the end of the applicable sentence.
Rigging equipment and procedures described in this manual may not be authorized for all aircraft or services
because of equipment or service restrictions.
DISTRIBUTION RESTRICTION: Approved for public release; distribution is unlimited.
*This publication supersedes FM 55-450-4, 11 February 1991.
MARINE CORPS PCN: 14400003900
i
FM 10-450-4/MCRP 4-23E, VOL II/NWP 3-04.12/AFJMAN 11-223, VOL II/
COMDTINST M13482.3A
The proponent of this publication is HQ TRADOC. Recommendations for changes or improvement to the
manual are requested.
Army personnel submit DA Form 2028 (Recommended Changes to Publications and Blank Forms) to:
Aerial Delivery and Field Services Department
USA Quartermaster Center and School
ATTN: ADMMO
1010 Shop Road
Fort Lee, VA 23801-1502
Navy personnel submit recommended changes to:
Chief of Naval Operations
Code OP 506
Washington, DC
20350-2000
Marine Corps personnel submit user suggestion form to:
Commanding General
Marine Corps Combat Development Command
Doctrine Division C42
Quantico, VA
22134-5021
With a copy to:
Commanding General
Marine Corps Systems Command (PSE)
Quantico, VA
22134-5021
Air Force personnel submit AF Form 847 (Recommendation for Change of Publication) to:
HQ AFSOC/DOXT
Hurlburt Field, FL
32544-5273
Coast Guard personnel submit rapidraft letter (CG-3883) or AF Form 847 to:
Commandant (G-OAV)
US Coast Guard
2100 2nd Street SW
Washington, DC 20593
With a copy to:
Commander
Aviation Training Center (TRADIV)
Mobile, AL 36117
ii
C3, FM 10-450-4/MCRP 4-23E, VOL II/NWP 3-04.12/AFJMAN 11-223, VOL II/
COMDTINST M13482.3A
TABLE OF CONTENTS
Paragraph Page
PREFACE
i
CHAPTER 1
FUNDAMENTAL PRINCIPLES
Introduction
1-1
1-1
Classification Definitions of Sling Loads
1-2
1-1
Certification of Equipment for Helicopter Sling Load
1-3
1-1
Requests for Sling Load Certification
1-4
1-2
Unique Items of Equipment or Operational Requirements
1-5
1-2
Equipment Rigging Procedures
1- 6
1- 2
General Rigging Instructions
1- 7
1- 3
CHAPTER 2
CERTIFIED SINGLE-POINT RIGGING PROCEDURES FOR
WHEELED VEHICLES
Introduction
2-1
2-1
M996/M997/M997A2 Truck, Ambulance, (HMMWV)
2-2
2-1
M996/M1036/M1045/M1045A2/M1046 TOW Missile Carrier
(HMMWV), M1025/M1025A2/M1026/M1043/M1043A2/M1044
Armament Carrier (HMMWV)
2-3
2-4
M998/M1037 Modified (GVW 9,400 lbs)/M1038/M1097/M1097A2
Truck, Cargo,1 1/4-ton (HMMWV)
2-4
2-7
M1037/M1042/M1097/M1097A1/M1097A2 Shelter Carrier (HMMWV)
Without Shelter
2-5
2-10
M1037/M1042 Shelter Carrier (HMMWV) With S-250 or S-250E
Shelter
2-6
2-12
M1097 Shelter Carrier, Heavy HMMWV, With S-250 or S-250E
Shelter
2-7
2-15
M1037 Shelter Carrier (Heavy HMMWV) with Downsized Direct
Support Section (DDSS) Shelter
2-8
2-18
M1037 Shelter Carrier (HMMWV) With S-318 Shelter
2-9
2-20
M1097/M1097A2 Shelter Carrier (HMMWV) With Lightweight
Multipurpose Shelter (LMS)
2-10
2-22
M1037/M1042 Shelter Carrier (HMMWV) With Lightweight
Multipurpose Shelter (LMS)
2-11
2-26
M1037/M1097 Shelter Carrier (HMMWV) With G15840 Smoke
Generator Set, M157/M157A1E1
2-12
2-28
M998 (HMMWV) With Two MRC-127 Stacks
2-13
2-30
M998/M1038 (HMMWV) With Lightweight Tactical Fire Control
Systems (LTACFIRE)/Tactical Terminal Control System (TTCS)
2-14
2-32
M1037 (HMMWV) With AN/TPQ-36 Firefinder Generator Pallet
2-15
2-34
M1097 (H-HMMWV) With Antenna AS-3036/TSC on OA-9134/TSC
Pallet Group
2-16
2-36
iii
C3, FM 10-450-4/MCRP 4-23E, VOL II/NWP 3-04.12/AFJMAN 11-223, VOL II/
COMDTINST M13482.3A
Paragraph Page
M1097 (H-HMMWV) With High Mobility Digital Group Multiplexer
(DGM) Auxiliary Equipment Transportation Container (AETC) in
2 and 3 Mast Configurations
2-17
2-38
M1097 (H-HMMWV) With Fiberglass Cargo Bed Cover (CBC)
2-18
2-41
Light Armored Vehicle (LAV) (USMC)
2-19
2-44
M1097 (H-HMMWV) With AN/TPQ-42, Meteorological Hydrogen
Generator (MHG)
2-20
2-46
M1097/M1113 Shelter Carrier (HMMWV) With Gitchner Model
1497A Shelter
2-21
2-48
M1097 (HMMWV) With Contact Maintenance Truck, Heavy
(CMTH)
2-22
2-51
M1097 (HMMWV) With Enhanced Fiber Optic Guided Missile
(EFOGM) Launcher
2-23
2-53
M1097 (HMMWV) With Sentinel AN/MPQ-64 Tactical Quiet
Generator (TQG)
2-24
2-55
M1097A2 (HMMWV) With Secure Mobile Anti-Jam Tactical
Terminal (SMART-T) Pallet
2-25
2-57
M1097A1 (HMMWV) With Remote Landing Site Tower (RLST)
2-26
2-59
M1113 (HMMWV) With M56 Smoke Generating System
2-27
2-61
M1097A2 (HMMWV) Soft Top Truck With Advanced Field
Artillery Tactical Data Systems (AFATADS)
2-28
2-63
M1097A2 (HMMWV) with Advanced Field Artillery Tactical Data
Systems (AFATDS) Full Size Soft Top Installation Kit (STIK)
2-28.1
2-64.1
M1113 Truck, Utility, Expanded Capacity (HMMWV), With Lightweight
Multipurpose Shelter (LMS)
2-29
2-65
M1097A2 Shelter Carrier (HMMWV) With Special Operations Media
System (SOMS-B) in S-788G Shelter (LMS)
2-30
2-68
M1037 (HMMWV) With Compressed Air-Foam System, Mobile
(CAFSM)
2-31
2-71
Prophet AN/MLQ-40 (V) on M1097 HMMWV
2-32
2-73
Helmit Hardtop (Amtech Corp) Cargo Bed Cover on M1097A2
HMMWV
2-33
2-75
Interim Fast Attack Vehicle (IFAV) Truck, Long Wheel Base
2-34
2-77
John Deere M-Gator (Model # VGM6X01001)
2-35
2-79
Two John Deere M-Gators, Model # VGM6X01001, Side by Side
(Shotgun Method)
2-36
2-81
Air Traffic Navigation, Integration, and Control System (ATNAVICS)
Radar Sensor Pallet on M1113 HMMWV
2-37
2-84
Tactical Data Network (TDN) Gateway on M1097A1 HMMWV
2-38
2-86
Trojan Spirit Lite (V)2, Central Communications AN/TSQ-226 (V)2
on M1113 HMMWV
2-39
2-88
CHAPTER 3
CERTIFIED SINGLE-POINT RIGGING PROCEDURES FOR TRAILERS
Introduction
3-1
3-1
M416 1/4-Ton Trailer
3-2
3-1
M101A2/A3 3/4-Ton Trailer
3-3
3-3
M1048/M1073 Trailer
3-4
3-5
M1048 Trailer with Tracked Suspension System (TSS)
3-5
3-7
iv
C3, FM 10-450-4/MCRP 4-23E, VOL II/NWP 3-04.12/AFJMAN 11-223, VOL II/
COMDTINST M13482.3A
Paragraph Page
M149A2 Water Trailer (USMC)
3-6
3-9
M989 Heavy-Expanded Mobility Ammunition Trailer (HEMAT)
3-7
3-11
M989A1 Heavy-Expanded Mobility Ammunition Trailer (HEMAT II)
3-8
3-13
Mk14, Trailer, Container Hauler
3-9
3-15
Mk15, Trailer, Wrecker/Recovery
3-10
3-17
Mk16, Trailer, Fifth-Wheel Adapter
3-11
3-19
Mk17, Trailer, Drop-Side, Cargo
3-12
3-21
M116A2 Trailer with Antenna Groups, AS-3954/TRC
(2 each) (USMC)
3-13
3-23
M116A2 Trailer with AN/TPQ-36 Firefinder Antenna Transceiver
Group (ATG)
3-14
3-25
M116A2 Trailer with M894 18,000-BTU Air Conditioner and
MEP-003A Generator
3-15
3-27
MKT-90/MKT-95/MKT-99 Field Kitchen Trailer
3-16
3-29
Hydraulic System Test and Repair Unit (HSTRU)
3-17
3-31
M116A2 Trailer, Single Channel Objective Tactical Terminal (SCOTT)
3-18
3-33
High Mobility Trailers (HMT), M1101/M1102
3-19
3-35
M116A3 Trailer with OE334 Antenna Coupler Group
3-20
3-37
Desert Operation Trailer (DOT) with Desert Operation Motorcycle
(DOM)
3-21
3-39
HMT Trailer With Sentinel AN/MPQ-64 Antenna Transmitter
Group (ATG)
3-22
3-41
HMT Trailer With Remote Landing Site Tower (RLST)
3-23
3-43
M105A3 Trailer
3-24
3-45
M332 Ammunition Trailer, 1 1/2-Ton
3-25
3-47
AS-4492/TSC, Lightweight, High Gain, X-band, Antenna
(LHGXA) Trailer
3-26
3-49
XM1112 400 Gallon Water Trailer
3-27
3-51
M1082 Light Medium Tactical Vehicle (LMTV) and M1095 Medium
Tactical Vehicle (MTV) Trailers
3-28
3-53
Small Portable Expeditionary Aeromedical Rapid Response (SPEARR)
Trailer
3-29
3-55
Minimum Operating Strip Lighting System (MOSLS)
3-30
3-57
Assault Command Post With High Mobility Wheel Set
3-31
3-59
Trailer Support System with Expeditionary Shelter
3-32
3-61
Shadow Tactical Unmanned Aerial Vehicle (TUAV), Launcher/
Recovery Trailer (L/RT)
3-33
3-63
CHAPTER 4
CERTIFIED SINGLE-POINT RIGGING PROCEDURES FOR
TRAILERS WITH MOUNTED GENERATORS
Introduction
4-1
4-1
M353 Trailer Chassis With Mounted Generators
4-2
4-1
M200A1 Trailer-Mounted Power Units, Generators, and Power Plants
4-3
4-3
M103A3 Trailer-Mounted Power Units, Generators, and Power Plants
4-4
4-7
M103A3/A4 Trailer-Mounted Power Units, Generators, and Power
Plants
4-5
4-9
M116A2 Trailer-Mounted Power Units, Generators, and Power Plants
4-6
4-11
v
C3, FM 10-450-4/MCRP 4-23E, VOL II/NWP 3-04.12/AFJMAN 11-223, VOL II/
COMDTINST M13482.3A
Paragraph Page
M116A3 Trailer-Mounted Power Units, Generators, and Power Plants
4-7
4-13
High Mobility Trailer (HMT) with AN/TJQ-35A Power Plant
4-8
4-15
High Mobility Trailer (HMT) with Tactical Quiet Generator
Power Units
4-9
4-17
High Mobility Trailers (HMT) with Generator for Joint Surveillance
Target Attack Radar (JSTAR) System
4-10
4-19
CHAPTER 5
CERTIFIED SINGLE-POINT RIGGING PROCEDURES FOR
TRUCK AND TOWED COMBINATIONS
Introduction
5-1
5-1
M973/M973E1/M1065/M1066 Small Unit Support Vehicle (SUSV)
5-2
5-1
M1067 Flatbed Small Unit Support Vehicle (SUSV)
5-3
5-5
CHAPTER 6
CERTIFIED SINGLE-POINT RIGGING PROCEDURES FOR
HOWITZERS AND WEAPONS SYSTEMS
Introduction
6-1
6-1
M101A1 105-MM Howitzer with or without A-22 Cargo Bags
6-2
6-1
M102 105-MM Howitzer
6-3
6-4
M102 105-MM Howitzer with One A-22 Cargo Bag
6-4
6-6
M102 105-MM Howitzer with Two or Three A-22 Cargo Bags
6-5
6-8
Two M102 105-MM Howitzers
6-6
6-10
Two M102 105-MM Howitzers with One, Two, or Three
A-22 Cargo Bags
6-7
6-12
M119 105-MM Howitzer, Folded/Towed Position
6-8
6-14
M119 105-MM Howitzer, Forward/Firing Position
6-9
6-16
M114A2 155-MM Howitzer, Towed
6-10
6-19
M119 105-MM Howitzer, Forward Firing Position, Platform Down
with Additional Boxes of Ammunition
6-9.1
6-18.1
M198 155-MM Howitzer, Towed/Stowed
6-11
6-21
Two M101A1 155-MM Howitzers
6-12
6-23
M167 20-MM AA Gun (Vulcan) with or without One A-22 Cargo Bag
6-13
6-26
BMS-120 Battalion Mortar System
6-14
6-28
XM777, 155-mm, Lightweight Howitzer
6-15
6-30
CHAPTER 7
CERTIFIED SINGLE-POINT RIGGING PROCEDURES FOR
GUIDED MISSILE SYSTEMS
Introduction
7-1
7-1
M54A1/M54A2 Chaparral Launch Station
7-2
7-1
M85 Towed Chaparral Missile System
7-3
7-3
Continuous Wave Acquisition Radar (CWAR)
7-4
7-5
M192E1/M192-1 Zero Length Launcher
7-5
7-7
M501E3 Loader-Transporter, Guided Missile
7-6
7-9
M1E2 Loading and Storage Missile Pallet
7-7
7-11
Pedestal-Mounted Stinger (Avenger)
7-8
7-13
vi
C3, FM 10-450-4/MCRP 4-23E, VOL II/NWP 3-04.12/AFJMAN 11-223, VOL II/
COMDTINST M13482.3A
Paragraph Page
Pedestal-Mounted Stinger on M1097/M1097A1/M1097A2 HMMWV
(Avenger) with ECU/PPU and an Aluminum Airlift Bumper with or
without Bustle Box Stowed on the Roof
7-9
7-15
CHAPTER 8
CERTIFIED SINGLE-POINT RIGGING PROCEDURES FOR
ENGINEER EQUIPMENT
Introduction
8-1
8-1
T-3 Tractor, Crawler
8-2
8-1
D5B Tractor, Dozer
8-3
8-3
Tractor, Full-Tracked, MC 1150E
8-4
8-5
Tractor, Wheeled, Industrial, Case Model 580
8-5
8-7
Small Emplacement Excavator (SEE)
8-6
8-9
High Mobility Materiel Handler (HMMH)
8-7
8-11
Ditching Machine
8-8
8-13
950BS Scoop Loader
8-9
8-15
130GS Grader
8-10
8-19
613BS Scraper, Elevating
8-11
8-21
613WDS Water Distributor
8-12
8-24
Roller, Towed, Vibrating
8-13
8-27
Mk155 Launcher, Mine Clearing
8-14
8-29
M68A2 Line Charge, Demolition with or without Mk22 Rocket Motor
8-15
8-31
Mk155 Launcher with or without M68A2 Demolition Line Charge
and Mk22 Rocket Motor on M353 Trailer
8-16
8-33
Mk155 Launcher with or without M68A2 Demolition Line Charge
and Mk22 Rocket Motor on M200A1 or Mobile-Trac System
(MTS) Trailer
8-17
8-35
LRT-110, 7 1/2-Ton Crane
8-18
8-37
LRT-110, 7 1/2-Ton Crane (Boom)
8-19
8-39
LRT-110, 7 1/2-Ton Crane (Power Unit)
8-20
8-41
Truck, Forklift, MC-4000
8-21
8-43
Truck, Forklift, RT4000
8-22
8-45
MHE-270/MHE-271 Truck, Forklift, RT4000
8-23
8-47
Truck, Forklift, MC-6000
8-24
8-49
Extendable Boom Forklift (EBFL)
8-25
8-51
Extendable Boom Forklift (EBFL) (New Version)
8-25.1
8-52.1
Light Rough Terrain Forklift (LRTF)
8-25.2
8-52.3
Welding Shop on M200A1 Trailer
8-26
8-53
250 CFM Air Compressor
8-27
8-55
Pneumatic Tool and Compressor Outfit/Hydraulic Pioneer Tool
Outfit (PTO) on M353 Trailer
8-28
8-57
Fuel Dispensing System, Tactical Airfield (TAFDS)
8-29
8-59
Bath Unit Mounted on the M103 Trailer
8-30
8-61
Boat, Bridge Erection
8-31
8-63
Bridge, Medium Girder, Dry Gap (MGB)
8-32
8-65
Ribbon Bridge Ramp Bay
8-33
8-67
Ribbon Bridge Interior Bay
8-34
8-69
Water Purification Unit-Reverse Osmosis (ROWPU)
8-35
8-71
MS114 WFD Concrete Mixer
8-36
8-73
vii
C3, FM 10-450-4/MCRP 4-23E, VOL II/NWP 3-04.12/AFJMAN 11-223, VOL II/
COMDTINST M13482.3A
Paragraph Page
Towed Rollers
8-37
8-75
Tractor (Dozer), Full-Tracked, Type III, JD450G
8-38
8-77
Vibrating Roller, Caterpillar, RO-33
8-39
8-79
Countermine Miniflail
8-40
8-81
Bobcat 863 Skid-Steer Loader
8-41
8-83
CHAPTER 9
CERTIFIED SINGLE-POINT RIGGING PROCEDURES FOR
LIQUID CONTAINERS
Introduction
9-1
9-1
Lightweight Collapsible Fabric Tank
9-2
9-1
One to Four 500-Gallon Fuel Drums
9-3
9-3
Six 500-Gallon Fuel Drums, Empty
9-4
9-6
Storage Module, Fuel/Water, Six Compartment Container (SIXCON),
Individual
9-5
9-8
Two Storage Modules, Fuel/Water, Six Compartment Container
(SIXCON), (Stacked)
9-6
9-10
CHAPTER 10
CERTIFIED SINGLE-POINT RIGGING PROCEDURES FOR
SHELTERS
Introduction
10-1
10-1
AN/ASM-146 or AN/MSM-108 Electronic Shops
10-2
10-1
Communications or Electronic Systems Housed in S-250 Shelters
10-3
10-3
Communications or Electronic Systems Housed in Lightweight
Multipurpose Shelter (LMS)
10-4
10-5
Communications or Electronic Systems Housed in S-280 Shelters
10-5
10-7
8- x 8- x 10-Foot Shelter Systems
10-6
10-10
Downsized Digital Group Multiplexer (DDGM) Shelter Assemblages
10-7
10-12
AN/TYC-5A Data Communications Terminal
10-8
10-14
AN/TRN-44 Tactical Air Navigation Shelter
10-9
10-16
Hardened Army Tactical Shelter (HATS)
10-10
10-18
Cradle Mounted AN/TPQ-32A Radar Set, Component of the
AN/MPQ-49A Forward Area Alerting Radar (FAAR) System
10-11
10-20
NATO Air Base Satcom (NABS) Shelter Pallet, AN/TSC-93B (V) 2
10-12
10-22
Refrigerator, Rigid Box without Refrigerator Unit
10-13
10-24
CHAPTER 11
CERTIFIED SINGLE-POINT RIGGING PROCEDURES FOR
CONTAINERS
Introduction
11-1
11-1
Pershing II in Container
11-2
11-1
Shipping/Storage Containers
11-3
11-3
Army Missile Systems Enclosure Assembly Launch Pods (EALP),
One Container
11-4
11-5
Army Missile Systems Enclosure Assembly Launch Pods (EALP),
Two Containers
11-5
11-7
viii
C3, FM 10-450-4/MCRP 4-23E, VOL II/NWP 3-04.12/AFJMAN 11-223, VOL II/
COMDTINST M13482.3A
Paragraph Page
M1A1 Full-Up Power Pack (FUPP) Container
11-6
11-9
Field Medical Oxygen Generation/Distribution System (FMOGDS)
11-7
11-11
Field Medical Oxygen Generation/Distribution System
(FMOGDS) (Combined)
11-8
11-13
Distributed Explosive Technology (DET) System, Array Container
11-9
11-15
Distributed Explosive Technology (DET) System, Landing Craft,
Air Cushioned (LCAC), Landing Interface Kit (LIK) Container, Single ... 11-10
11-17
Distributed Explosive Technology (DET) System, Landing Craft, Air
Cushioned (LCAC), Interface Kit (LIK) Container, Doubled, Stacked
11-11
11-19
Quadcons
11-12
11-21
CHAPTER 12
CERTIFIED SINGLE-POINT RIGGING PROCEDURES FOR
RADAR AND SATELLITE EQUIPMENT
Introduction
12-1
12-1
AN/TPQ-37 Artillery-Loading Radar Set (Firefinder)
12-2
12-1
AN/TMQ-31 Radio Direction Finder
12-3
12-4
AN/TPQ-36 Firefinder Antenna Radar Set
12-4
12-6
AN/TPQ-36 Firefinder II
12-5
12-8
OE-361/G Quick Reaction Satellite Antenna
12-6
12-11
AS-3471/TPN-22 Antenna Pallet (USMC)
12-7
12-13
Antenna Pallet Transit Frame
12-8
12-15
Digital Group Multiplexer (DGM), Digital Antenna Mast Program
(DAMP), 2 and 3 Antenna Pallet Configurations
12-9
12-17
Digital Group Multiplexer (DGM), Auxiliary Equipment
Transportation Container (AETC), 2 and 3 Mast Configurations
12-10
12-19
Lightweight Generator Frame Assembly (AN/TSC-93B
Reconfiguration) Satellite Communications Terminal
12-11
12-21
Secure Mobile Anti-Jam Tactical Terminal (SMART-T) Pallet
12-12
12-23
CHAPTER 13
CERTIFIED SINGLE-POINT RIGGING PROCEDURES FOR
GENERATOR SETS
Introduction
13-1
13-1
Aviation Ground Power Unit (AGPU)
13-2
13-1
Aviation Direct Current Generator Set (ADCGS)
13-3
13-4
Skid Mounted Generators
13-4
13-6
MEP112A Generator Pallet
13-5
13-8
NATO Air Base Satcom (NABS) Power Pallet AN/TSC-85 (V) 2
13-6
13-10
Skid Mounted Tactical Quiet Generator Sets
13-7
13-12
CHAPTER 14
CERTIFIED SINGLE-POINT RIGGING PROCEDURES FOR
MISCELLANEOUS EQUIPMENT
Introduction
14-1
14-1
Forward Area Refueling Equipment (FARE)
14-2
14-1
Fire Extinguisher, Dry Chemical
14-3
14-3
Rigid Raiding Craft
14-4
14-5
ix
C3, FM 10-450-4/MCRP 4-23E, VOL II/NWP 3-04.12/AFJMAN 11-223, VOL II/
COMDTINST M13482.3A
Paragraph Page
2.75-inch Rocket Fastpack Pallet
14-5
14-7
Special Divers Air Support System (SDASS)
14-6
14-9
Two Mobile Oversnow Transport (MOST) Snowmobiles with or
without Two Sleds
14-7
14-11
Container Roll-in/out Platform (CROP), Two Empty Platforms, Stacked ... 14-8
14-13
Special Operations Craft-Riverine (SOC-R) and Naval Special Warfare
Rigid Inflatable Boat (NSWRIB) Trailer
14-9
14-15
CHAPTER 15
SUITABLE SINGLE-POINT RIGGING PROCEDURES FOR
WHEELED VEHICLES
Introduction
15-1
15-1
M342A2 2 1/2-Ton Dump Truck with Winch
15-2
15-1
M35A1/2 2 1/2-Ton Cargo Truck with Winch
15-3
15-3
M54A2 5-Ton Cargo Truck with Winch
15-4
15-5
M52A2 or M818 5-Ton Tractor with Winch
15-5
15-7
Crane, Self-Propelled, for Army Aircraft Maintenance and
Positioning (SCAMP)
15-6
15-9
CHAPTER 16
SUITABLE SINGLE-POINT RIGGING PROCEDURES FOR
TRAILERS
Introduction
16-1
16-1
M105 1 1/2-Ton Trailer
16-2
16-1
M270A1 Semitrailer, Wrecker
16-3
16-3
M172A1 Semitrailer, Lowbed
16-4
16-5
Trailer, Flatbed, Tilt Deck, 15-Ton, 8-Wheel
16-5
16-7
Trailer-Mounted Welding Shop
16-6
16-9
LEB 300 Welding Machine on 2 1/2-Ton Trailer Chassis
16-7
16-11
Trailer-Mounted Compressor, Reciprocating
16-8
16-13
Trailer-Mounted AN/MTC-10
16-9
16-15
Trailer-Mounted Tool Outfit
16-10
16-17
Trailer-Mounted, Lube, Service Unit
16-11
16-19
Trailer, Bolster, M796
16-12
16-21
M149 Series Water Trailers
16-13
16-23
CHAPTER 17
SUITABLE SINGLE-POINT RIGGING PROCEDURES FOR
HOWITZERS
Introduction
17-1
17-1
M114A1 155-MM Howitzer with or without Accompanying Load
17-2
17-1
CHAPTER 18
SUITABLE SINGLE-POINT RIGGING PROCEDURES FOR
ENGINEER EQUIPMENT
Introduction
18-1
18-1
MRS-100 Wheeled Industrial Tractor
18-2
18-1
M5 8-Foot Aggregate Spreader
18-3
18-3
x
C3, FM 10-450-4/MCRP 4-23E, VOL II/NWP 3-04.12/AFJMAN 11-223, VOL II/
COMDTINST M13482.3A
Paragraph Page
Roller, Towed, Vibrating, 1-Drum, 5-Ton, VRS55TM
18-4
18-5
Roller, Road, Towed, Wheeled, 13-Tire, 9-Ton
18-5
18-7
Tar Kettles
18-6
18-9
16SM Concrete Mixer
18-7
18-11
Road Sweeper, Towed
18-8
18-13
Sheepsfoot Roller, Two-Drum, MD-96
18-9
18-15
Model 1150 Full Tracked Tractor
18-10
18-17
M4K 4000-Pound Forklift
18-11
18-20
Floodlight Set, Trailer-Mounted
18-12
18-22
CHAPTER 19
SUITABLE SINGLE-POINT RIGGING PROCEDURES FOR
LIQUID CONTAINERS
Introduction
19-1
19-1
Tank, Fabric, Collapsible, 10,000-Gallon
19-2
19-1
60,000-Gallon Fuel System Supply Point
19-3
19-3
One to Six 250-Gallon Water Drums
19-4
19-5
CHAPTER 20
SUITABLE SINGLE-POINT RIGGING PROCEDURES FOR
SHELTERS
Introduction
20-1
20-1
Tool Set Aviation Maintenance, SE 1, Airmobile
20-2
20-1
Shop, Portable, Aircraft Maintenance (SPAM)
20-3
20-3
CHAPTER 21
SUITABLE SINGLE-POINT RIGGING PROCEDURES FOR
CONTAINERS
Introduction
21-1
21-1
One CONEX Container
21-2
21-1
Two CONEX Containers
21-3
21-3
CHAPTER 22
SUITABLE SINGLE-POINT RIGGING PROCEDURES FOR
RADAR EQUIPMENT
Introduction
22-1
22-1
AN/MPQ-4A Radar Set
22-2
22-1
CHAPTER 23
SUITABLE SINGLE-POINT RIGGING PROCEDURES FOR
GENERATOR SETS
Introduction
23-1
23-1
Trailer Mounted Generators
23-2
23-1
7.5KW Generator Set
23-3
23-3
xi
C3, FM 10-450-4/MCRP 4-23E, VOL II/NWP 3-04.12/AFJMAN 11-223, VOL II/
COMDTINST M13482.3A
Paragraph Page
CHAPTER 24
SUITABLE SINGLE-POINT RIGGING PROCEDURES FOR
MISCELLANEOUS EQUIPMENT
Introduction
24-1
24-1
Company Level Field Feeding Kit
24-2
24-1
350-GPM Pump Assembly
24-3
24-4
Light Tactical Floating Raft Bridge
24-4
24-6
Medium-Span Bridge
24-5
24-11
M4T6 Bridge
24-6
24-13
APPENDIX A. NATIONAL STOCK NUMBERS FOR SLINGS, NETS, AND
SPARE PARTS
A-1
APPENDIX B. SLING CONVERSION CHART
B-1
GLOSSARY
Glossary-1
REFERENCES
References-1
xii
C2, FM 10-450-4/MCRP 4-23E, VOL II/NWP 3-04.12/AFJMAN 11-223, VOL II/
COMDTINST M13482.3A
CHAPTER 1
FUNDAMENTAL PRINCIPLES
1-1. INTRODUCTION
CAUTION
This chapter contains general information about certifica-
Loads weighing less than 6,000 pounds may
tion for helicopter sling load and explains the role of the
not fly in a stable condition and may incur jet-
Military Traffic Management Command Transportation
tisoning problems when flown under a CH-53E
Engineering Agency (MTMCTEA) and the Department
helicopter. CH-53E units may have restrictions
of Defense (DOD) sling load certification authority. This
on flying light loads. Direct coordination with
authority rests with the US Army Soldier Systems Center
CH-53E units is encouraged.
(SSC). This chapter also explains the information con-
tained in the equipment rigging procedures and gives some
general rigging instructions.
b. Suitable Sling Loads. Suitable sling loads are those
items of equipment and their associated rigging proce-
1-2. CLASSIFICATION DEFINITIONS OF SLING
dures that have not been certified but have demonstrated
LOADS
acceptable static lift and flight characteristics during a
flight test. In most cases these loads were not pull tested
a. Certified Sling Loads. Certified sling loads are those
in accordance with MIL STD 913, but are known loads
items of equipment and their associated rigging proce-
which have been flown without incident for years and
dures which have completed the evaluation and testing
which SSC considers to be proven safe. These rigging
required by SSC for sling load certification. These rig-
procedures are in Chapters 15 through 24.
ging procedures are in Chapters 2 through 14. Only certi-
fied sling loads are authorized for the Marine Corps. The
c. Unique Sling Loads. Unique loads are equipment
US Army SSC has indicated that any single point sling
carried on a one time or low-frequency basis, such as
load certified under a specific aircraft is also certified for
telephone poles, artillery targets, or barrier material. The
any aircraft with suitable lift capability. The following
lack of sling load certification in itself does not preclude a
restrictions apply for sling load certification to remain in
unit commander from carrying a load that is not certified.
effect:
Each service is responsible for determining its policy on
carrying loads that have not been certified for sling load.
(1) The load must be within the lifting capability of
the desired helicopter model and not exceed the rated ca-
d. Prohibited Sling Loads. Prohibited sling loads are
pacity of the sling set being used.
items of equipment that are prohibited from sling loading
as determined by each service. These loads have been
(2) The load shall be rigged in accordance with the
denied sling load certification and are a safety hazard if
certified rigging procedure.
carried. They have either structural deficiencies or have
exhibited unstable flight characteristics during flight test-
(3) The recommended stable airspeed specified for
ing. Each service will identify these loads and transmit
the load in the applicability section of the rigging proce-
this information by separate list. Contact your service point
dure is a recommendation and not a restriction, unless so
of contact identified in the Preface if you have any ques-
stated.
tions regarding the classification of a particular load.
(4) This certification is limited to single-point loads
1-3. CERTIFICATION OF EQUIPMENT FOR
only.
HELICOPTER SLING LOAD
NOTE: When carrying loads at weights close to the air-
a. Objective. The objective of helicopter sling load
craft hook limitations, close coordination with the avia-
certification is to assure the user that the equipment being
tion unit is required.
transported can withstand the stresses of a sling load
1-1
C2, FM 10-450-4/MCRP 4-23E, VOL II/NWP 3-04.12/AFJMAN 11-223, VOL II/
COMDTINST M13482.3A
flight environment. Certification for sling load assures
Command, ATTN: QM Combat Developments, Suite 250,
the user that the item has met minimum standards for struc-
3901 A Avenue, Fort Lee, VA 23801-1809.
tural integrity and that the associated rigging procedures
have been developed specifically for that item.
(2) US Marine Corps - Commanding General, Marine
Corps System Command (PSE) Quantico, VA 22134-5021.
b. Responsibilities. Within the US Army, the
MTMCTEA is responsible for transportability approval
(3) US Navy - Naval Air Systems Command (NAVAIR).
of developmental equipment. Within the DOD, SSC is the
lead activity responsible for providing sling load certifica-
(4) US Air Force - US Air Force Systems Command.
tion and rigging procedures for military equipment. When
b. Previously Certified Dual-Point Loads. Loads can-
an item is certified for sling load, it means that SSC, in
not be certified for dual-point lift based on previously
cooperation with various test activities, has:
certified dual-point rigging procedures because of the dif-
(1) Conducted an engineering analysis of the load
ferences in dual hook helicopters, such as the distance
and lifting provisions for structural adequacy during sling
between the two cargo hooks. Rigging procedures for
loading.
dual-point loads must be developed and/or approved by
SSC before the test flight.
(2) Verified that the lift provisions meet the strength
requirements of the applicable military standard by means
1-5. UNIQUE ITEMS OF EQUIPMENT OR
of proof load testing.
OPERATIONAL REQUIREMENTS
(3) Developed and/or validated sling load rigging
Helicopter sling loading of unique items, due to opera-
procedures through static lift testing.
tional requirements, will be at the discretion of the
commander. Equipment not listed in this manual should
(4) Evaluated flight reports and determined that the
be static lifted (when possible) by a crane to determine
particular load meets acceptable flight characteristics with
proper rigging and stability characteristics. Personnel
the type helicopter flown during the flight test.
thoroughly familiar with sling load rigging procedures
should assist in the static lift testing. Flight evaluating
(5) Issued a statement of sling load certification for
may be conducted after a satisfactory static rigging con-
the particular load, including load configuration(s),
figuration has been determined.
weight(s), types of helicopter(s), and recommended
airspeed(s) as attained during the flight evaluation(s). Cer-
NOTE: Low density equipment with low weight and large
tification is valid only for the conditions specified in the
surface area (flat surfaces), such as shelters, empty trail-
rigging procedures.
ers, pallet loads, boat shaped items, and empty fuel or
water drums, are likely to become extremely unstable
1-4. REQUESTS FOR SLING LOAD CERTIFI-
when flown during sling load operations, even at low air-
CATION
speeds, and should be flown with extreme caution.
a. Fielded Equipment. Each service headquarters must
1-6. EQUIPMENT RIGGING PROCEDURES
designate, request, and prioritize the fielded equipment to
be evaluated by SSC for sling load certification. Individual
This section explains the information that is contained in
units can request sling load certification for fielded equip-
the rigging procedures for each load. Chapters 2 through
ment through the appropriate service agency which will
14 contain the rigging procedures for certified single-point
add the item to the prioritized list. The SSC will evaluate
loads and chapters 15 through 24 contain the rigging pro-
the equipment on a priority basis. The following agencies
cedures for suitable single-point loads.
are responsible for their branch of service:
a. Applicability Paragraph. The applicability paragraph
(1) US Army - Commander, Combined Arms Support
states whether a load is “certified” or “suitable” for sling
1-2
C2, FM 10-450-4/MCRP 4-23E, VOL II/NWP 3-04.12/AFJMAN 11-223, VOL II/
COMDTINST M13482.3A
load. It also contains the helicopter types and recom-
d. Rigging. The rigging steps give information as to the
mended airspeeds for each helicopter type.
position of the apex fitting on the load, routing orientation
For certified loads, this airspeed is the maximum airspeed
of the sling legs, location of the lift provisions, chain link
attained by the helicopter during the evaluation flight
number for each sling leg, and steps required to prevent
before the load became unstable or before the aircraft power
the sling legs from becoming entangled on the load. Do
requirements were exceeded. For suitable loads, the maxi-
not change the chain link number in the rigging proce-
mum recommended airspeed is based on previous experi-
dures under any circumstances as it may change sling leg
ence with this helicopter/load combination. For either
loading and cause lift provision failure.
certified or suitable loads, the airspeed listed is a recom-
(1) The purpose of the illustration accompanying the
mendation and not a restriction, unless so stated. The
rigging procedures is to depict what a properly rigged
aircrew should closely monitor the load during the flight,
load looks like with the slack removed from the sling legs.
especially if the helicopter exceeds the recommended air-
The arrow identifies the direction of flight.
speed.
(2) Appendix A contains NSN component listings for
b. Load Description. The load description paragraph
slings, sling sets, cargo nets, and other miscellaneous
identifies the load, model, national stock number (NSN) or
equipment and materials.
other identification, and the weight of the load for certifi-
cation.
e. Hookup. Certain sling loads, such as HMMWVs with
shelters, present substanial risk of damage to the load or
(1) The actual weight of the equipment may vary some-
injury to the hookup personnel. This risk is increased
what from the actual rigged weight during the flight evalu-
during dual point hookup or night operations.
ation due to equipment modifications, fuel, equipment
added to the load, or different models of the same item.
(1) To reduce the risk of damage to the load or injury
The load weight on the equipment data plate or in the
to the hookup personnel an extended sling system or reach
operator’s manual takes precedence over the load weight
pendant as defined in FM 10-450-3 may be used.
in this manual. Weigh the load if there is any doubt about
its actual weight. If the load weight exceeds the weight
(2) Using a reach pendant increases the distance be-
listed in the load description paragraph, the load becomes
tween the load and the helicopter. Reach pendants should
a unique load. Contact your service point of contact if
not be used on loads that have a tendancy to spin during
you have any questions about the load description or
flight. A static discharge person is not required when
weight.
using a reach pendant.
(2) Equipment such as cargo trailers and cargo trucks
contain descriptions of the allowable additional cargo
(3) If the tactical environment permits the use of an
weight. Do not exceed the fully loaded weight. Some
extended sling set may reduce the risk. Polyester round
trailers become extremely unstable at low weights; there-
slings are recommended for use as vertical pendants.
fore, a minimum weight is identified. If your trailer is be-
low that weight, add more cargo or dummy weight as close
1-7. GENERAL RIGGING INSTRUCTIONS
to the center of the trailer as possible until you reach the
minimum weight.
CAUTION
Inspect lifting provisions and supporting struc-
c. Preparation. The preparation steps are intended to
ture for damage or degradation prior to sling
reduce the possibility of damage to the equipment caused
loading. Do not transport loads with damaged
by sling leg entanglement during the hookup and lift-off
or degraded lift provisions.
operation or by wind resistance encountered during the
flight. Since these preparation steps are not directive in
nature, the commander assumes responsibility for any
a. Preparing the Load. Prepare the load to be trans-
damage to the equipment caused by deviation from the
ported by following the preparation and rigging instruc-
preparation steps.
tions for each item. Typical preparation instructions will
1-3
C2, FM 10-450-4/MCRP 4-23E, VOL II/NWP 3-04.12/AFJMAN 11-223, VOL II/
COMDTINST M13482.3A
provide information to secure loose items, remove or se-
(d) Sling leg 4 to the right rear lifting provision.
cure canvas covers, and remove obstructions, such as
antennas. Place protective padding on windshields and
(2) If a six-leg sling set is required, the innermost sling
other components that could be damaged by the metal
legs, 5 and 6, are connected to the left and right middle lift
parts of the sling set during hookup or release. The load
provisions.
should be secure enough to withstand winds in excess of
120 knots caused by the forward airspeed of the aircraft.
NOTE: Odd numbered sling legs go to the same side of
If possible, position the load in the takeoff direction so
the load.
the pilot does not have to pick the load up and then turn
the aircraft into the takeoff direction.
(3) Following the equipment rigging procedures, loop
the free end of the chain end through the lift provision
b. Preparing the Equipment. Inspect and assemble the
and insert the specified chain link in the grabhook/grab
slings and miscellaneous equipment required to prepare
link. Tie or tape the excess chain end to prevent the unre-
and rig the load. Following the instructions in Chapter 6
strained chain from damaging the load. If necessary, wrap
of FM 10-450-3/MCRP 4-23E, VOL I/NWP 3-04.11/
padding around the chain or rope assembly to prevent
AFJMAN 11-223, VOL I/COMDTINST M13482.2A, add
damage to the load or sling set. If the procedures pre-
or remove sling legs, chains, or apex fittings as required.
scribe a spreader bar, install and pad it according to the
Never exceed the capacity of the sling legs or apex fitting/
rigging instructions.
web ring. If you have a sling set with a higher capacity
than the sling set prescribed, use the chain link conver-
(4) Breakaway safety ties are used to temporarily re-
sion chart in Appendix B to determine the corresponding
strain the sling legs to keep them from becoming
chain link for your sling set.
entangled on the load as the helicopter lifts the load.
These safety ties are made of Type I, 1/4-inch cotton web-
c. Positioning and Attaching the Sling Set. Position
bing or duct tape.
the sling set near the load. The sling legs for a typical load
d. Viewing the Load. Left, right, front, and rear direc-
with four lifting points are routed as shown in Figure 1-1.
tions are designated from the driver’s perspective for ve-
hicles and towed equipment. Howitzer gun tubes are con-
(1) Rigging a typical load with four lifting points
sidered the front of the load. The front or rear is identified

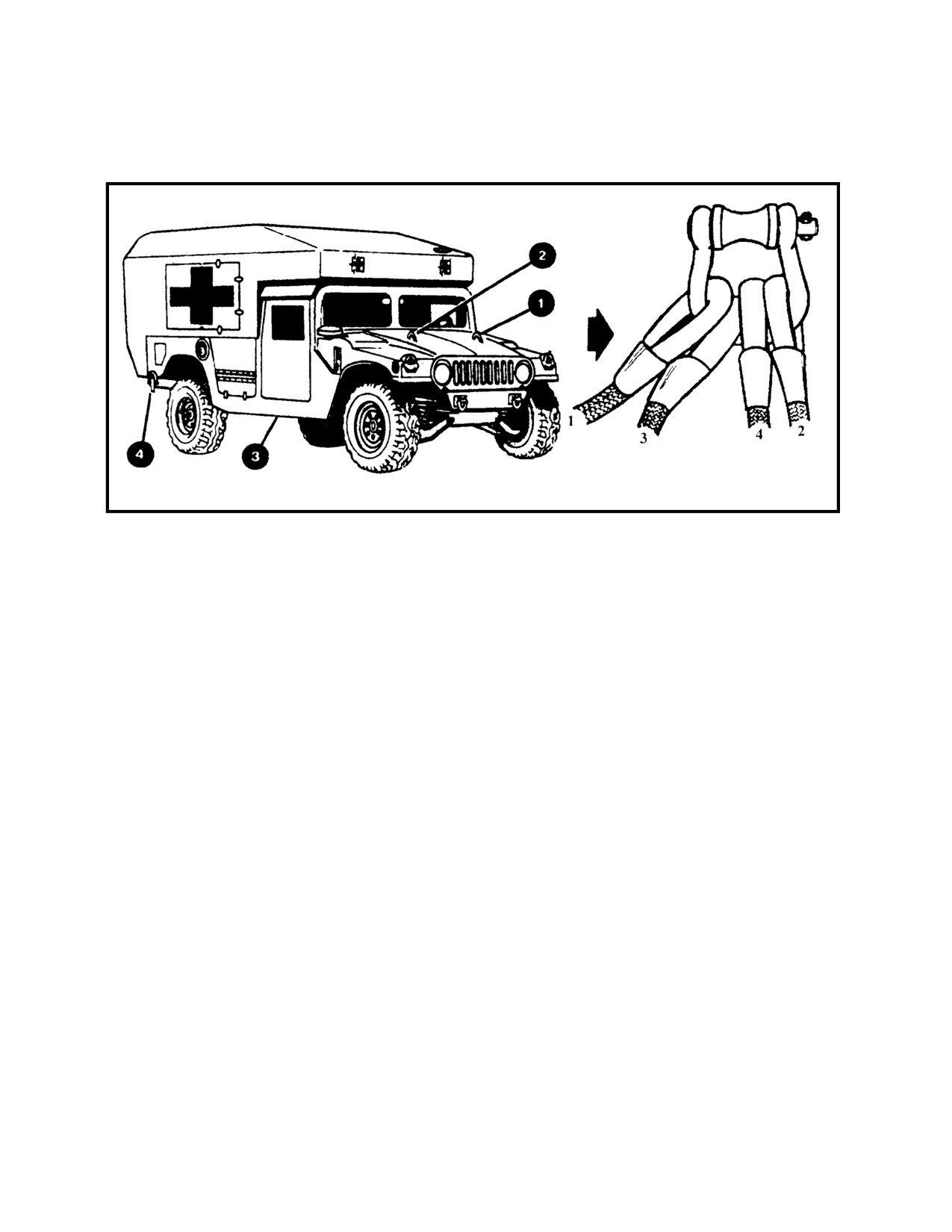

is begun by connecting -
on other items of equipment. The sling leg numbering
system prevents sling legs from crossing each other and
(a) Sling leg 1 to the left front lifting provision.
causing damage to the sling legs or causing the load to
twist in flight. To improve flight stability, some loads are
(b) Sling leg 2 to the right front lifting provision.
transported backwards. Do not confuse the front of the
load as it is carried with the end designated as the front for
(c) Sling leg 3 to the left rear lifting provision.
rigging purposes. The arrow shown in the illustration
identifies the direction of flight.
1-4
C2, FM 10-450-4/MCRP 4-23E, VOL II/NWP 3-04.12/AFJMAN 11-223, VOL II/
COMDTINST M13482.3A
Figure 1-1. Sling Leg Lifting Point Designation
1-5
C3, FM 10-450-4/MCRP 4-23E, VOL II/NWP 3-04.12/AFJMAN 11-223, VOL II/
COMDTINST M13482.3A
CHAPTER 2
CERTIFIED SINGLE-POINT RIGGING PROCEDURES FOR WHEELED VEHICLES
2-1. INTRODUCTION
This chapter contains rigging procedures for single-point
wheeled vehicle loads that have been certified for sling
NOTES:
load. Each rigging procedure is found in a paragraph that
1. Reach Pendants may be used on all single
includes a description of the load, materials required for
point loads. A static discharge person is not required
rigging, and steps to complete the procedure. An applica-
when using a Reach Pendant.
bility paragraph is also a part of each paragraph and iden-
tifies the certified loads. The certified single-point rigging
2. Canvas tops and doors should be removed and
procedures for wheeled vehicles are in this section. Para-
stowed inside the vehicle if time allows. These items may
graphs 2-2 through 2-39 give detailed instructions for rig-
be damaged if the airspeed exceeds 100 knots.
ging loads.
2-2. M996/M997/M997A2 Truck, Ambulance, (HMMWV)
a. Applicability. The following items in Table 2-1 are certified for all helicopters with suitable lift capacity by the US
Army Soldier Systems Center:
Table 2-1. Truck, Ambulance, (HMMWV)
MAX
RECOMMENDED
LINK COUNT
NOMENCLATURE
WEIGH T
SLING SET
AIRSPEE D
FRONT/REA R
(POUNDS )
(KNOTS )
UH-60 /
60
Truck, Ambulance, M996, HMMW V
7,400
10K
8
/
CH-47 /
11
0
UH-60 /
80
Truck, Ambulance, M997, HMMW V
7,400
10K
8
/
CH-47 /
75
Truck, Ambulance, M997A2, HMMW V
10,300
25K
6
/
CH-47 / 75
b. Materials. The following materials are required to rig
(4) Cord, nylon, Type III, 550-pound breaking strength.
this load:
(5) Webbing, cotton, 1/4-inch, 80-pound breaking
(1) Sling set (10,000-pound capacity).
strength.
OR
(6) Spreader bar assembly (component of vehicle).
c. Personnel. Two persons can prepare and rig this
(2) Sling set (25,000-pound capacity).
load in 15 minutes.
(3) Tape, adhesive, pressure-sensitive, 2-inch wide
roll.
2-1
C3, FM 10-450-4/MCRP 4-23E, VOL II/NWP 3-04.12/AFJMAN 11-223, VOL II/
COMDTINST M13482.3A
d. Procedures. The following procedures apply to
(i) Remove the keeper from the spreader bar and
this load:
extend the bar so the holes line up. Reinstall pin and
engage keeper. Use the sighting hole in the tube to assist
(1) Preparation. Prepare the load using the following
in aligning holes for the pin. See top view insert in Figure
steps:
2-1.
(a) Fold the mirrors forward in front of the wind-
(j) Position the spreader bar across the rear end of
shield and tie together with Type III nylon cord. Tape the
the vehicle roof. Attach the spreader bar check cables to
windshield in an X formation from corner to corner.
the eyebolts located on the aft exterior sidewall of the rear

compartment. See rear view insert in Figure 2-1.
(b) Remove the spreader bar from under the right-
hand seat inside the ambulance.
(k) Install lift provisions on the outer ends of the
rear bumper by removing the tie-down provisions located
(c) Secure all equipment inside the rear compart-
inboard of the bumper ends and installing them on the
ment with tape, nylon cord, and/or lashings. Close and
outer ends of the rear bumper, if necessary.
secure the door.
(2) Rigging. Rig the load according to the steps in
(d) Secure all other equipment inside the vehicle
Figure 2-1.
with tape, nylon cord, and/or lashings. Close and secure
the doors.
NOTE: Hookup of this load presents substantial risk
of damage to the load or injury to the hookup personnel.
(e) Make sure the fuel tank is not over 3/4 full. In-
Use of a reach pendant is recommended for this load.
spect fuel tank cap, oil filler cap, and battery caps for
proper installation.
(3) Hookup. The hookup team stands on the roof of
the vehicle. The static wand person discharges the static
(f) Engage the vehicle parking brake. Place the trans-
electricity with the static wand. The hookup person places
mission in neutral.
the apex fitting onto the aircraft cargo hook. The hookup
team then carefully dismounts the vehicle and remains
(g) Make sure that the front wheels are pointed
close to the load as the helicopter removes slack
straight ahead. Tie down the steering wheel using the
from the sling legs. When successful hookup is assured,
securing device attached under the dashboard.
the hookup team quickly exits the area underneath the
helicopter to the designated rendezvous point.
(h) Secure the Red Cross insignia covers in the closed
position.
(4) Derigging. Derigging is the reverse of the prepa-
ration and rigging procedures in steps d (1) and d (2).
2-2
FM 10-450-4/MCRP 4-23E, VOL II/NWP 3-04.12/AFJMAN 11-223, VOL II/
COMDTINST M13482.3A
RIGGING STEPS
front of the check cable eyebolts.
1. Position apex fitting on top of the ambulance. Route
outer sling legs 1 and 2 to the front of the vehicle and
4. The rear lift provisions are located on the outer
inner sling legs 3 and 4 to the rear. Sling legs 1 and 3
ends of the rear bumper. Loop the chain end of sling leg
must be on the left side of the load.
3 through the left rear lift provision. Place the correct
link from Table 2-1 in the grab hook. Repeat with sling
2. Loop the chain end of sling leg 1 through the left
leg 4 and the right rear lift provision.
front lift provision that protrudes through the hood. Place
the correct link from Table 2-1 in the grab hook. Repeat
5. Secure all excess chain with tape or Type III nylon
with sling leg 2 and the right front lift provision.
cord.
3. Place the nylon rope of sling legs 3 and 4 in the
6. Cluster and tie or tape (breakaway technique) all
guides on the ends of the spreader bar. Attach the
sling legs together on top of the vehicle to prevent en-
spreader bar guide retainer pins and keepers. Lay the
tanglement during hookup and lift-off.
spreader bar on the roof. Make sure the sling legs are in

Figure 2-1. M996/M997/M997A2 Ambulance (HMMWV)
CAUTION
Do not use the lift shackles located near the center of the rear bumper for sling load lift
provisions.
2-3
FM 10-450-4/MCRP 4-23E, VOL II/NWP 3-04.12/AFJMAN 11-223, VOL II/
COMDTINST M13482.3A
2-3. M966/M1036/Ml045/M1045A2/M1046 TOW Missile Carrier (HMMWV)
M1025/M1025A2/M1026/M1043/M1043A2/M1044 Armament Carrier (HMMWV)
a. Applicability. The following items in Table 2-2 are certified for all helicopters with suitable lift capacity by the
US Army Natick Research, Development, and Engineering Center:
Table 2-2. TOW Missile/Armament Carrier, (HMMWV)
MAX
RECOMMENDED
LINK COUNT
NOMENCLATURE
WEIGHT
SLING SET
AIRSPEED
FRONT/REAR
(POUNDS)
(KNOTS)
10K
80/3
CH-47 / 90
TOW Missile Carrier, HMMWV,
Varies by
15K
60/3
CH-53 See Note 1
M966/M1036/M1045/M1046
Model
40K
53/3
UH-60 See Note 2
TOW Missile Carrier, HMMWV,
CH-47 / 90
10,300
25K
65/5
M1045A2
CH-53 See Note 1
10K
80/3
CH-47 / 90
Armament Carrier, HMMWV,
Varies by
15K
60/3
CH-53 See Note 1
M1025/M1026/M1043/M1044
Model
40K
53/3
UH-60 See Note 2
Armament Carrier, HMMWV,
CH-47 / 90
10,300
25K
65/5
M1025A2/M1043A2
CH-53 See Note 1
(2) Multileg sling set (15,000-pound capacity or
NOTES:
40,000-pound capacity).
1. Recommended airspeed for CH-53E when using
(3) Tape, adhesive, pressure-sensitive, 2-inch wide
the 15,000-pound multileg sling set is 80 knots. Rec-
roll.
ommended airspeed for the CH-53E when using the
40,000-pound capacity sling set is 95 knots.
(4) Cord, nylon, Type III, 550-pound breaking
strength.
2. For vehicle weights up to 7,300 pounds, the recom-
mended maximum airspeed for the UH-60 is 100 knots.
(5) Webbing, cotton, 1/4-inch, 80-pound breaking
For loads weighing above 7,300 pounds the recommended
strength.
maximum airspeed is 70 knots. Coordinate closely with
the aviation unit as to the vehicle weight including all
(6) Felt sheet, cattle hair, Type IV, 1/2-inch or suit-
gear carried on the vehicle.
able padding.
c. Personnel. Two persons can prepare and rig this
b. Materials. The following materials are required to
load in 15 minutes.
rig this load:
d. Procedures. The following procedures apply to
(1) Sling set (10,000-pound capacity or 25,000-
this load:
pound capacity).
OR
2-4
FM 10-450-4/MCRP 4-23E, VOL II/NWP 3-04.12/AFJMAN 11-223, VOL II/
COMDTINST M13482.3A
(1) Preparation. Prepare the load using the
transmission in neutral.
following steps:
(e) Ensure the front wheels are pointed straight ahead.
Tie down the steering wheel, using the securing device
(a) Fold mirrors forward in front of the windshield
attached under the dashboard.
for added protection and tie together with Type III ny-
lon cord. If installed, remove canvas covering over the
(2) Rigging. Rig the load according to the steps in
Figure 2-2.
bed of the truck. Remove the doors. Tape the windshield
in an X formation from corner to corner. If time permits,
(3) Hookup. The hookup team stands on the roof of
fold canvas top and tie to windshield for added protec-
the vehicle. The static wand person discharges the static
tion.
electricity with the static wand. The hookup person
places the apex fitting onto the aircraft cargo hook. The
(b) Secure all equipment and cargo inside the ve-
hookup team then carefully dismounts the vehicle and
hicle with tape, nylon cord, or lashings. Remove anten-
remains close to the load as the helicopter removes slack
nas and stow inside vehicle.
from the sling legs. When successful hookup is assured,
the hookup team quickly exits the area underneath the
(c) Ensure the fuel tank is not over 3/4 full.
helicopter to the designated rendezvous point.
Inspect fuel tank cap, oil filler cap, and battery caps for
proper installation.
(4) Derigging. Derigging is the reverse of the prepa-
ration and rigging procedures in steps d (1) and d (2).
(d) Engage the vehicle parking brake and put the
2-5
FM 10-450-4/MCRP 4-23E, VOL II/NWP 3-04.12/AFJMAN 11-223, VOL II/
COMDTINST M13482.3A
RIGGING STEPS

1.
Position apex fitting on the roof of the vehicle.
let opening in the upper left corner of the tailgate. Loop
Route outer sling legs 1and 2 to the front of the vehicle
the chain end through the left lift provision on the bumper
and inner sling legs 3 and 4 to the rear. Sling legs 1 and
and thread back through the eyelet opening in the tail-
3 must be on the left side of the load.
gate. Place the correct link from Table 2-2 in the grab
hook. Repeat with sling leg 4 and the right rear lift provi-
2. Loop the chain end of sling leg 1 through the left
sion. See insert above.
front lift provision that protrudes through the hood. Place
the correct link from Table 2-2 in the grab hook. Repeat
4. Wrap rear chains with padding where they contact
with sling leg 2 and the right front lift provision. Secure
the shell back.
excess chain with tape or Type III nylon cord.
5. Cluster and tie or tape (breakaway technique) all
3. Route the chain end of sling leg 3 through the eye-
sling legs together on top of the vehicle to prevent en-
tanglement during hookup and lift-off.
Figure 2-2. TOW Missile Carrier (HMMWV)
2-6
C3, FM 10-450-4/MCRP 4-23E, VOL II/NWP 3-04.12/AFJMAN 11-223, VOL II/
COMDTINST M13482.3A
2-4. M998/M1037 Modified (GVW 9,400 lbs)/M1038/M1097/M1097A2 Truck, Cargo,
1 1/4-ton (HMMWV)
a. Applicability. The following items in Table 2-3 are certified for all helicopters with suitable lift capacity by the US
Army Natick Soldier Systems Center:
Table 2-3. 1 1/4-Ton Cargo Truck (HMMWV)
M AX
RECOMMENDED
LINK COUNT
NOMENCLATURE
WEIGH T
SLING SET
AIRSPEE D
FRONT/REA R
(POUNDS )
(KNOTS )
10K
8
/
CH-47 /
90
Truck, 1 1/4-ton, HMMWV ,
7,700
15K
6
/
CH-53 See Not
e
1
M998/M1038
40K
5
/
UH-60 See Not
e
2
10K
8
/
CH-47 /
90
Truck, 1 1/4-ton, HMMWV M998
A1
7,500
15K
6
/
CH-53 See Not
e
1
40K
5
/
UH-60 See Not
e
2
10K
8
/
CH-47 /
90
Truck, 1 1/4-ton, HMMWV , M998 wih
7,700
15K
6
/
CH-53 See Not
e
1
AN/MRC110-A Radio Set
40K
5
/
UH-60 See Not
e
2
Truck, 1 1/4-ton, HMMWV Modifie
d
,
10K
8
/
9,400
90
(GVW 9,400
l
15K
6
/
Truck, 1 1/4-ton, Heavy HMMWV ,
10,001
25K
6
/
90
Cargo Variant, M1097
Truck, 1 1/4-ton, Heavy HMMWV ,
10,300
25K
6
/
90
Cargo Variant, M1097A
2
Integrated System Control (ISYSCON),
Support Carrier/Radio,Truck, 1 1/4-ton,
10,300
25K
6
/
90
Heavy HMMWV , M1097.
WARNING
THIS CARGO VEHICLE (M1037 MODIFIED, 9,400-LB GVW) SHOULD NOT BE CONFUSED WITH THE
SHELTER CARRIER (M1037, 8,600-LB GVW). THE M1037 MODIFIED HAS IMPROVED LIFT PROVISIONS
WHICH ALLOWS IT TO BE LIFTED AT HIGHER GROSS VEHICLE WEIGHTS.
NOTES:
1. Recommended airspeed for CH-53E when using the 15,000-pound multileg sling set is 100 knots. Recommended
airspeed for the CH-53E when using the 40,000-pound capacity sling set is 105 knots.
2. For vehicle weights up to 7,300 pounds, the recommended maximum airspeed for the UH-60 is 100 knots. For
loads weighing above 7,300 pounds the recommended maximum airspeed is 70 knots. Coordinate closely with the
aviation unit as to the vehicle weight including all gear carried on the vehicle.
2-7
C3, FM 10-450-4/MCRP 4-23E, VOL II/NWP 3-04.12/AFJMAN 11-223, VOL II/
COMDTINST M13482.3A
b. Materials. The following materials are required to
If installed, remove canvas covering over the bed of the
rig this load:
truck. Remove the doors. Tape the windshield in an X
formation from corner to corner. If time permits, fold can-
(1) Sling set (10,000-pound capacity or 25,000-pound
vas top and tie to windshield for added protection.
capacity for the UH-60 and CH-47).
(b) Secure all equipment and cargo inside the vehicle
OR
with tape, nylon cord, or lashings. Remove antennas and
stow inside vehicle.
(2) Multileg sling set (15,000-pound capacity or
40,000-pound capacity for the CH-53E only).
(c) Ensure the fuel tank is not over 3/4 full. Inspect
fuel tank cap, oil filler cap, and battery caps for proper
installation.
(3) Tape, adhesive, pressure-sensitive, 2-inch wide
roll.
(d) Engage the vehicle parking brake and put the
transmission in neutral.
(4) Cord, nylon, Type III, 550-pound breaking strength.
(e) Ensure the front wheels are pointed straight ahead.
Tie down the steering wheel, using the securing device
(5) Webbing, cotton, 1/4-inch, 80-pound breaking
attached under the dashboard.
strength.
(2) Rigging. Rig the load according to the steps in
(6) Felt sheet, cattle hair, Type IV, 1/2-inch or suitable
Figure 2-3.
padding.
(3) Hookup. The hookup team stands in the bed of the
vehicle. The static wand person discharges the static
c. Personnel. Two persons can prepare and rig this
electricity with the static wand. The hookup person places
load in 15 minutes.
the apex fitting onto the aircraft cargo hook. The hookup
team then carefully dismounts the vehicle and remains
d. Procedures. The following procedures apply to
close to the load as the helicopter removes slack
this load:
from the sling legs. When successful hookup is assured,
the hookup team quickly exits the area underneath the
(1) Preparation. Prepare the load using the
helicopter to the designated rendezvous point.
following steps:
(4) Derigging. Derigging is the reverse of the prepa-
(a) Fold mirrors forward in front of the windshield for
ration and rigging procedures in steps d (1) and d (2).
added protection and tie together with Type III nylon cord.
2-8
C2, FM 10-450-4/MCRP 4-23E, VOL II/NWP 3-04.12/AFJMAN 11-223, VOL II/
COMDTINST M13482.2
RIGGING STEPS
1. Position apex fitting in the bed of the vehicle. Route
3. Route the chain end of sling leg 3 through the eyelet
outer sling legs 1and 2 to the front of thevehicle and inner
opening in the upper left corner of the tailgate. Loop the
sling legs 3 and 4 to the rear. Sling legs 1 and 3 must be on
chain end through the left lift provision on the bumper
the left side of the load.
and thread back through the eyelet opening in the tail-
gate. Place the correct link from Table 2-3 in the grab
2. Loop the chain end of sling leg 1 through the left
hook. Repeat with sling leg 4 through the right rear lift
front lift provision that protrudes through the hood from
provision. See insert above.
inboard to outboard. Place the correct link from Table 2-3
in the grab hook. Repeat with sling leg 2 through the right
4. Cluster and tie or tape (breakaway technique) all sling
front lift provision. Secure excess chain with tape or Type
legs together on top of the trailer to prevent entanglement
III nylon cord.
during hookup and lift-off.
Figure 2-3. 1 1/4-Ton Cargo Truck (HMMWV)
2-9
C2, FM 10-450-4/MCRP 4-23E, VOL II/NWP 3-04.12/AFJMAN 11-223, VOL II/
COMDTINST M13482.2
2-5. M1037/M1042/M1097/M1097A1/M1097A2 Shelter Carrier (HMMWV) Without
Shelter
a. Applicability. The following items in Table 2-4 are certified for all helicopters with suitable lift capacity by the US
Army Soldier Systems Center:
Table 2-4. M1037/M1042/M1097/M1097A1/M1097A2 Shelter Carrier (HMMWV) Without Shelter
M AX
RECOMMENDED
LINK COUNT
NOMENCLATURE
WEIGH T
SLING SET
AIRSPEE D
FRONT/REA R
(POUNDS )
(KNOTS )
15K
Shelter Carriers, M1037/M1042
5,220
6
/
100
10K
Shelter Carriers, M1097/M1097A
1
10,000
10K
6
/
100
Shelter Carriers, M1097A
2
10,300
25K
5
/
100
b. Materials. The following materials are required to
added protection and tie together with Type III nylon cord.
rig this load:
Tape the windshield in an X formation from corner to cor-
ner.
(1) Multileg sling set (15,000-pound capacity or 40,000-
pound capacity for CH-53 only).
(b) Secure all equipment and cargo inside the vehicle
with tape, nylon cord, or lashings. Secure the doors shut
OR
if installed.
(2) Sling set (10,000-pound capacity or 25,000-pound
(c) Ensure the fuel tank is not over 3/4 full. Inspect
capacity for CH-60 and CH-47).
the fuel tank cap, oil filler cap, and battery caps for proper
installation.
(3) Tape, adhesive, pressure-sensitive, 2-inch wide
roll.
(d) Engage the vehicle parking brake and place the
transmission in neutral.
(4) Cord, nylon, Type III, 550-pound breaking strength.
(e) Ensure the front wheels are in pointed straight
(5) Webbing, cotton, 1/4-inch, 80-pound breaking
ahead. Tie down the steering wheel using the securing
strength.
device attached under the dashboard.
(6) Felt sheet, cattle hair, Type VI, 1/2-inch or suitable
(f) Install the lift provisions on the outer ends of the
substitute.
rear bumper by removing the tiedown provisions located
inboard of the bumper end and installing them on the
c. Personnel. Two persons can prepare and rig this
outer ends of the rear bumper.
load in 15 minutes.
(2) Rigging. Rig the load according to the steps in
d. Procedures. The following procedures apply to
Figure 2-4.
this load:
(3) Hookup. The hookup team stands in the bed of
the vehicle. The static wand person discharges the static
(1) Preparation. Prepare the load using the following
electricity with the static wand. The hookup person places
steps:
the apex fitting onto the aircraft cargo hook. The hookup
team then carefully dismounts the vehicle and remains
(a) Fold mirrors forward in front of the windshield for
2-10
C2, FM 10-450-4/MCRP 4-23E, VOL II/NWP 3-04.12/AFJMAN 11-223, VOL II/
COMDTINST M13482.2
close to the load as the helicopter removes slack from the
(4) Derigging. Derigging is the reverse of the prepa-
sling legs. When successful hookup is assured, the
ration and rigging procedures in steps d (1) and d (2).
hookup team quickly exits the area underneath the heli-
copter to the designated rendezvous point.
RIGGING STEPS
1. Position apex fitting in the bed of the vehicle. Route
provision located on the left end of the bumper from in-
outer sling legs 1and 2 to the front of thevehicle and inner
board to outboard. Place the correct link from Table 2-4 in
sling legs 3 and 4 to the rear. Sling legs 1 and 3 must be on
the grab hook. Repeat with sling leg 4 through the right
the left side of the load.
rear lift provision. Secure excess chain with tape or Type
III nylon cord.
2. Loop the chain end of sling leg 1 through the left
front lift provision that protrudes through the hood from
4. Wrap rear chains with padding where they contact
inboard to outboard. Place the correct link from Table 2-4
the shelter carrier.
in the grab hook. Repeat with sling leg 2 through the right
front lift provision. Secure excess chain with tape or Type
5. Cluster and tie or tape (breakaway technique) all sling
III nylon cord.
legs together on top of the trailer to prevent entanglement
during hookup and lift-off.
3. Route the chain end of sling leg 3 through the lift
Figure 2-4. M1037/M1042/M1097/M1097A1/M1097A2 Shelter Carrier (HMMWV) Without Shelter
2-11
C2, FM 10-450-4/MCRP 4-23E, VOL II/NWP 3-04.12/AFJMAN 11-223, VOL II/
COMDTINST M13482.2
2-6. M1037/M1042 Shelter Carrier (HMMWV) With S-250 or S-250E Shelter
a. Applicability. The following items in Table 2-5 are certified for all helicopters with suitable lift capacity by the US
Army Natick Research, Development, and Engineering Center:
Table 2-5. Shelter Carrier (HMMWV) With S-250 or S-250E Shelter
M AX
RECOMMENDED
SHELTER VARIANT
LINK COUNT
WEIGH T
SLING SET
AIRSPEE D
NOMENCLA TUR E
FRONT/REA R
(POUNDS )
(KNOTS )
NC Opera
i
8,800
10K
8
/
110
NC Sw
t
8,513
10K
8
/
100
NC LOS (V3)
8,611
10K
8
/
100
NC Management
8,800
10K
8
/
100
NC Support Ve
i
8,400
10K
8
/
100
LEN Operations
8,800
10K
8
/
100
LEN Switch
8,800
10K
8
/
100
LEN LOS (V4)
8,800
10K
8
/
100
LEN Management
8,800
10K
8
/
100
LEN Cable Vehicle
8,180
10K
8
/
100
SCC Command
8,800
10K
8
/
100
SCC Plan
i
8,300
10K
8
/
100
SCC Tech
i
8,507
10K
8
/
100
LOS (V1)
8,800
10K
8
/
100
LOS (V2)
8,500
10K
8
/
100
Radio Access Unit
8,800
10K
8
/
100
SEN (V1)
8,800
10K
8
/
100
SEN (V2)
8,800
10K
8
/
100
Maintenance
#1
8,084
10K
8
/
100
Maintenance
#2
8,350
10K
8
/
100
2-12
FM 10-450-4/MCRP 4-23E, VOL II/NWP 3-04.12/AFJMAN 11-223, VOL II/
COMDTINST M13482.3A
Table 2-5. Shelter Carrier (HMMWV) With S-250/S-250E Shelter (Continued)
MAX
RECOMMENDED
SHELTER VARIANT
LINK COUNT
WEIGHT
SLING SET
AIRSPEED
NOMENCLATURE
FRONT/REAR
(POUNDS)
(KNOTS)
Battalion Spares
8,800
10K
80/30
100
Company Spares
7,850
10K
80/30
100
AN/TLQ-17A (V3)
8,040
10K
80/30
100
Deployable Media Production Center
7,840
10K
80/30
120
Operational Control Group (OCG) /
7,500
10K
80/30
100
Firefinder AN/TPQ-36 (V) Block IIB
TLQ-37 Intelligence and Electronic
8,200
10K
80/30
100
Warfare (IEW) System
b. Materials. The following materials are required to
(1) Preparation. Prepare the load using the
rig this load:
following steps:
(1) Sling set (10,000-pound capacity).
(a) Connect one additional chain length to each
chain of the sling set with the coupling link.
(2) Chain length, part number 38850-00053-101, from
a 10,000-pound capacity sling set (4 each).
(b) Fold mirrors forward in front of the windshield for
added protection and tie together with Type III nylon cord.
(3) Coupling link, part number 577-0615, from a
Tape the windshield in an X formation from corner to cor-
10,000-pound sling set (4 each).
ner.
(4) Tape, adhesive, pressure-sensitive, 2-inch wide
(c) Secure the shelter to the truck using wire rope
roll.
or tie-down assemblies. Secure all equipment inside the
shelter with tape, nylon cord, or lashings; close and se-
(5) Cord, nylon, Type III, 550-pound breaking strength.
cure the door.
(6) Webbing, cotton, 1/4-inch, 80-pound breaking
(d) Secure all equipment and cargo inside the vehicle
strength.
with tape, nylon cord, or lashings. Secure the doors shut
if installed.
(7) Felt sheet, cattle hair, Type IV, 1/2-inch or suitable
padding.
(e) Ensure the fuel tank is not over 3/4 full.
Inspect fuel tank cap, oil filler cap, and battery caps for
(8) Padding, Cellulose.
proper installation.
c. Personnel. Two persons can prepare and rig this
(f) Engage the vehicle parking brake and put the
load in 15 minutes.
transmission in neutral.
d. Procedures. The following procedures apply to
(g) Ensure the front wheels are pointed straight
this load:
ahead. Tie down the steering wheel, using the securing
2-13
FM 10-450-4/MCRP 4-23E, VOL II/NWP 3-04.12/AFJMAN 11-223, VOL II/
COMDTINST M13482.3A
RIGGING STEPS
1. Position apex fitting on top of the shelter. Route
inboard to outboard. Place the correct link from Table 2-5
outer sling legs 1and 2 to the front of the vehicle and inner
in the grab hook. Repeat with sling leg 4 and the right rear
sling legs 3 and 4 to the rear. Sling legs 1 and 3 must be on
lift provision. Secure excess chain with tape or Type III
the left side of the load.
nylon cord.
2. Loop the chain end of sling leg 1 through the left
4. Wrap the rear slings with padding where they contact
front lift provision that protrudes through the hood from
the shelter sides.
inboard to outboard. Place the correct link from Table 2-5
in the grab hook. Repeat with sling leg 2 and the right
5. Raise the apex fitting above the shelter carrier keep-
front lift provision. Secure excess chain with tape or Type
ing the slings to the side of the shelter.
III nylon cord.
6. Cluster and tie or tape (breakaway technique) all sling
3. Route the chain end of sling leg 3 through the lift
legs together on top of the shelter to prevent entangle-
provision located on the left end of the rear bumper from
ment during hookup and lift-off.
Figure 2-5. M1037/1042 Shelter Carrier with S-250/S-250E Shelter
CAUTION
Do not use the lift shackles located near the center of the rear bumper for sling load lift
provisions.
2-14
C2, FM 10-450-4/MCRP 4-23E, VOL II/NWP 3-04.12/AFJMAN 11-223, VOL II/
COMDTINST M13482.2
(h) Install the lift provisions on the outer ends of the
(3) Hookup. The hookup team stands on top of the
rear bumper by removing the tiedown provisions located
shelter. The static wand person discharges the static elec-
inboard of the bumper end and installing them on the
tricity with the static wand. The hookup person places
outer ends of the rear bumper.
the apex fitting onto the aircraft cargo hook. The hookup
team then carefully dismounts the vehicle and remains
(2) Rigging. Rig the load according to the steps in
close to the load as the helicopter removes slack from the
Figure 2-5.
sling legs. When successful hookup is assured, the
hookup team quickly exits the area underneath the heli-
NOTE: Hookup of this load presents substantial risk
copter to the designated rendezvous point.
of damage to the load or injury to the hookup personnel.
Use of a reach pendant is recommended for this load.
(4) Derigging. Derigging is the reverse of the prepa-
ration and rigging procedures in steps d (1) and d (2).
2-7. M1097 Shelter Carrier, Heavy HMMWV, With S-250 or S-250E Shelter
a. Applicability. The following items in Table 2-6 are certified for all helicopters with suitable lift capacity by the US
Army Soldier Systems Center:
Table 2-6. Shelter Carrier, (Heavy HMMWV), With S-250/S-250E Shelter
MAX
SLING
LINK COUNT
RECOMMENDED
NOMENCLATURE
WEIGH T
SET
FRONT / REA R
AIRSPEED (KNOTS )
(POUNDS )
S-250/S-250E
10,001
25K
6
/
120
AN/TRC-170 Communication
9,240
15K
4
/
130
Shelter
TRQ-32, Intelligence and Electronic
9,700
10K
6
/
120
Warfare (IEW) System
PlatoonOperationsCe
t
Intelligence and Electronic Warfare
9,700
10K
6
/
120
(IEW) System
Mobile Subscriber Equipment
Contingency Communica
i
9,993
10K
6
/
120
Package/Light Forces Contingency
Communications Package
i
Mobile Subscriber Equipment
Contingency Communica
i
8,913
10K
6
/
120
Package/Light Forces Contingency
Communications Package
i
LOS (V1)
9,038
10K
6
/
120
LOS (V2)
9,038
10K
6
/
120
LOS (V3)
9,038
10K
6
/
120
LOS (V4)
9,038
10K
6
/
120
NODAL Support Ve
i
8,250
10K
6
/
120
2-15
C2, FM 10-450-4/MCRP 4-23E, VOL II/NWP 3-04.12/AFJMAN 11-223, VOL II/
COMDTINST M13482.2
shield in an X formation from corner to corner.
NOTE: All certified shelters in paragraph 2-6 (M1037/
M1042 Shelter Carrier, HMMWV, With S-250/S-250E
(c) Secure the shelter to the truck using wire rope
Shelter) are certified for sling loading on the M1097
or tie-down assemblies. Secure all equipment inside the
Shelter Carrier with an increased maximum weight of
shelter with tape, nylon cord, or lashings; close and se-
300 pounds.
cure the door.
b. Materials. The following materials are required to
(d) Secure all equipment and cargo inside the vehicle
rig this load:
with tape, nylon cord, or lashings. Secure the doors shut
if installed.
(1) Sling set (10,000-pound capacity or 25,000-
pound capacity).
(e) Ensure the fuel tank is not over 3/4 full.
OR
Inspect fuel tank cap, oil filler cap, and battery caps for
(2) Multileg sling set (15,000-pound capacity for the
proper installation.
CH-53E only).
(f) Engage the vehicle parking brake and put the
(a) Additional chain lengths from the sling set
transmission in neutral.
being used (4 each).
(g) Ensure the front wheels are pointed straight
(b) Additional coupling links from the sling set
ahead. Tie down the steering wheel, using the securing
being used (4 each).
device attached under the dashboard.
(3) Tape, adhesive, pressure-sensitive, 2-inch wide
(h) Install the lift provisions on the outer ends of the
roll.
rear bumper by removing the tiedown provisions located
(4) Cord, nylon, Type III, 550-pound breaking strength.
inboard of the bumper end and installing them on the
outer ends of the rear bumper.
(5) Webbing, cotton, 1/4-inch, 80-pound breaking
strength.
(i) When using the multileg sling set, attach an addi-
tional chain length to the end of the chain on each sling
(6) Felt sheet, cattle hair, Type IV, 1/2-inch or suitable
leg with the coupling link.
padding.
(2) Rigging. Rig the load according to the steps in
(7) Padding, Cellulose.
Figure 2-6.
c. Personnel. Two persons can prepare and rig this
NOTE: Hookup of this load presents substantial risk
load in 15 to 25 minutes.
of damage to the load or injury to the hookup personnel.
Use of a reach pendant is recommended for this load.
d. Procedures. The following procedures apply to
this load:
(3) Hookup. The hookup team stands on top of the
shelter. The static wand person discharges the static elec-
(1) Preparation. Prepare the load using the following
tricity with the static wand. The hookup person places
steps:
the apex fitting onto the aircraft cargo hook. The hookup
team then carefully dismounts the vehicle and remains
(a) Connect one additional chain length
close to the load as the helicopter removes slack from the
to each chain of the sling set with the
sling legs. When successful hookup is assured, the
coupling link.
hookup team quickly exits the area underneath the heli-
copter to the designated rendezvous point.
(b) Fold mirrors forward in front of the windshield
and tie together with Type III nylon cord. Tape the wind-
(4) Derigging. Derigging is the reverse of the prepara-
tion and rigging procedures in steps d (1) and d (2).
2-16
FM 10-450-4/MCRP 4-23E, VOL II/NWP 3-04.12/AFJMAN 11-223, VOL II/
COMDTINST M13482.3A
RIGGING STEPS
1. Position apex fitting on top of the shelter. Route
inboard to outboard. Place the correct link from Table 2-6
outer sling legs 1and 2 to the front of the vehicle and inner
in the grab hook. Repeat with sling leg 4 and the right rear
sling legs 3 and 4 to the rear. Sling legs 1 and 3 must be on
lift provision. Secure excess chain with tape or Type III
the left side of the load.
nylon cord.
2. Loop the chain end of sling leg 1 through the left
4. Wrap the rear slings with padding where they contact
front lift provision that protrudes through the hood from
the shelter sides.
inboard to outboard. Place the correct link from Table 2-6
in the grab hook. Repeat with sling leg 2 and the right
5. Raise the apex fitting above the shelter carrier keep-
front lift provision. Secure excess chain with tape or Type
ing the slings to the side of the shelter.
III nylon cord.
6. Cluster and tie or tape (breakaway technique) all sling
3. Route the chain end of sling leg 3 through the lift
legs together on top of the shelter to prevent entangle-
provision located on the left end of the rear bumper from
ment during hookup and lift-off.
Figure 2-6. M1097 Shelter Carrier with S-250/S-250E Shelter
CAUTION
Do not use the lift shackles located near the center of the rear bumper for sling load lift
provisions.
2-17
FM 10-450-4/MCRP 4-23E, VOL II/NWP 3-04.12/AFJMAN 11-223, VOL II/
COMDTINST M13482.3A
2-8. M1037 Shelter Carrier (Heavy HMMWV) With Downsized Direct Support Section
(DDSS) Shelter
a. Applicability. The following item in Table 2-7 is certified for all helicopters with suitable lift capacity by the US Army
Natick Research, Development, and Engineering Center:
Table 2-7. Downsized Direct Support Section Shelter
MAX
RECOMMENDED
LINK COUNT
NOMENCLATURE
WEIGHT
SLING SET
AIRSPEED
FRONT/REAR
(POUNDS)
(KNOTS)
Downsized Direct Support Section
8,030
10K
70/3
100
(DDSS)
b. Materials. The following materials are required to
(a) Connect one additional chain length
rig this load:
to each chain of the sling set with the
coupling link.
(1) Sling set (10,000-pound capacity).
(b) Fold mirrors forward in front of the windshield for
(2) Chain length, part number 38850-00053-101, from
added protection and tie together with Type III nylon cord.
a 10,000-pound capacity sling set (4 each).
(c) Secure the shelter to the truck using wire rope
(3) Coupling link, part number 577-0615, from a
or tie-down assemblies.
10,000-pound sling set (4 each).
(d) Remove the ladder from the rear of the shelter.
(4) Tape, adhesive, pressure-sensitive, 2-inch wide
Secure the ladder inside the shelter. Secure all equipment
roll.
inside the shelter with tape, nylon cord, or lashings; close
and secure shelter vents and door with nylon cord or
(5) Cord, nylon, Type III, 550-pound breaking strength.
tape.
(6) Webbing, cotton, 1/4-inch, 80-pound breaking
(e) Secure all equipment and cargo inside the vehicle
strength.
with tape, nylon cord, or lashings. Secure the doors shut
if installed.
(7) Felt sheet, cattle hair, Type IV, 1/2-inch or suitable
padding.
(f) Ensure the fuel tank is not over 3/4 full.
Inspect fuel tank cap, oil filler cap, and battery caps for
(8) Padding, Cellulose.
proper installation.
c. Personnel. Two persons can prepare and rig this
(g) Engage the vehicle parking brake and put the
load in 15 minutes.
transmission in neutral.
d. Procedures. The following procedures apply to
(h) Ensure the front wheels are pointed straight
this load:
ahead. Tie down the steering wheel, using the securing
device attached under the dashboard.
(1) Preparation. Prepare the load using the
following steps:
(i) Tape the windshield in an X formation from cor-
ner to corner.
2-18

Content      ..      1       2         ..

///////////////////////////////////////
